Breadcrumb

SoCal OASIS™ Park

With a focus on sustainability, innovation and social inclusion, the SoCal OASIS™ Park is a center for research in climate change, air quality and mobility aimed at preparing the next generation of the Clean Tech workforce for Riverside and the Inland Empire.  Located along University Avenue between downtown and the UC Riverside campus, the SoCal OASIS™ Park is a catalyst project along Riverside’s ‘Innovation Corridor’ while also acting as a gateway to the UC Riverside campus.  The project is a collaboration between UC Riverside’s Bourns College of Engineering Center for Environmental Research and Technology (CE-CERT), Office of Innovation and Entrepreneurship, and the University Extension to provide a space where university research intersects with local entrepreneurs and future clean tech workers.

With a total site area of approximately 4 acres, the project will provide approximately 39,000 Sq. Ft of research and office space and will include clean tech labs along with a maker space for prototyping new technologies.  The project includes several community-oriented spaces, such as office space for local entrepreneurs, a large active-hybrid meeting and learning space, display space to share research being conducted and ample outdoor areas for shared community use.  The SoCal OASIS™ Park intends to create a welcoming, transparent and accessible space for all members of the community.  The project fronts University Avenue with a landscaped plaza and draws people into the site through a multimodal pedestrian and bicycle corridor that connects University Avenue to Everton Place. Along this landscaped path, there are multiple opportunities for gathering at a variety of scales, including a large, shaded courtyard.

The project will support the six pillars identified in the Opportunities for Advancement, Social Inclusion and Sustainability (OASIS) initiative:

  •
  • Clean Energy & Fuels
  • Clean Transportation & Infrastructure
  • Natural Resource Management
  • Agriculture Technology & Food Security
  • Community Health & Disparities
  • Human Development

The project also involves the demolition of the existing University Extension building.

Project Scope:

The building will provide approximately 39,000 Sq. Ft, along with exterior circulation and gathering areas. The program includes the following spaces:

  • Research Laboratories
  • Makers Space
  • Active-Hybrid Learning Classroom
  • Meeting Rooms
  • Event Space
  • Incubator Facilities
  • Office Space
  • Open-Office Workstations
  • Shared Building Resources (Lobby, Multipurpose room(s) etc.)
  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (10/26/2026)

    Current Week – October 26, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    CLOSE DOWN EVERTON PARKING LOT ENTRANCE

    Fence

    Low-level and mid-level construction noise

    Building Site

    Demo Parking Lot Entrance

    Back-hoe

    Mid-level construction noise

    Building Site

    Excavate Parking Lot Entrance Underground

    Back-hoe

    Low-level and mid-level construction noise

    Building Site

    Trailer Removal

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – 10.28 - W V Gutter, 10.30 Ser Curb

    Concrete trucks

    Mid-level construction noise

    Building Site

    Tree Setting East

    Forklift

    Low-level and mid-level construction noise

    Building Site

    West Light Bore Shot

    Bare Equipment

    Low-level and mid-level construction noise

    Building Site

    Site Hardscape East / West

    Misc. Equipment

    Low-level and mid-level construction noise

    Building Site

    Fascia / Parapet Caps

    Scissor Lift

    Low-level construction noise

    Building Site

    Irrigation

    Mini Ex

    Low-level and mid-level construction noise

    Building Site

    Exterior Cameras

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Acoya Wood

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Glazing Replacement

    Boom Lift & Forklift

    Low-level and mid-level construction noise

    Building

    Interior UCR Punchlist Corrections

    Low-level construction noise

    Building

    Fire Alarm Testing

    Low-level and mid-level construction noise

    Building

    Cx-PFT / Fire Alarm Testing

    Scissor Lift

    Low-level construction noise

    Week of November 2, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Parking Lot 51 Entrance Everton Closed

    Low-level and Mid-level construction noise

    Building Site

    Light Pole Base Curbs Everton Parking Lot

    Low-level and Mid-level construction noise

    Building Site

    Grade South Old Trailer Area

    Loader

    Building Site

    Concrete Placement (5AM Start) – 11.3 – East LO’s, 11.6 – South Curb

    Concrete trucks

    Mid-level construction noise

    Building Site

    Metal Panels Mech Screen Remediation

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Tree Setting West

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Landscape

    Skip Loader

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East / West

    Misc. Equipment

    Low-level and Mid-level construction noise

    Building Site

    Site Lighting

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Glazing Replacement

    Boom Lift & Forklift

    Low-level and Mid-level construction noise

    Building Exterior

    Arch Exterior / Roof  Punch Walk

    Low-level construction noise

    Building

    UCR Punch Sign-Offs

    Scissor Lift

    Low-level construction noise

    Building

    Cx - FPT

    Low-level construction noise

    Week of November 9, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Parking Lot 51 Entrance Everton Closed

    Low-level and Mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – 11.2, 11.10 & 11.12 (Courtyard & Everton)

    Concrete Trucks

    Low-level and Mid-level construction noise

    Building Site

    Grading East pre Paving

    Low-level and Mid-level construction noise

    Building Site

    Site Lights

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Landscape

    Low-level and Mid-level construction noise

    Building Site

    Glazing Replacement Detailing

    Boom Lift & Forklift

    Low-level and Mid-level construction noise

    Building

    Interior UCR Punchlist – Sign Offs

    Low-level construction noise

    Building

    Cx - FPT

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    UCR South Parking Lot Entrance Closed (Everton) – (10/26 – 11/20)

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

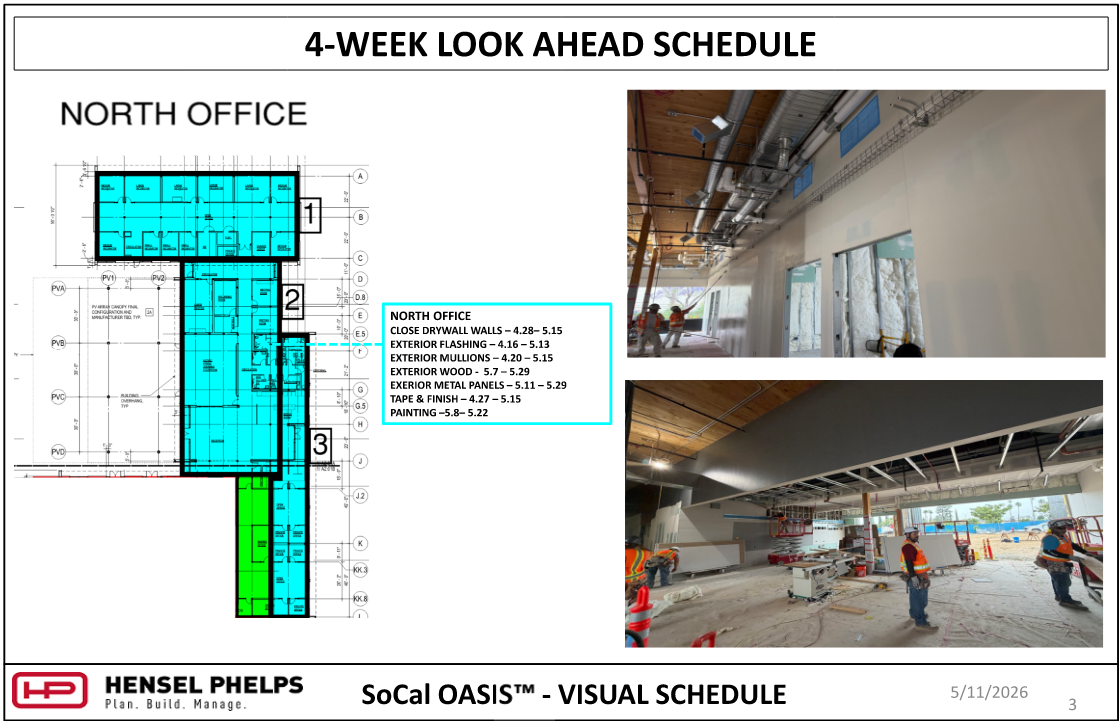

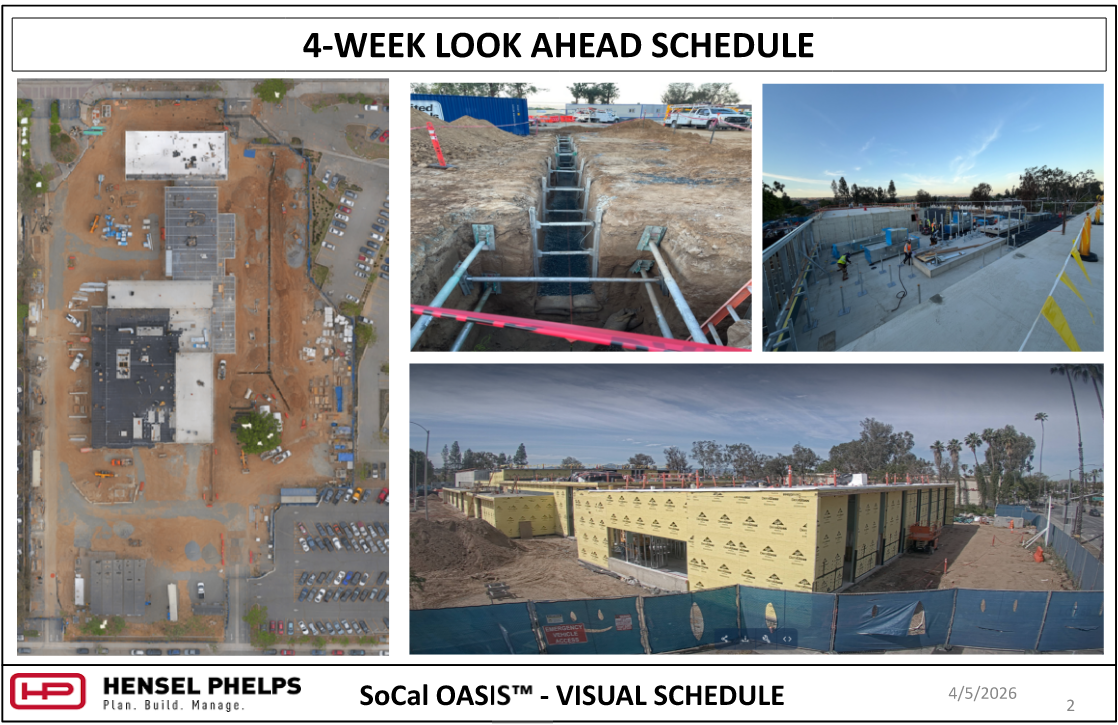

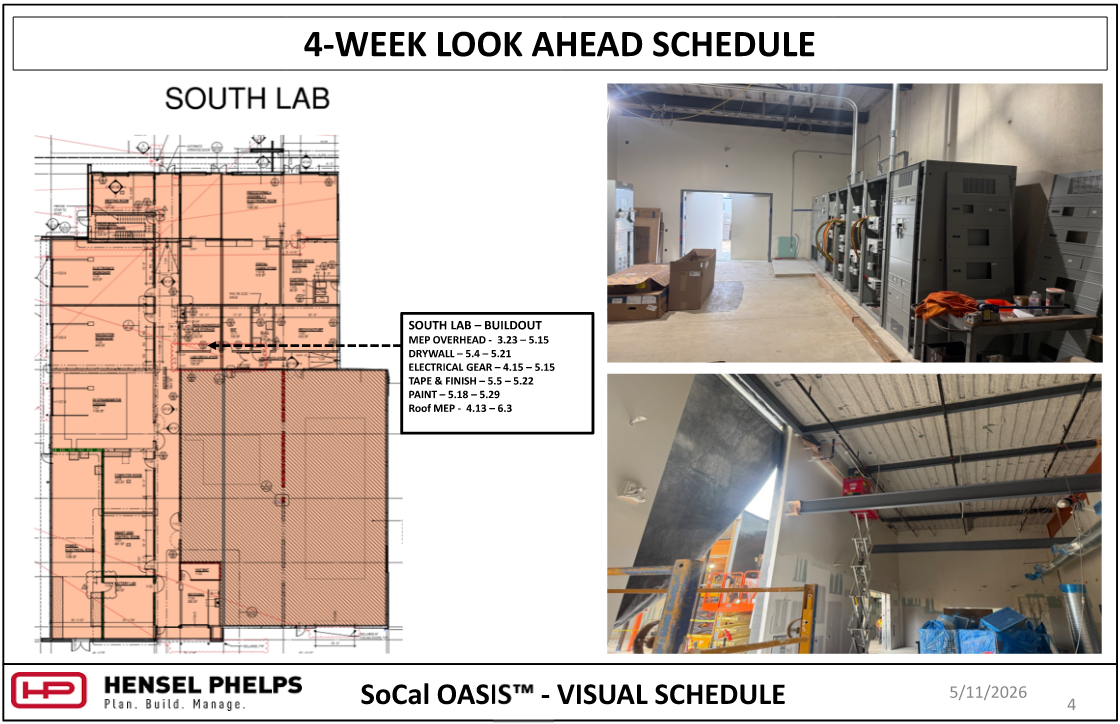

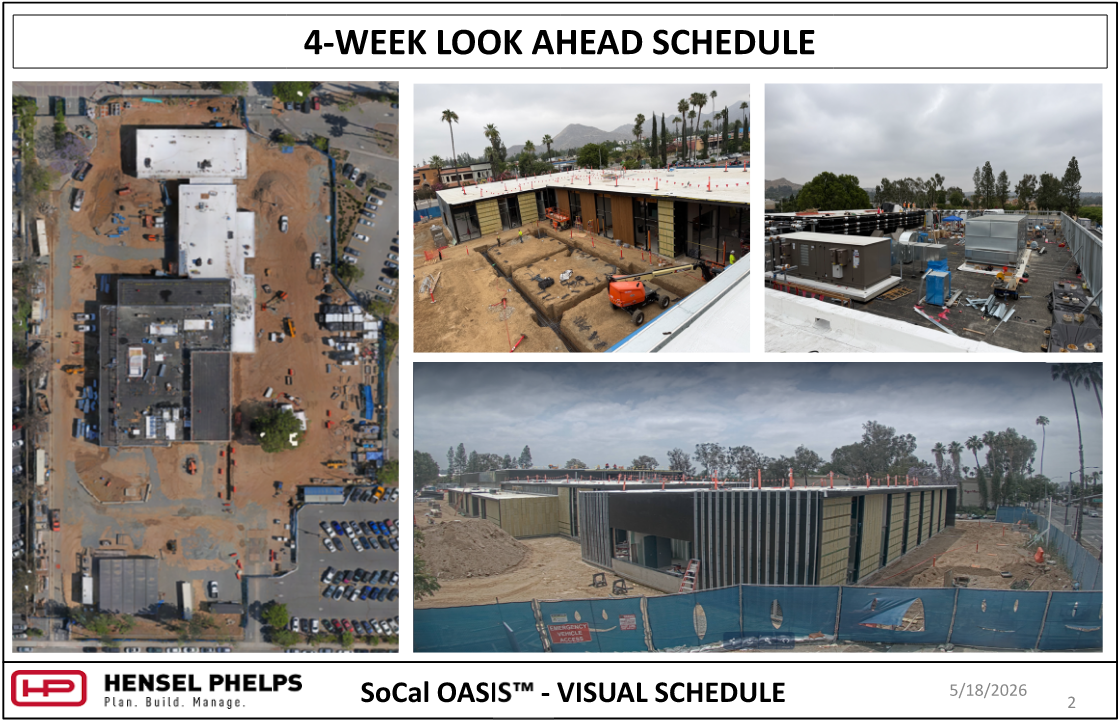

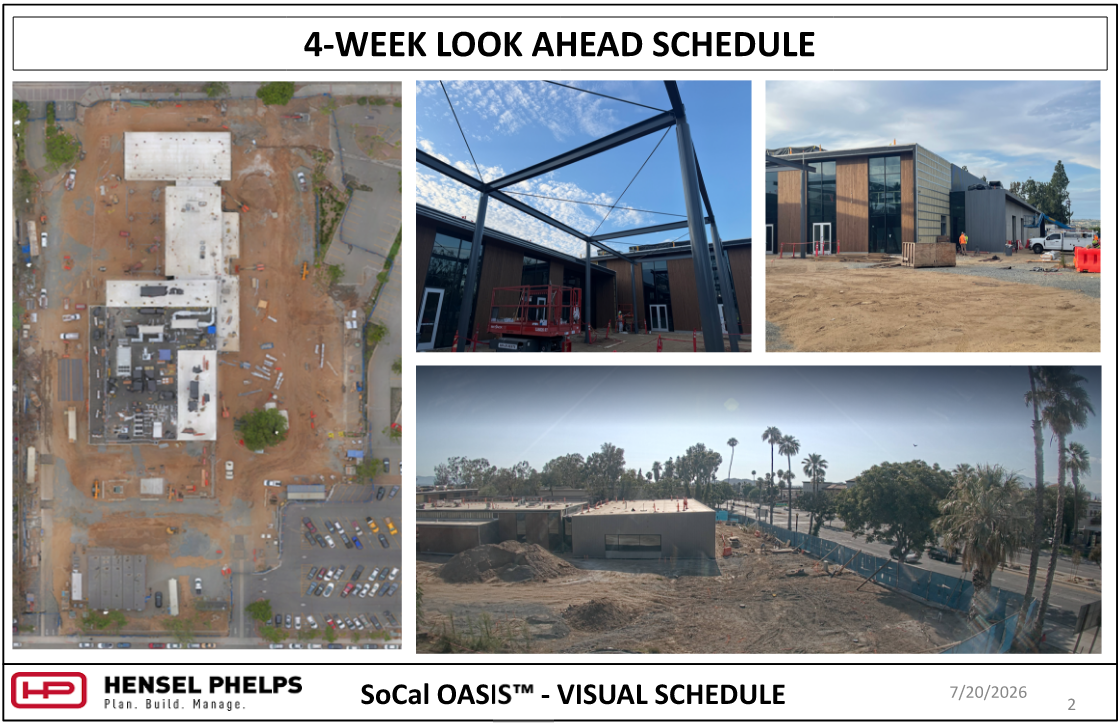

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (10/19/2026)

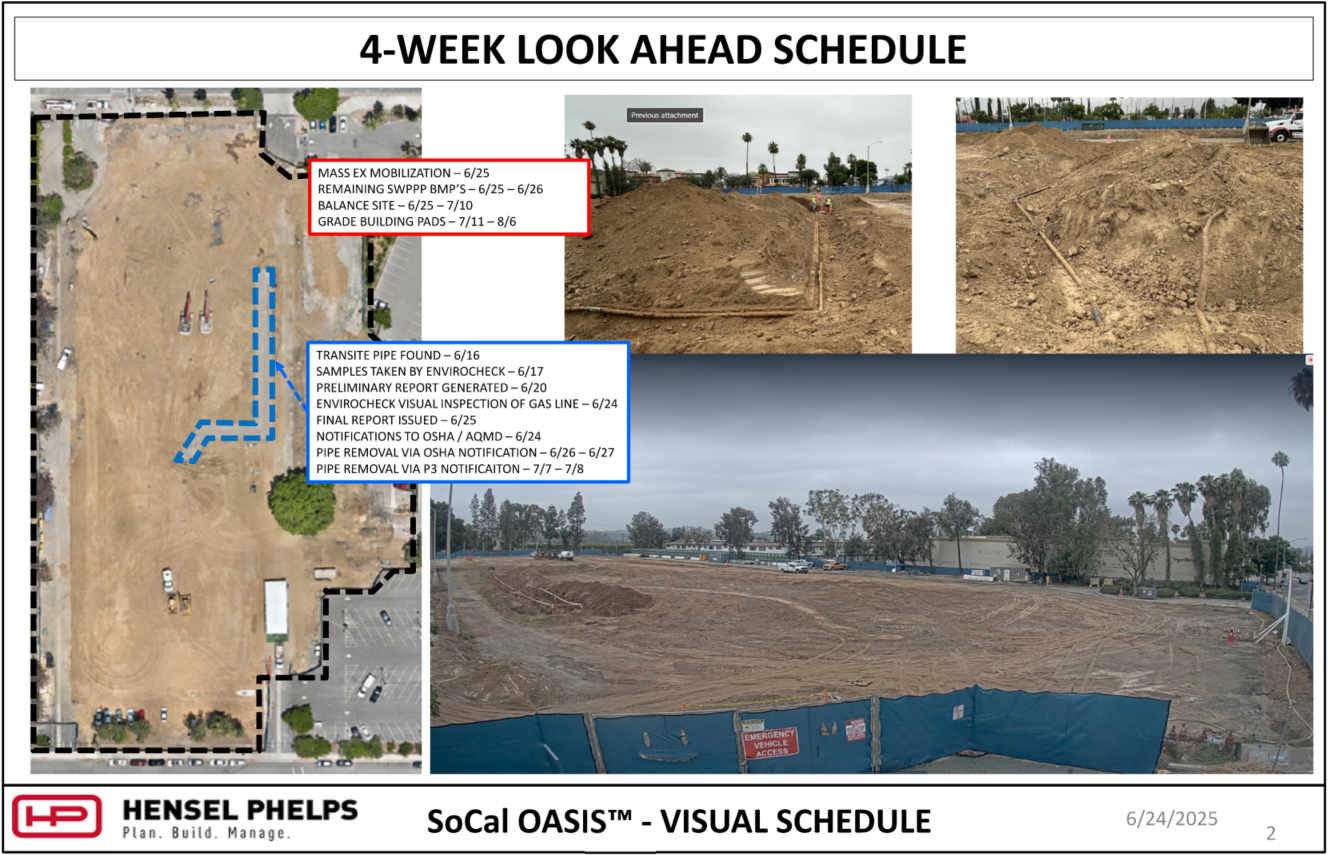

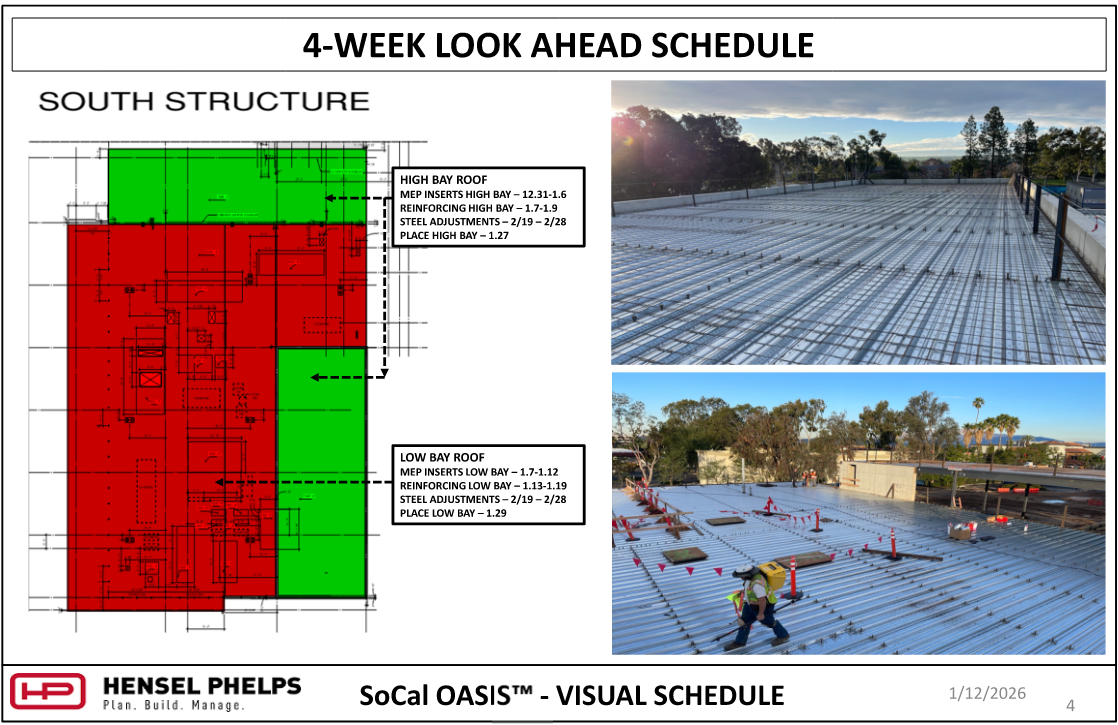

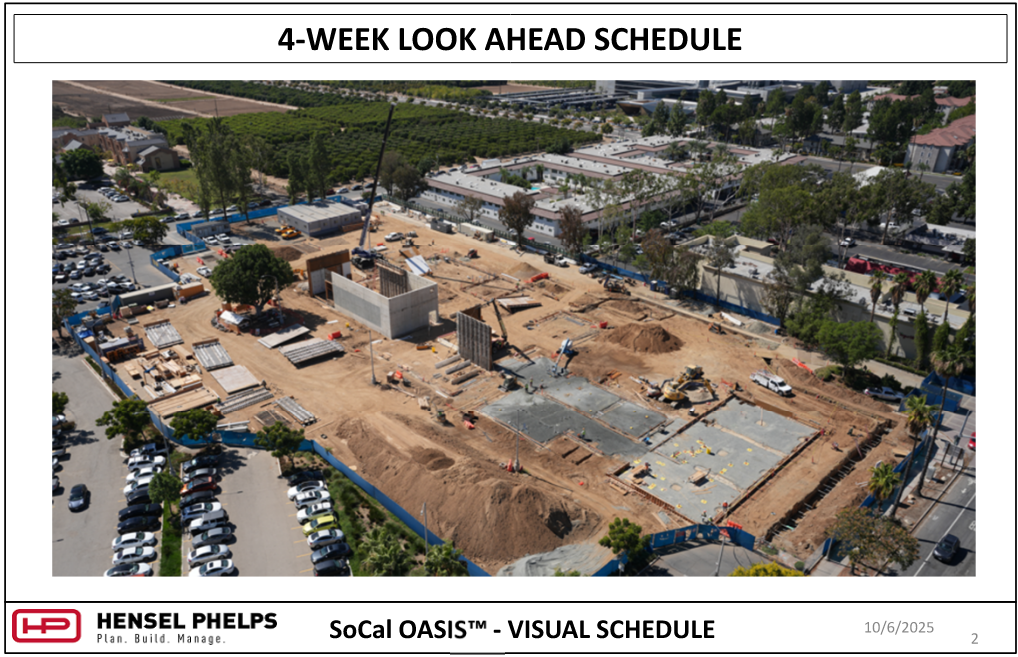

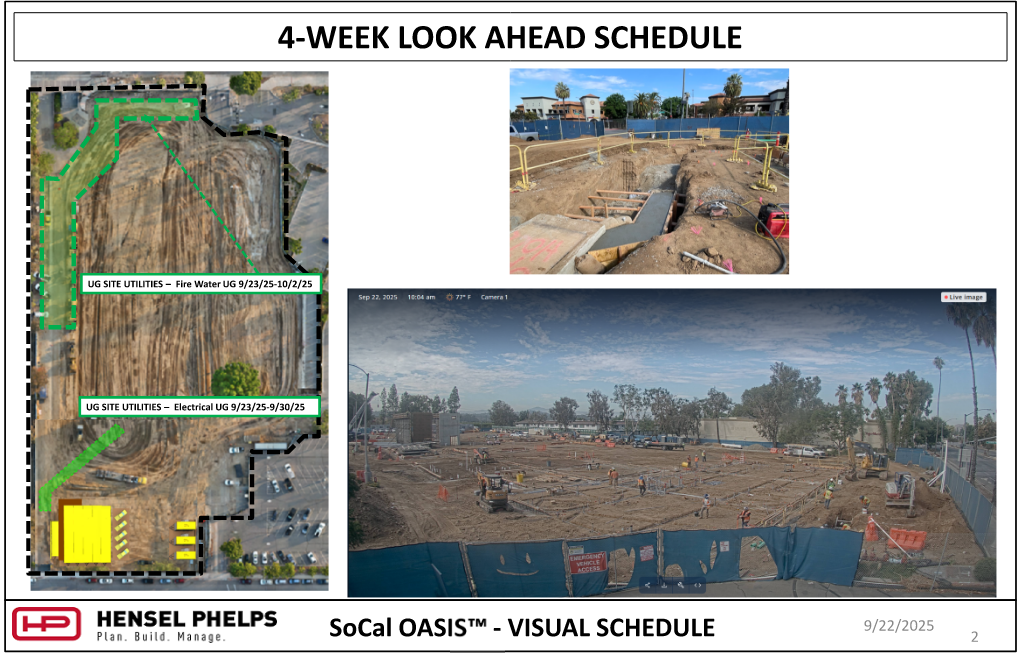

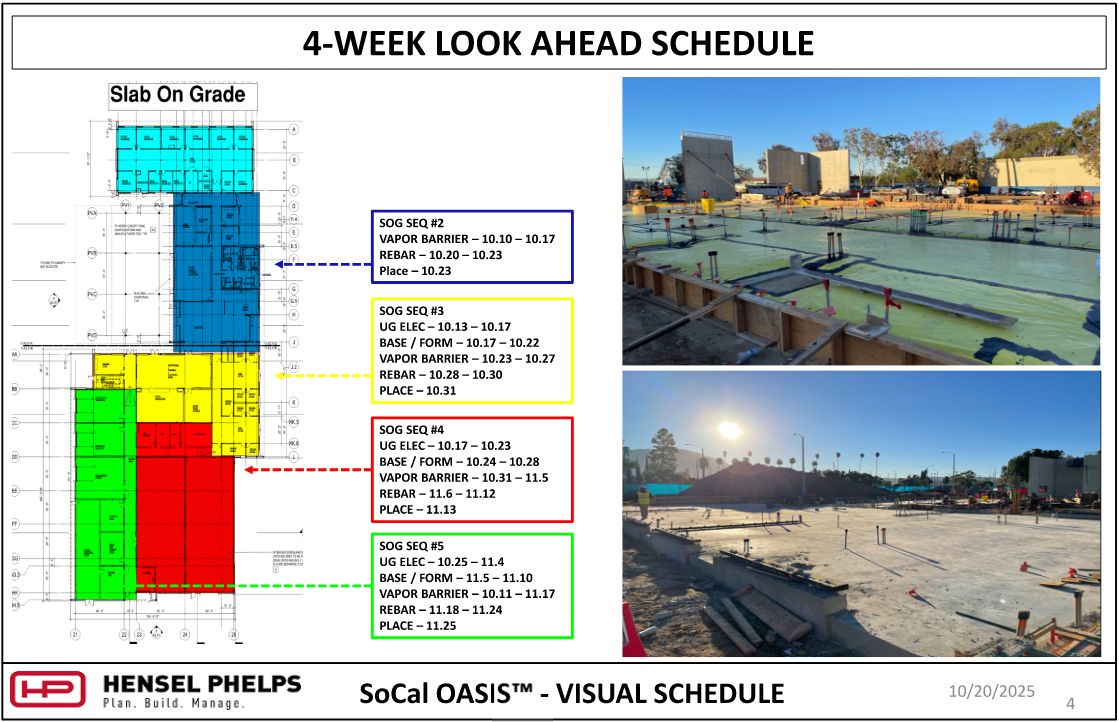

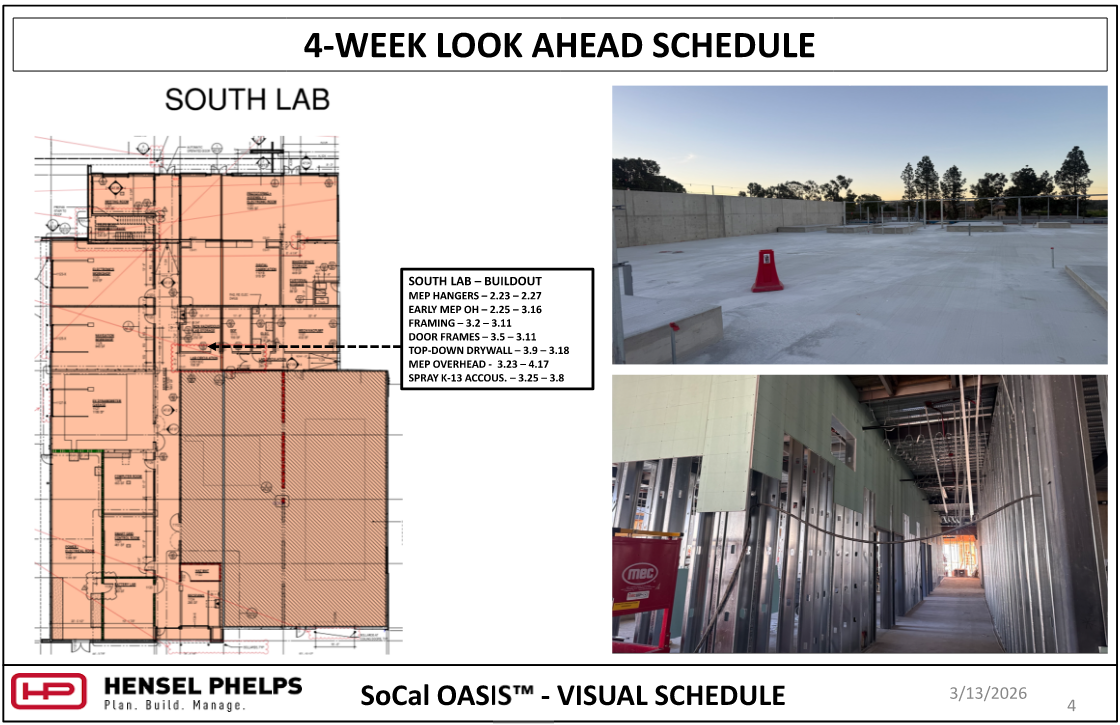

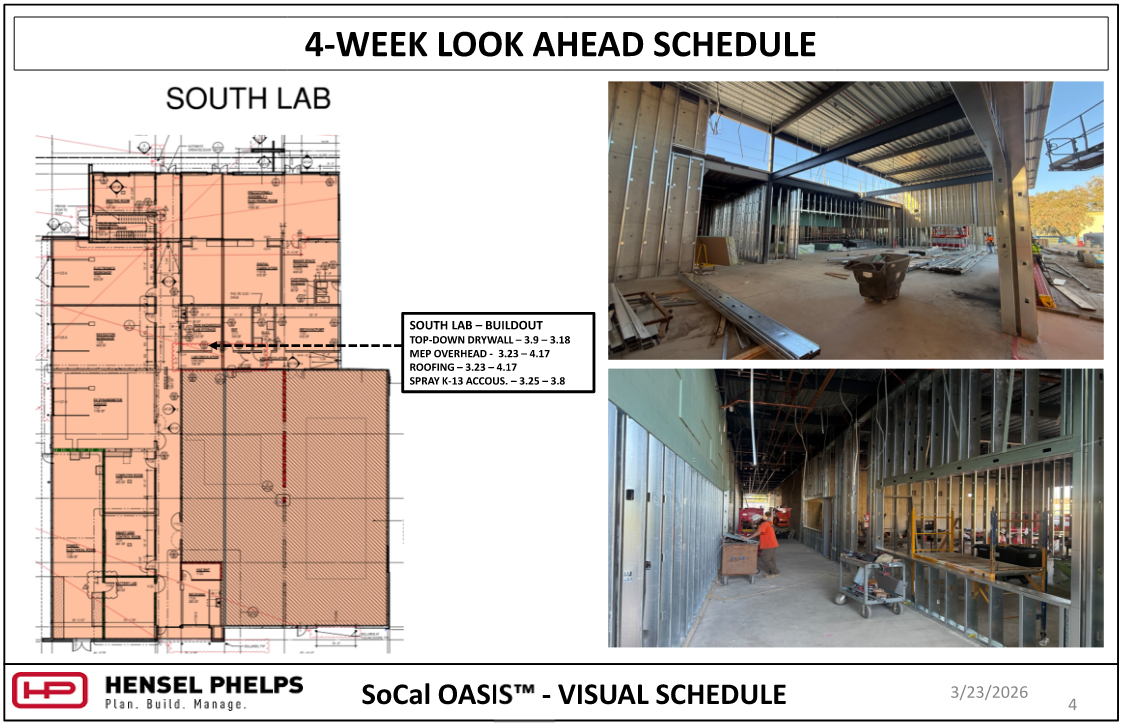

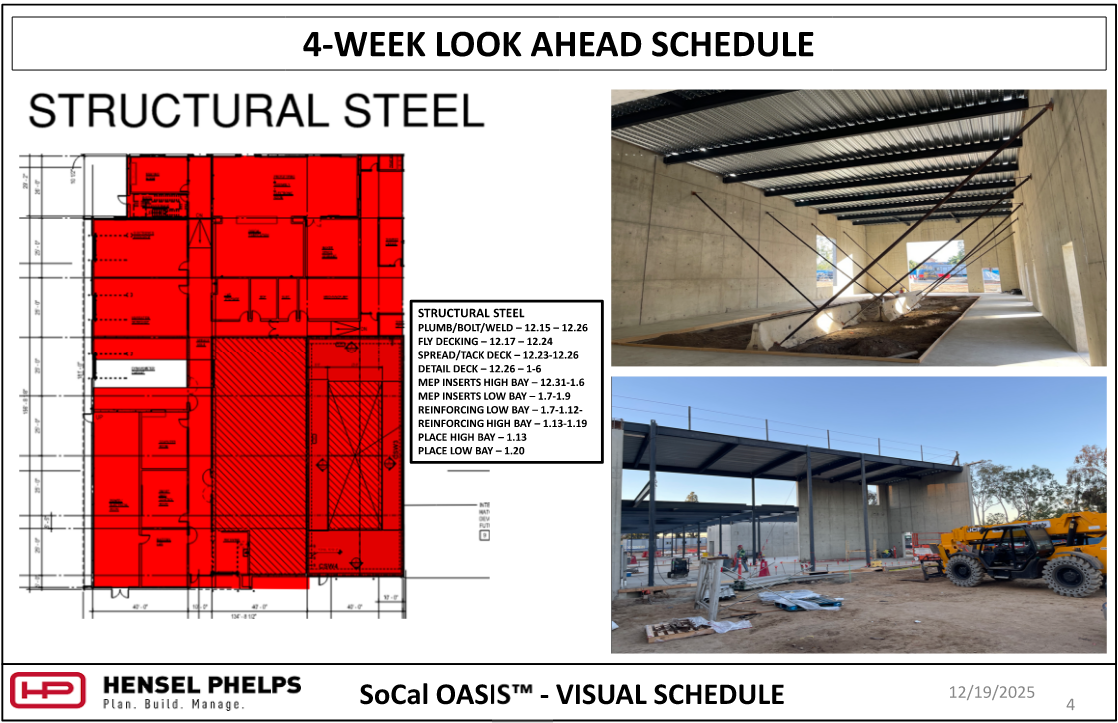

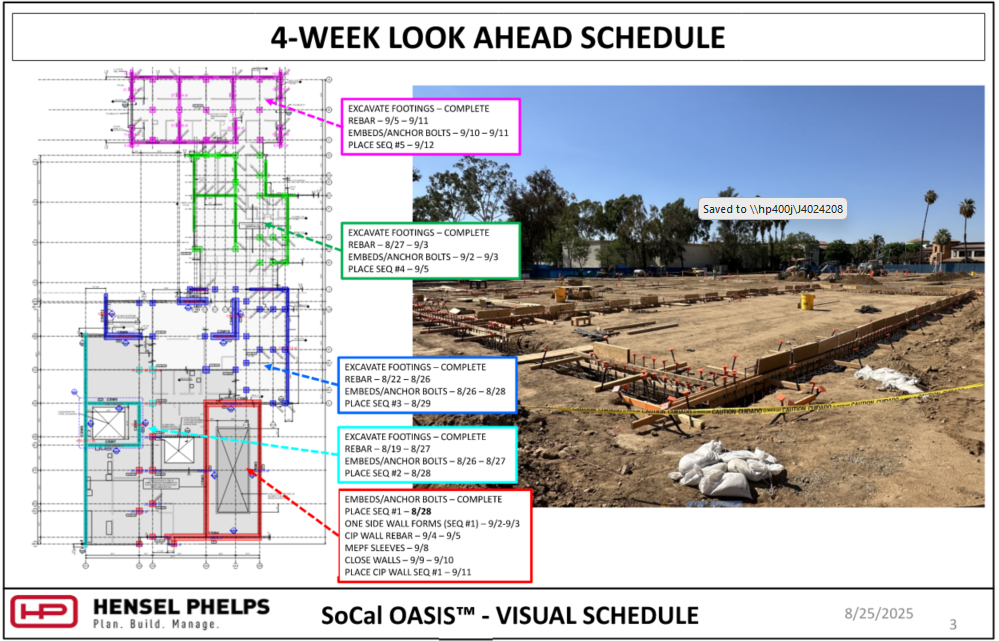

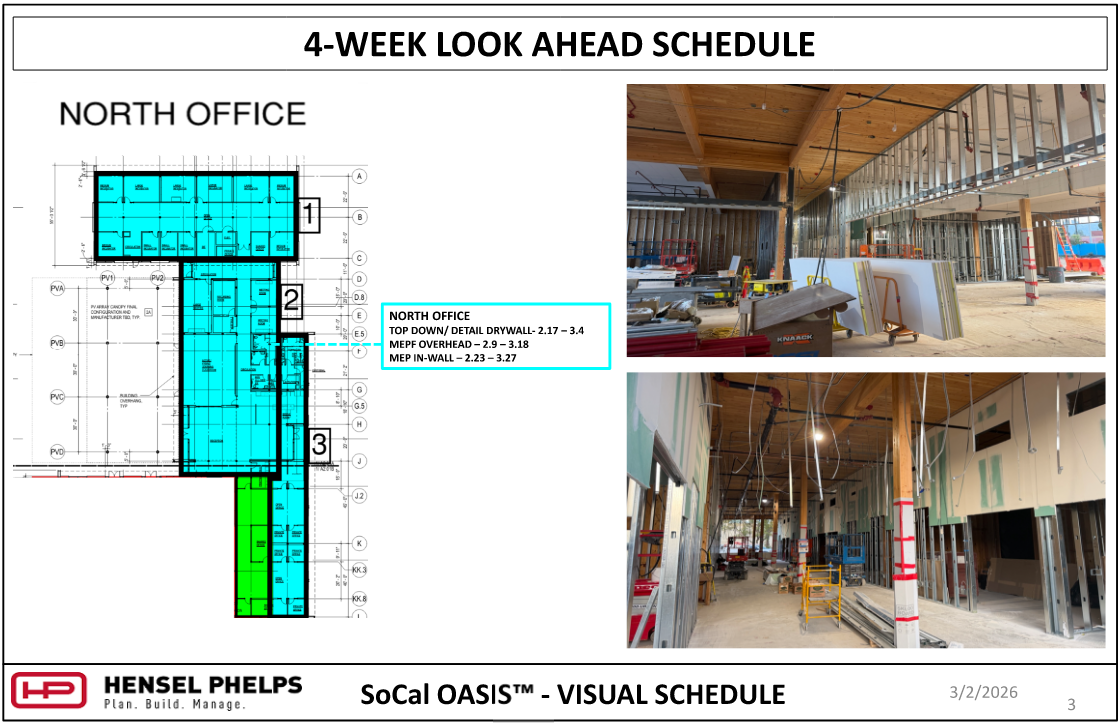

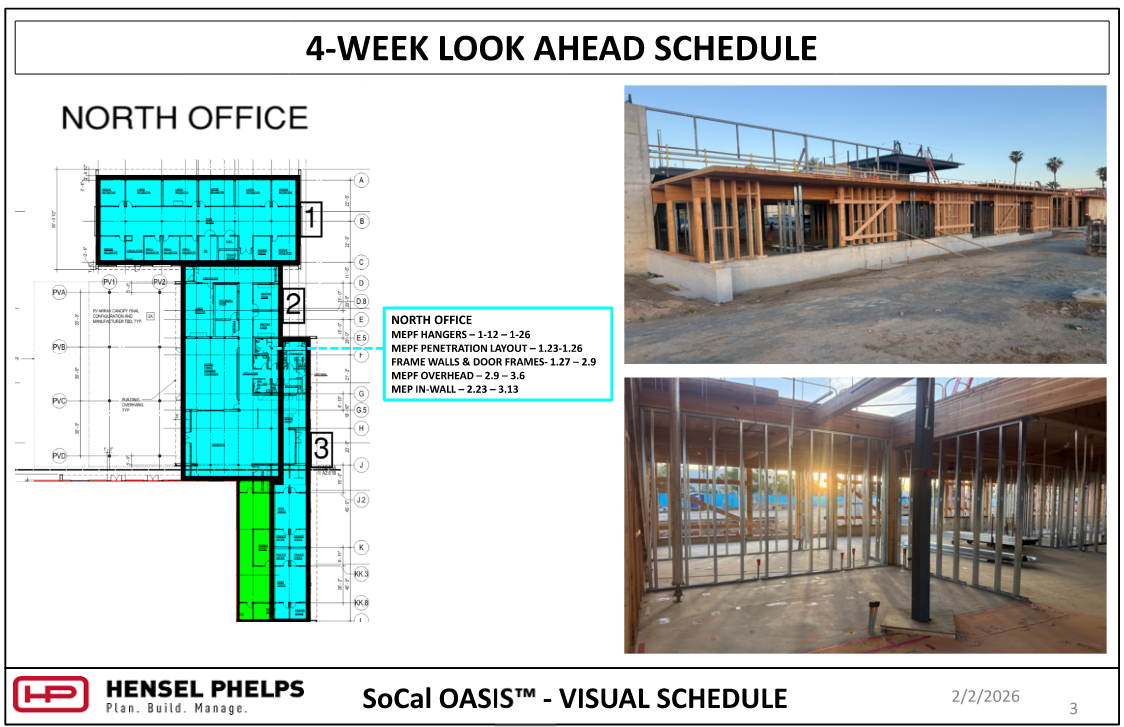

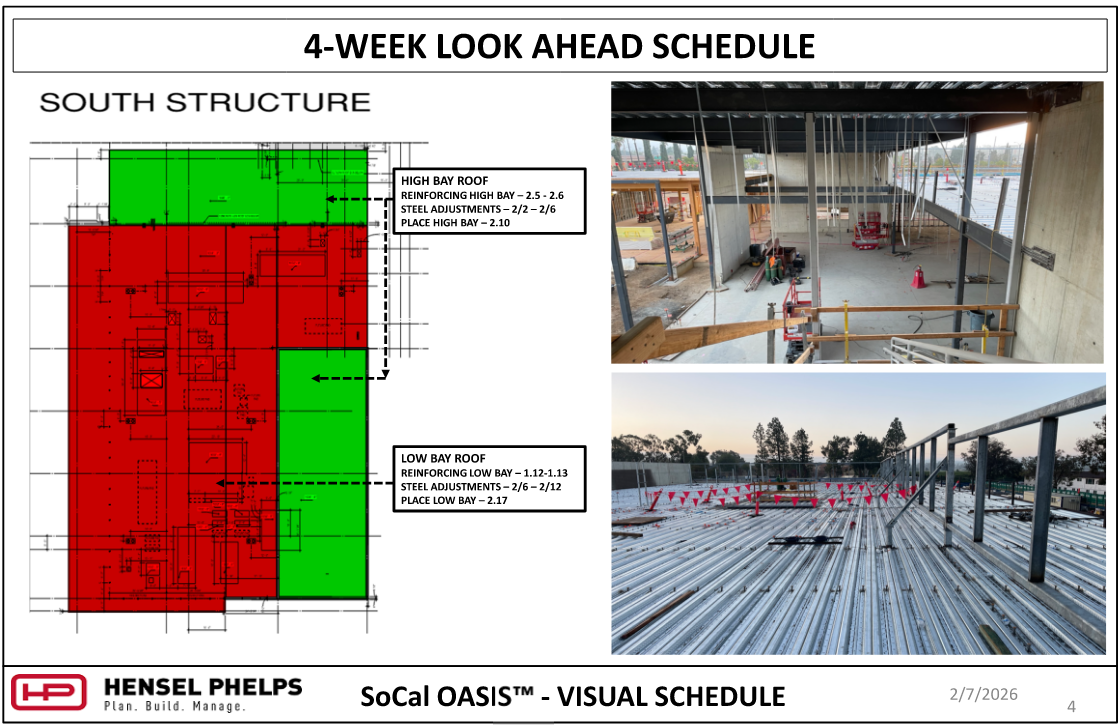

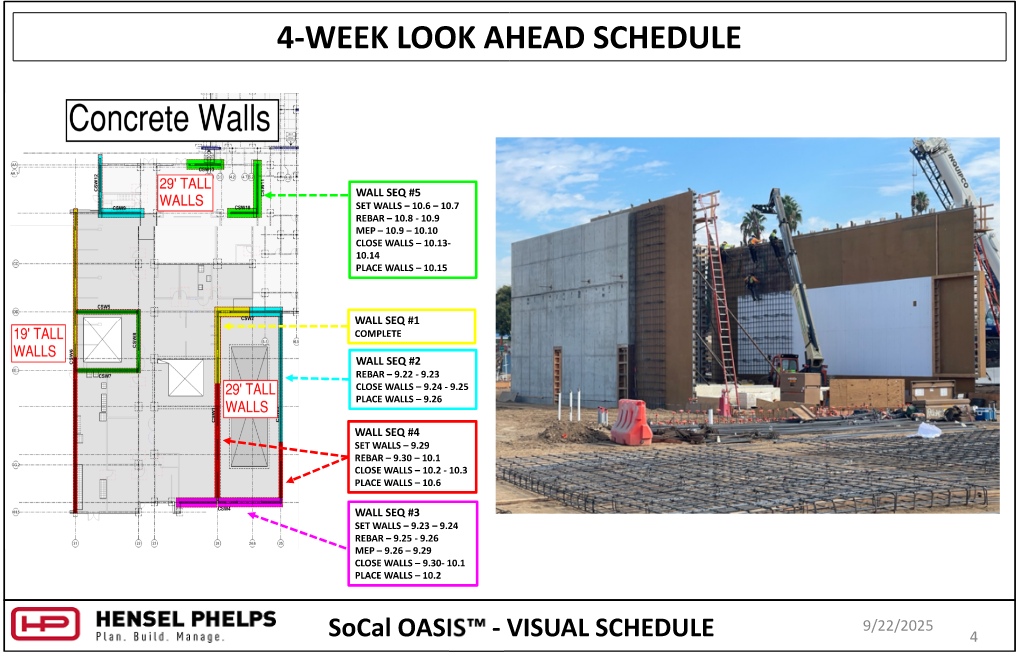

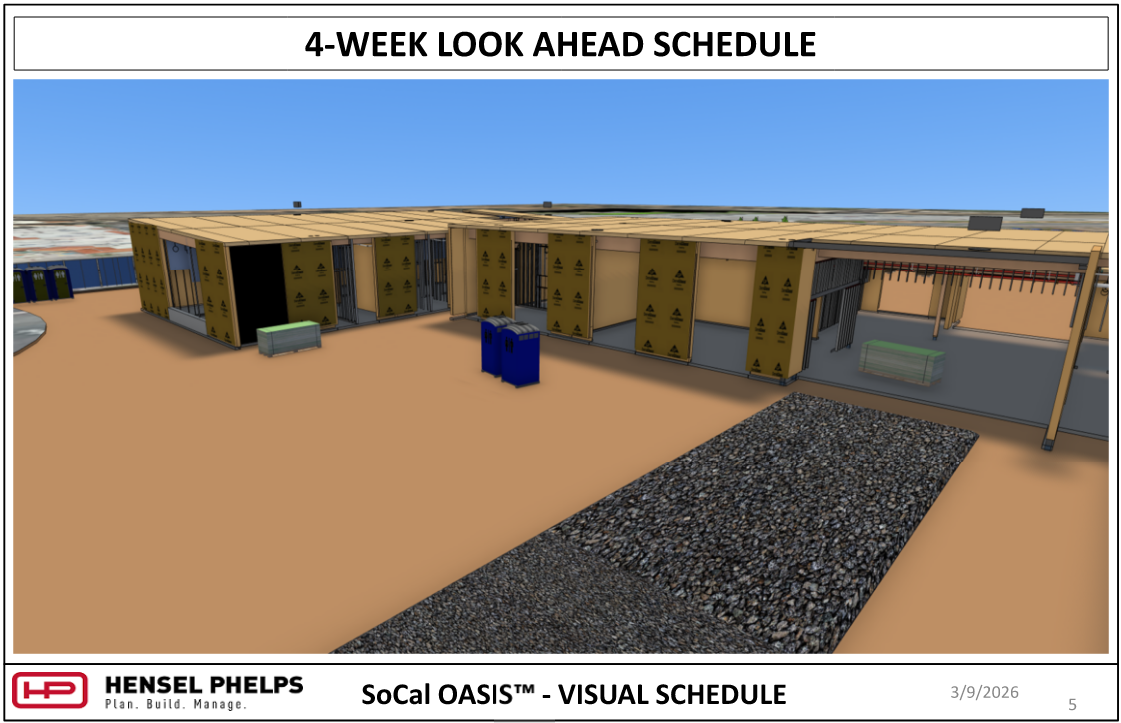

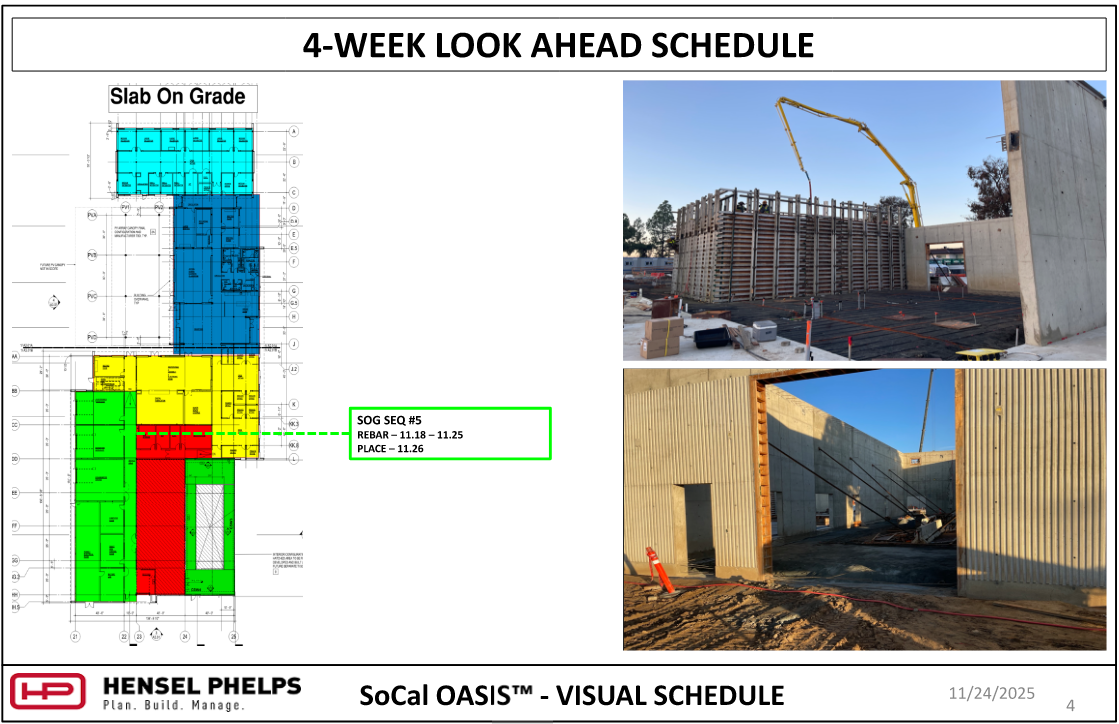

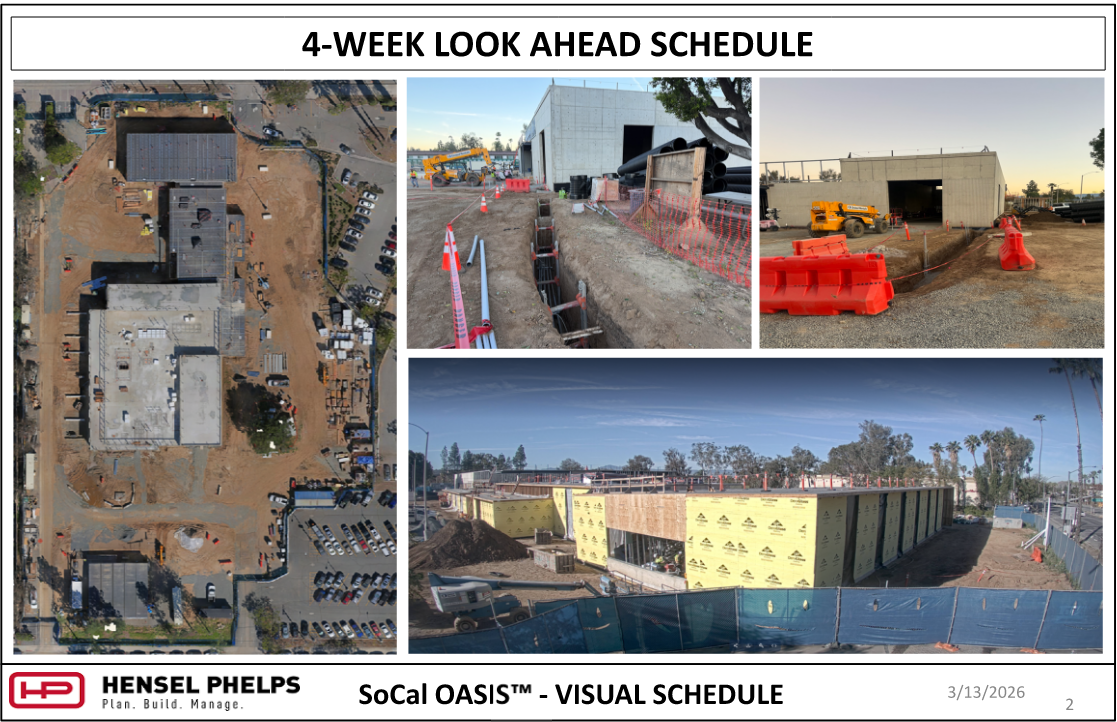

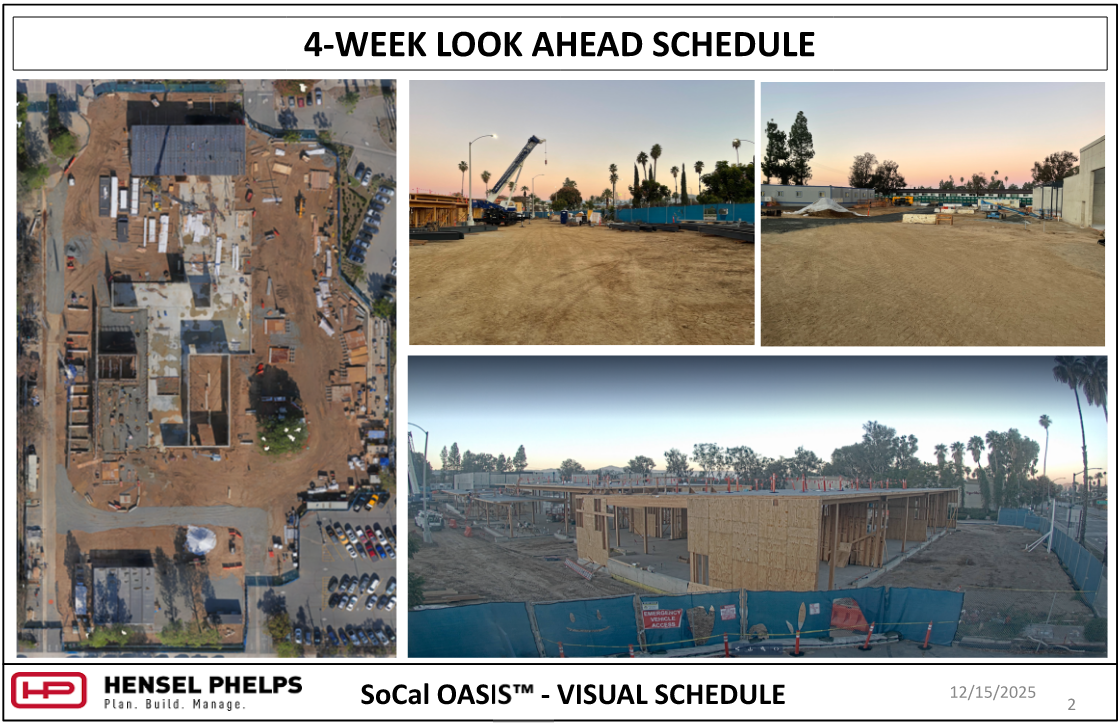

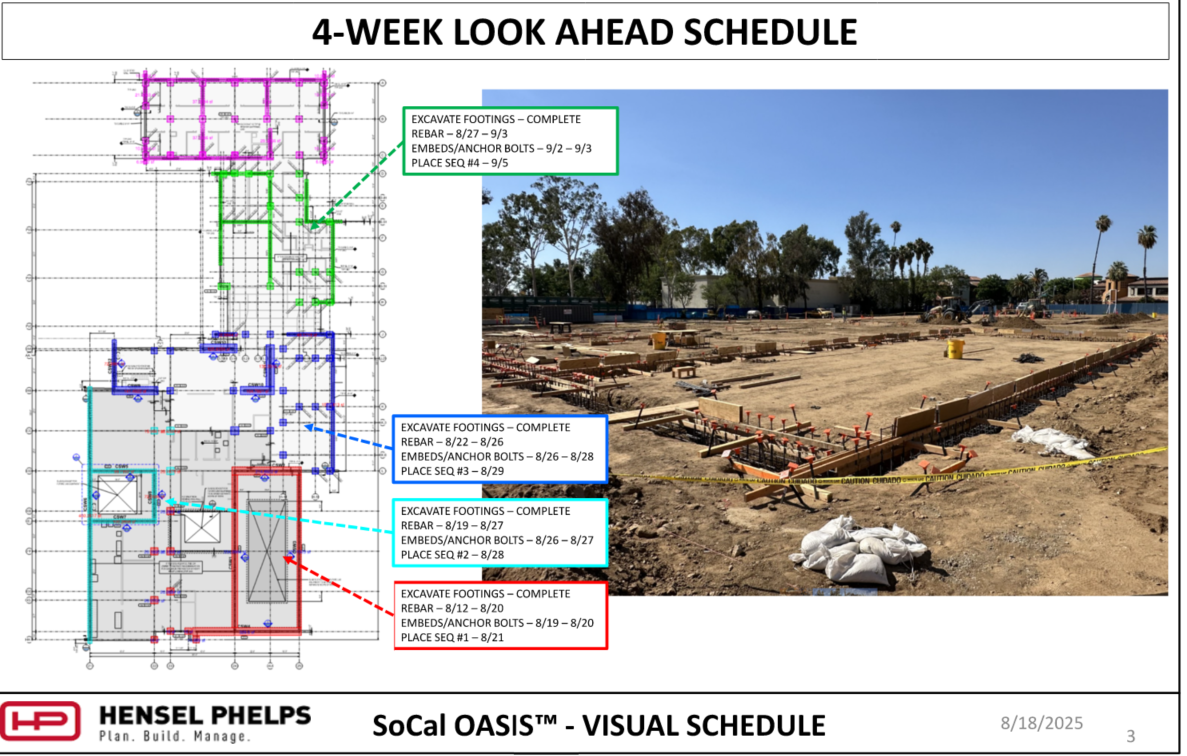

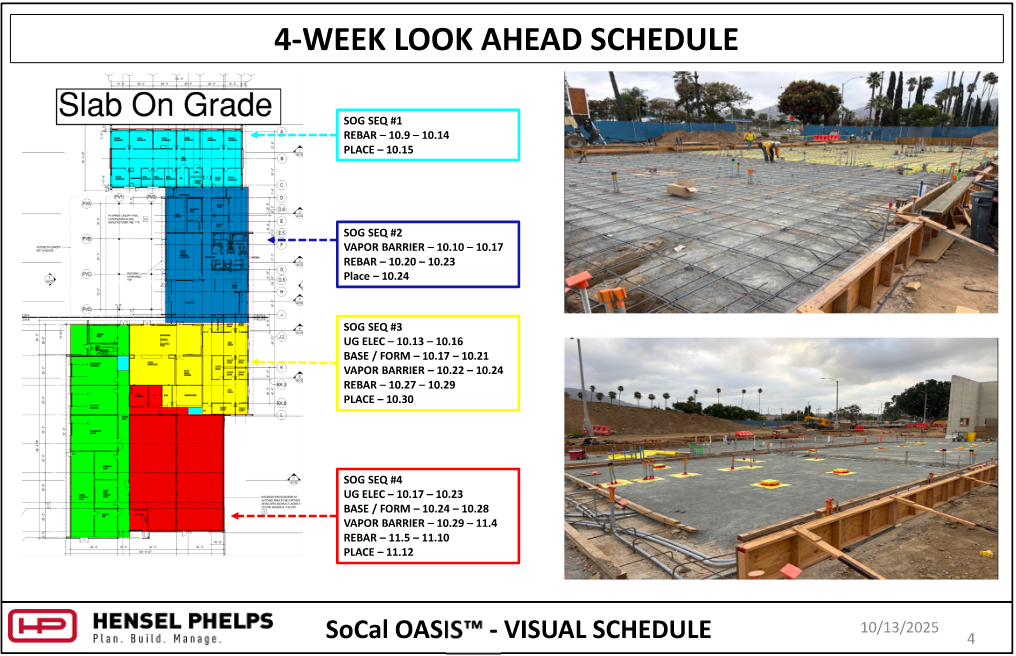

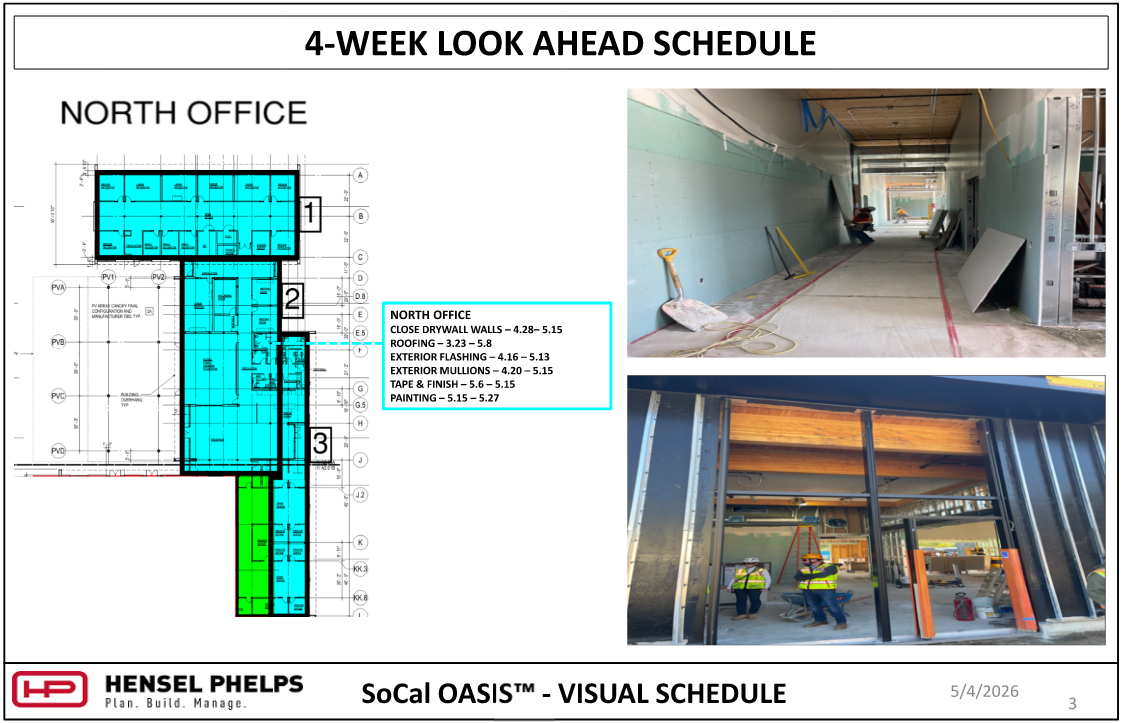

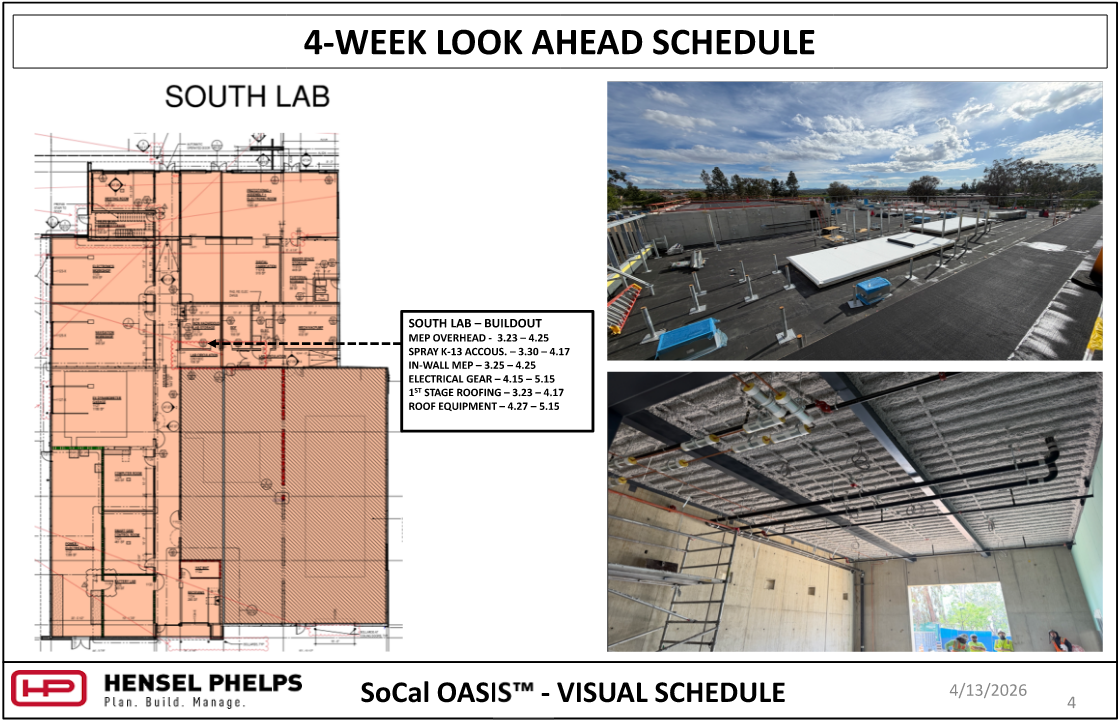

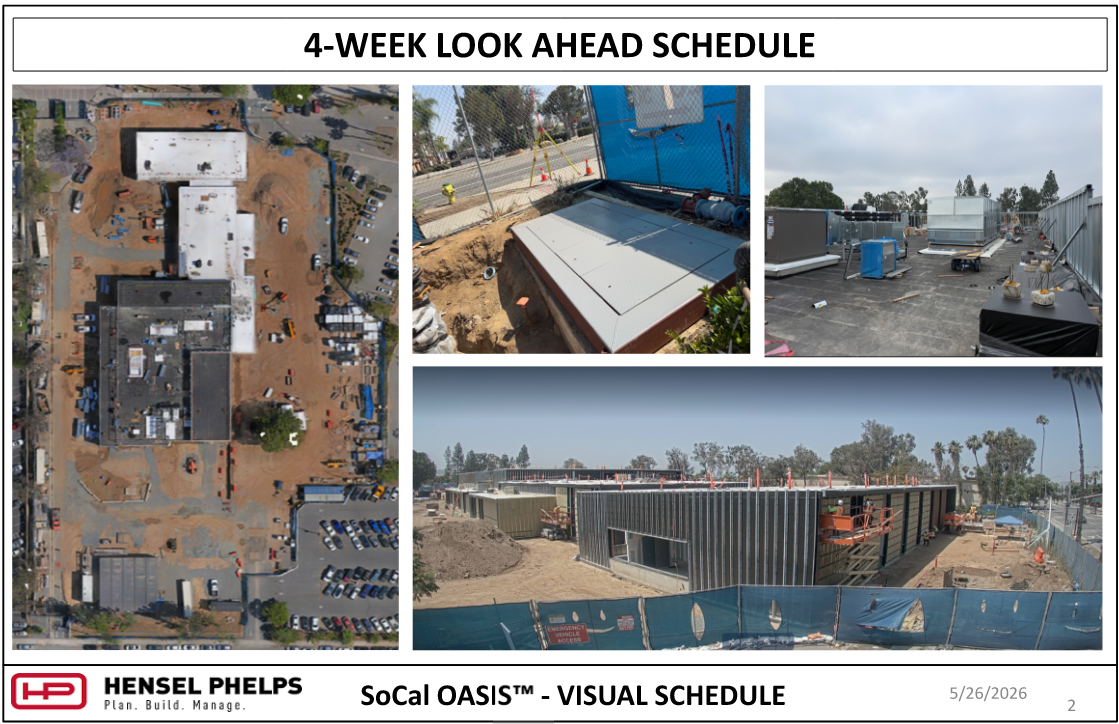

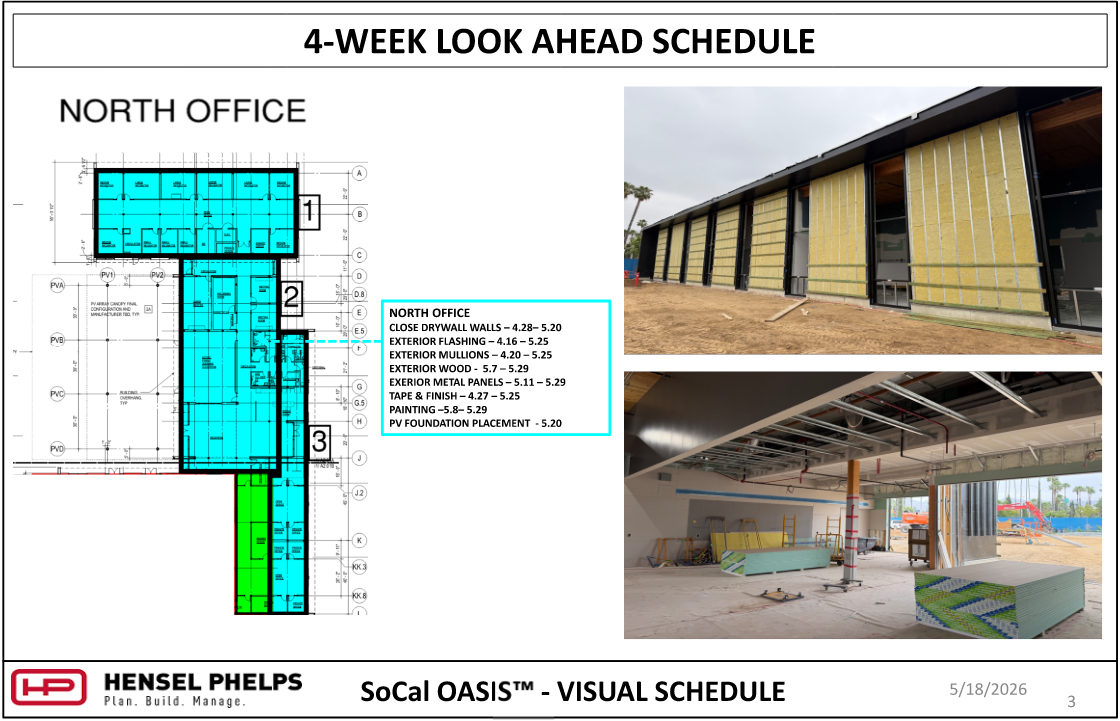

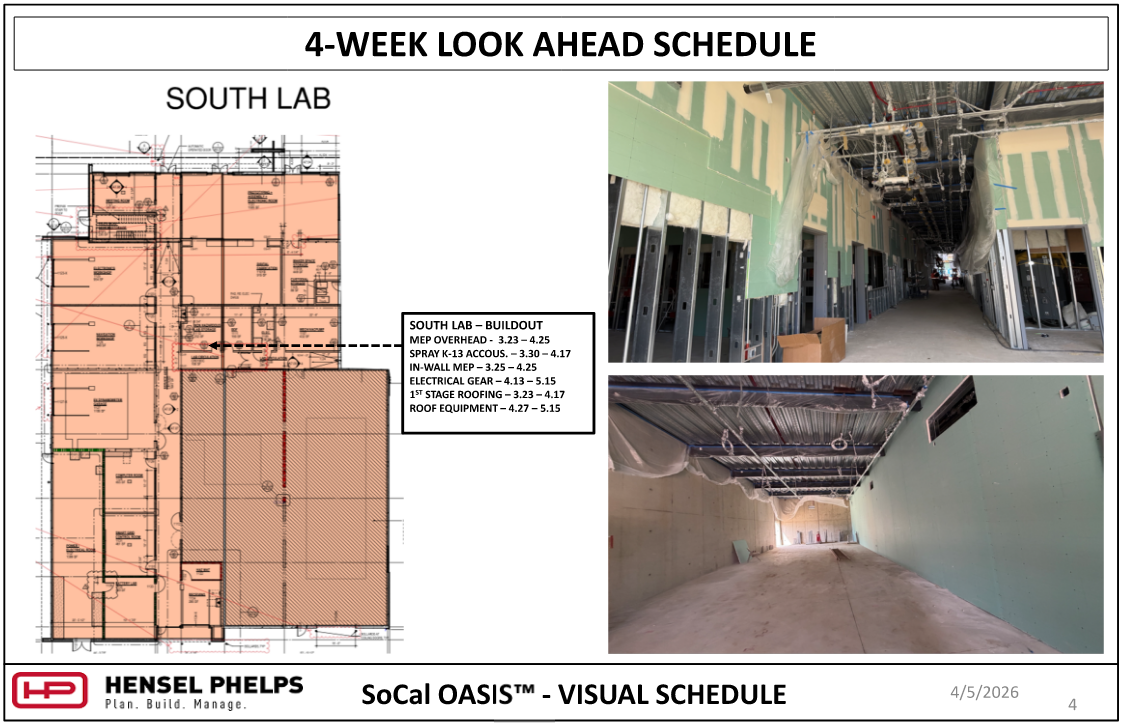

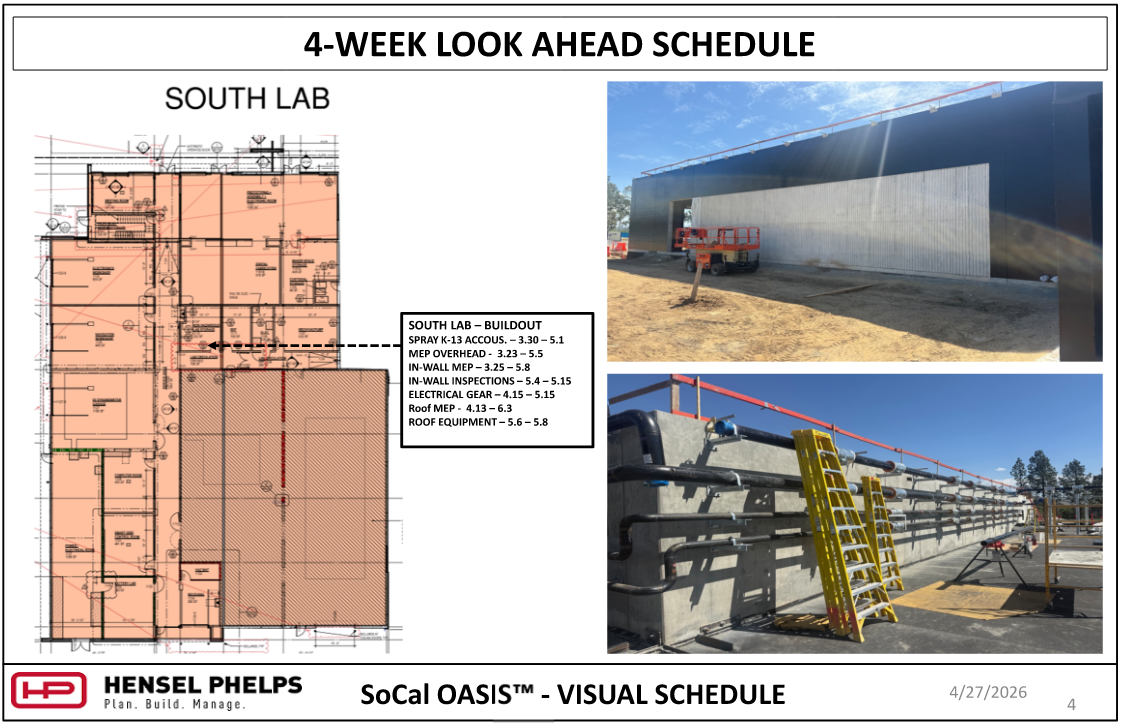

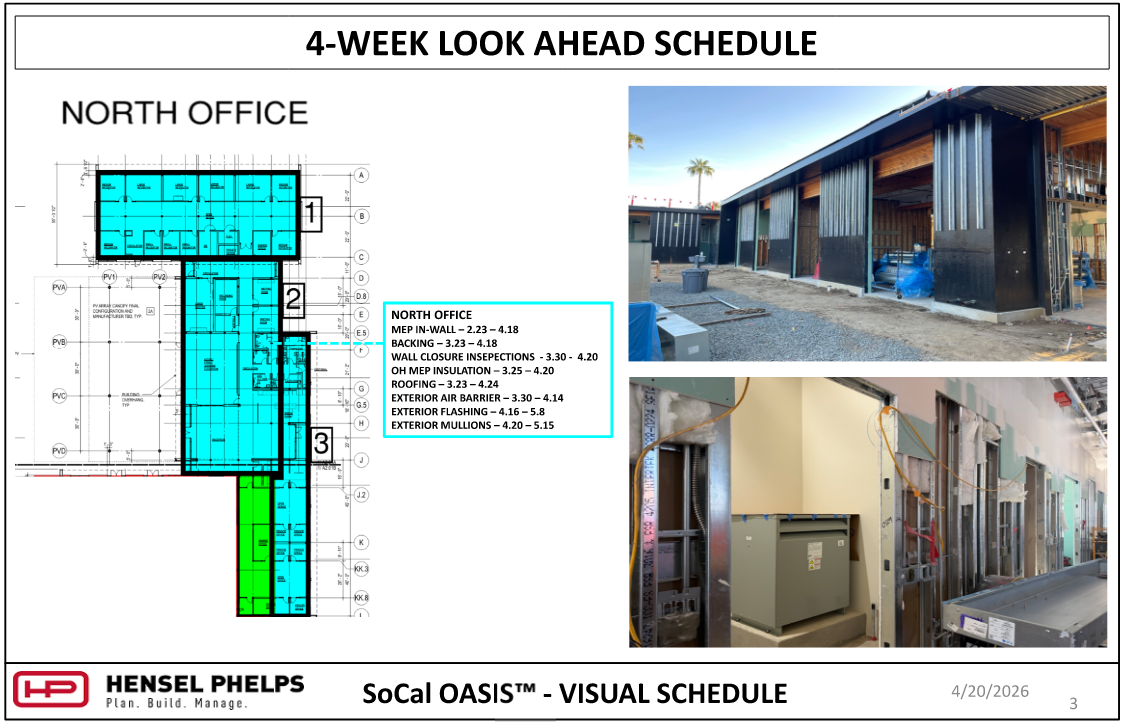

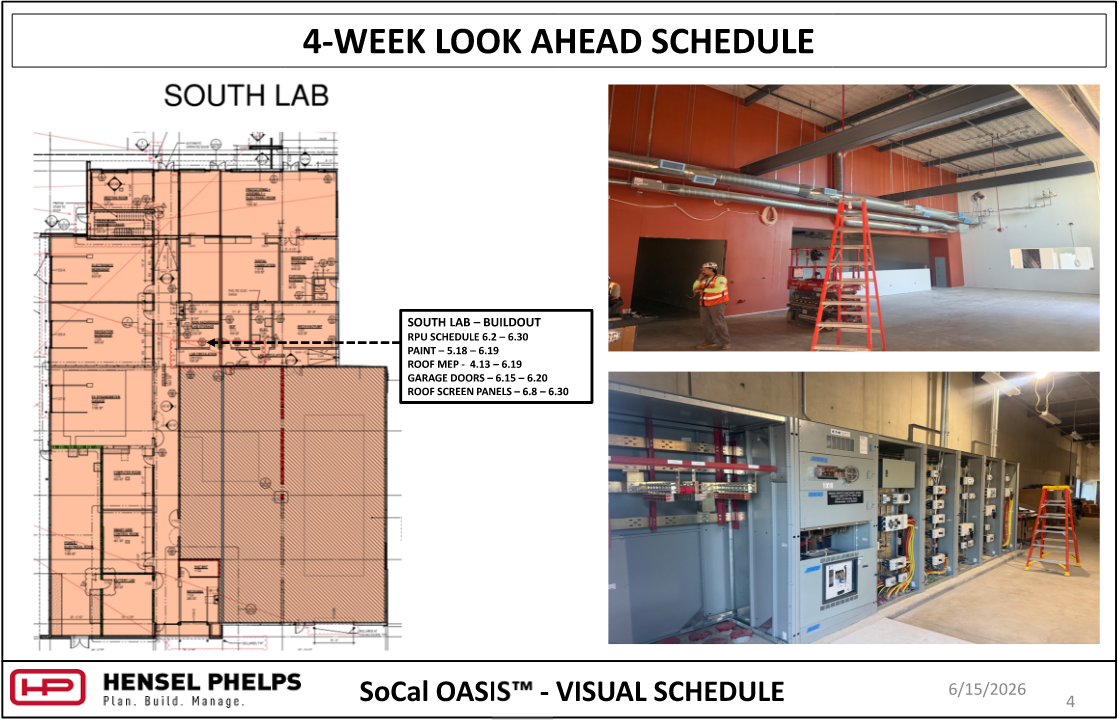

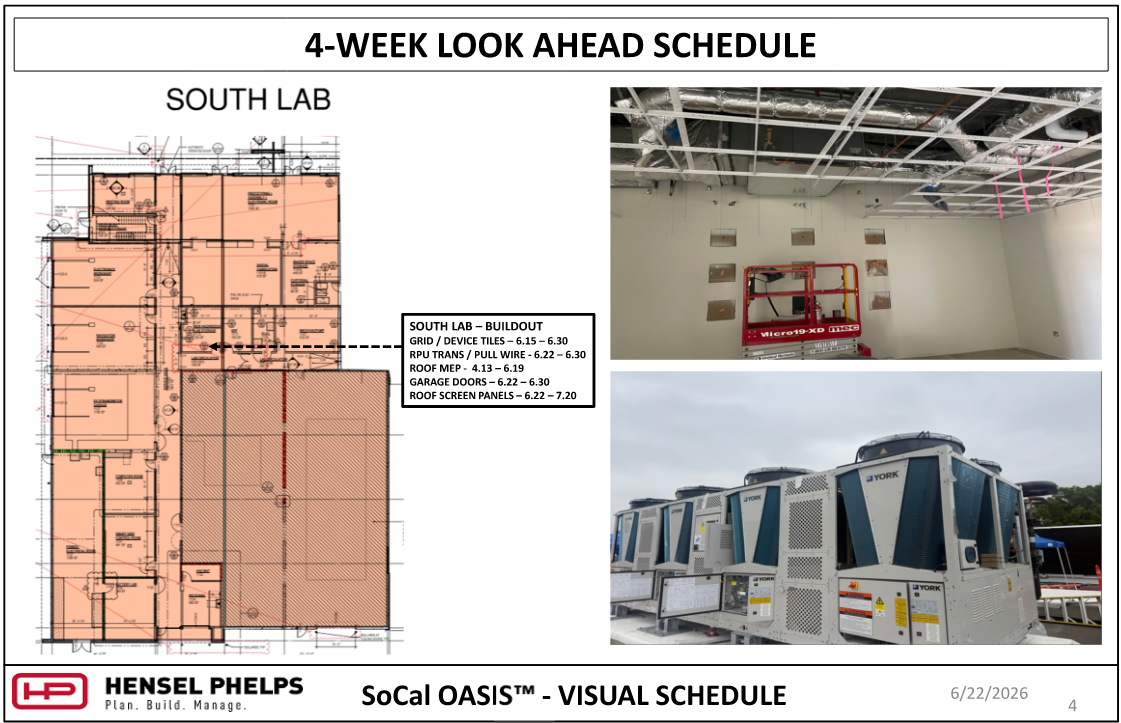

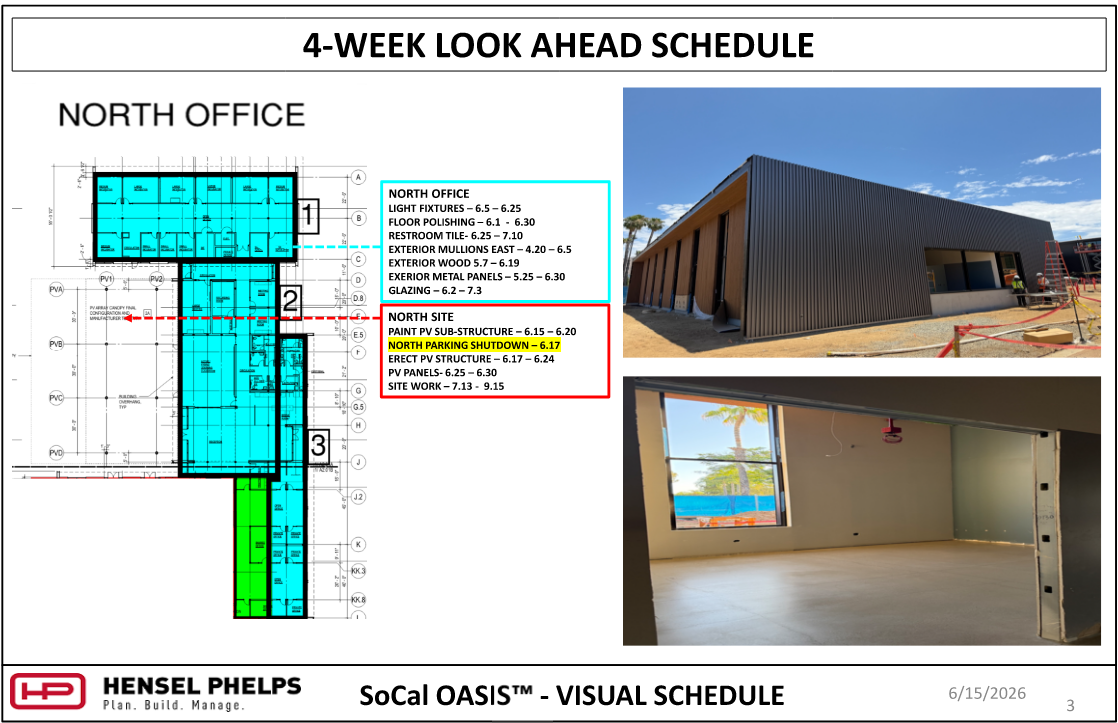

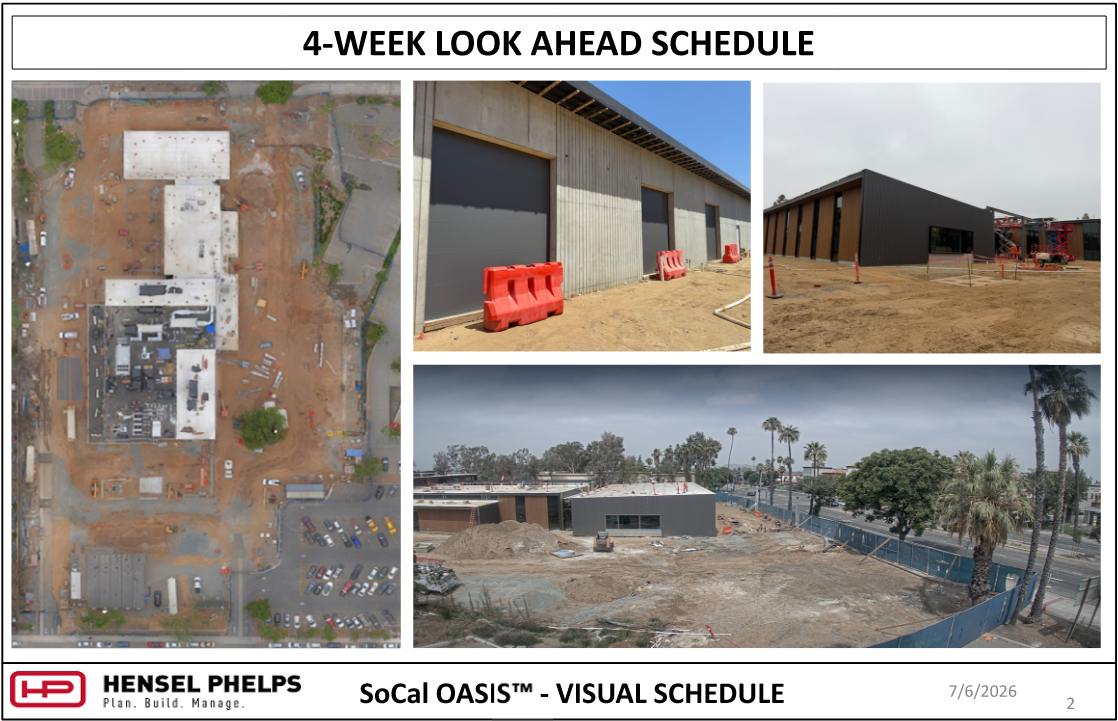

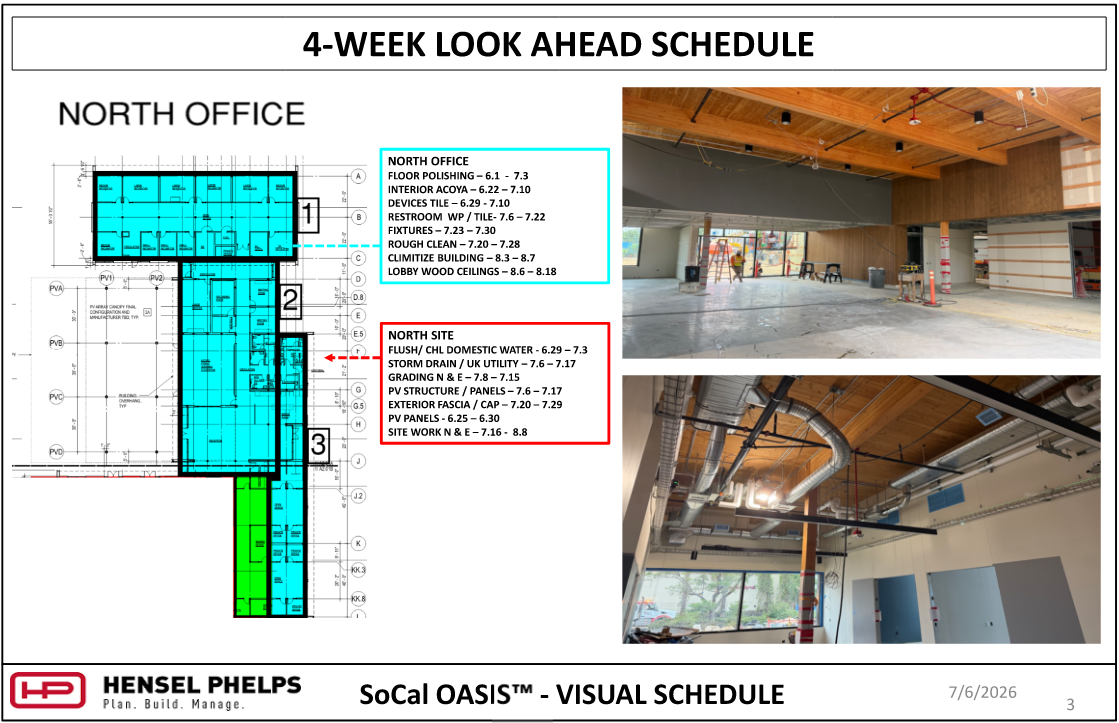

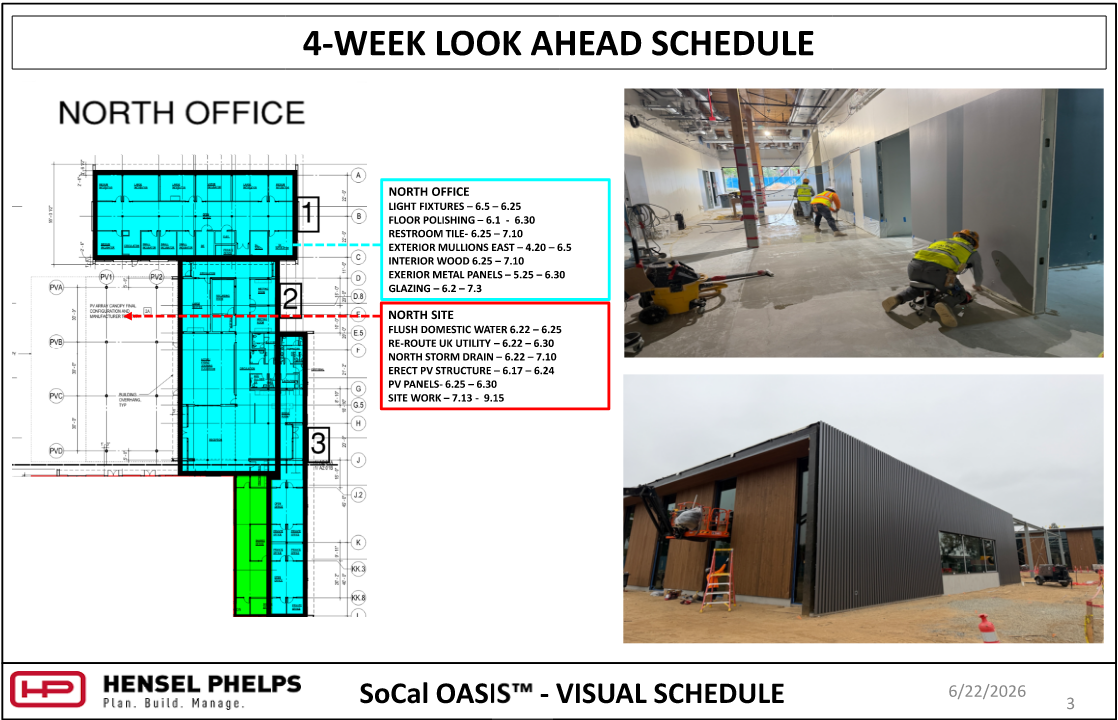

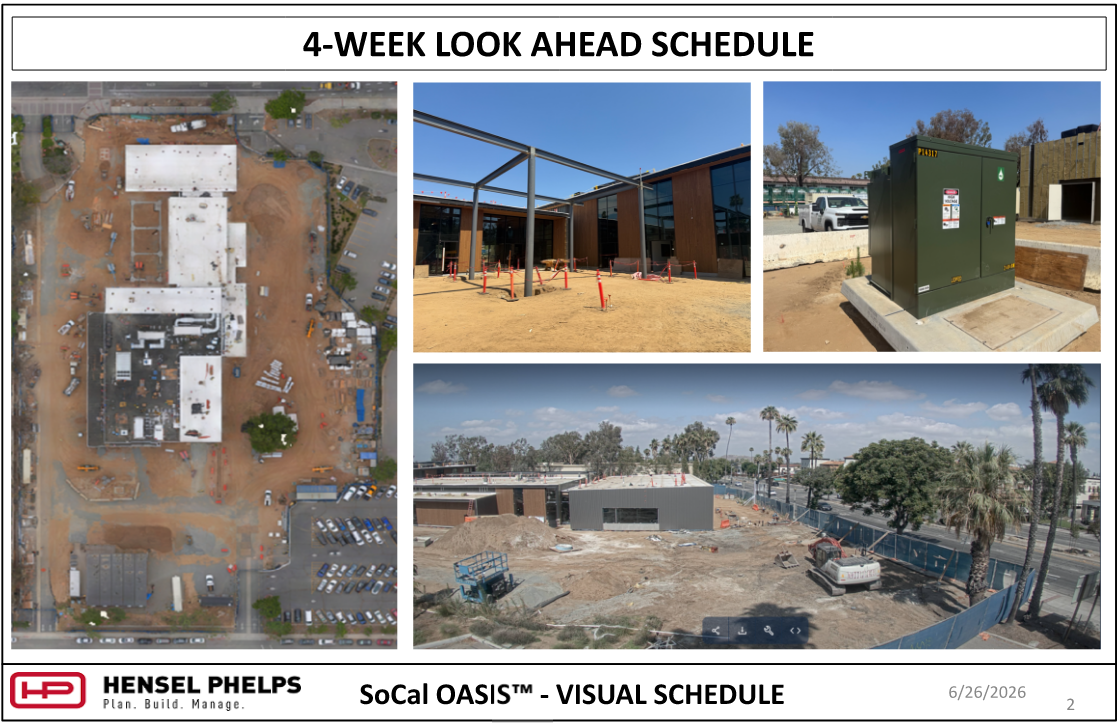

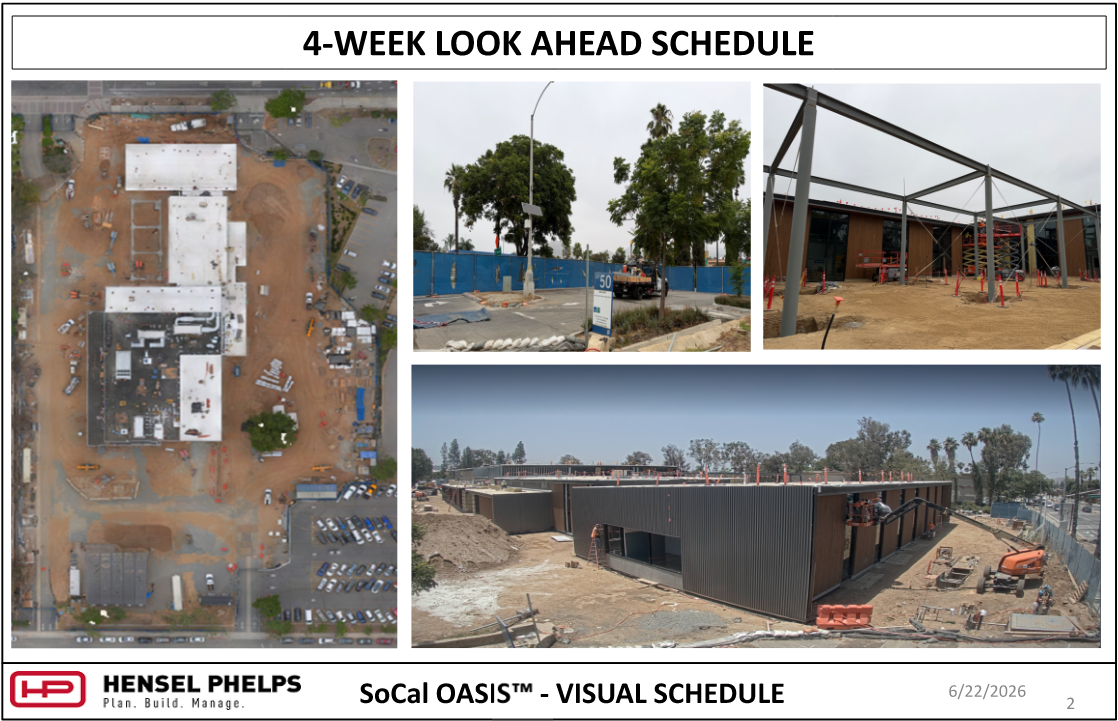

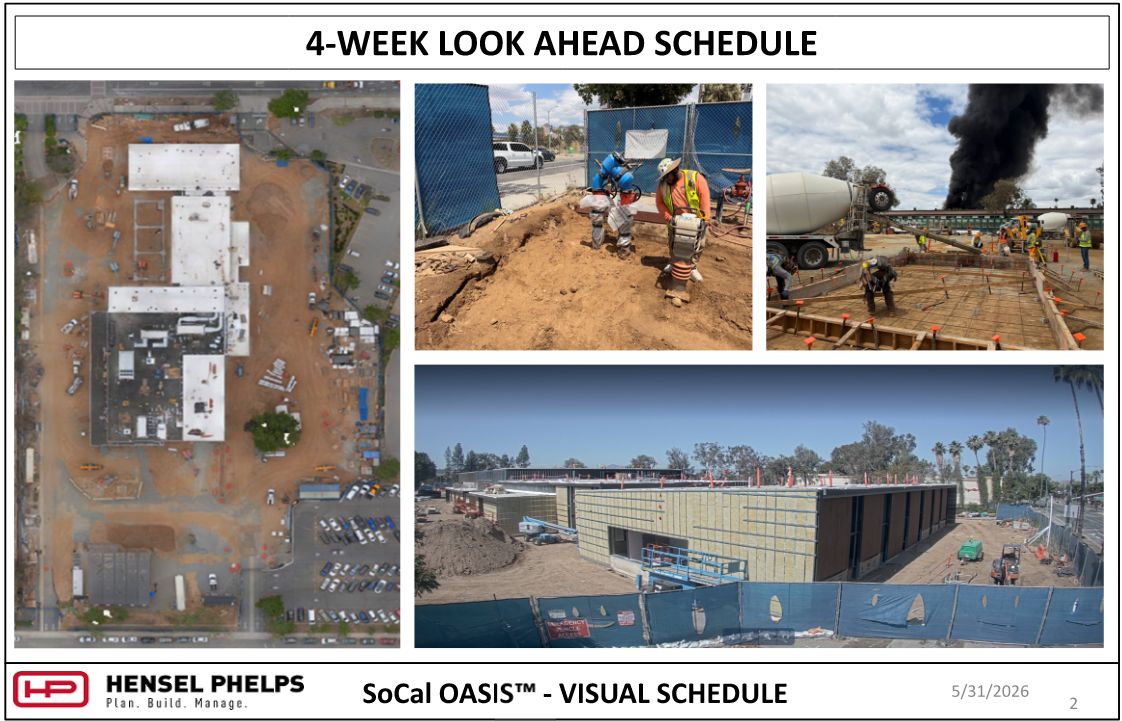

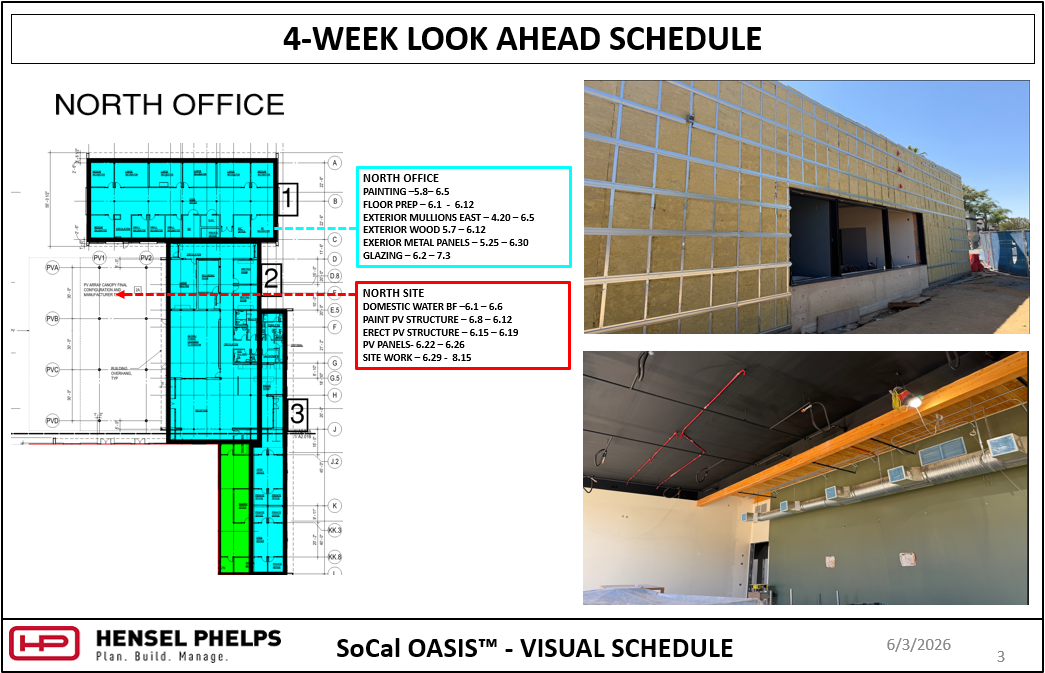

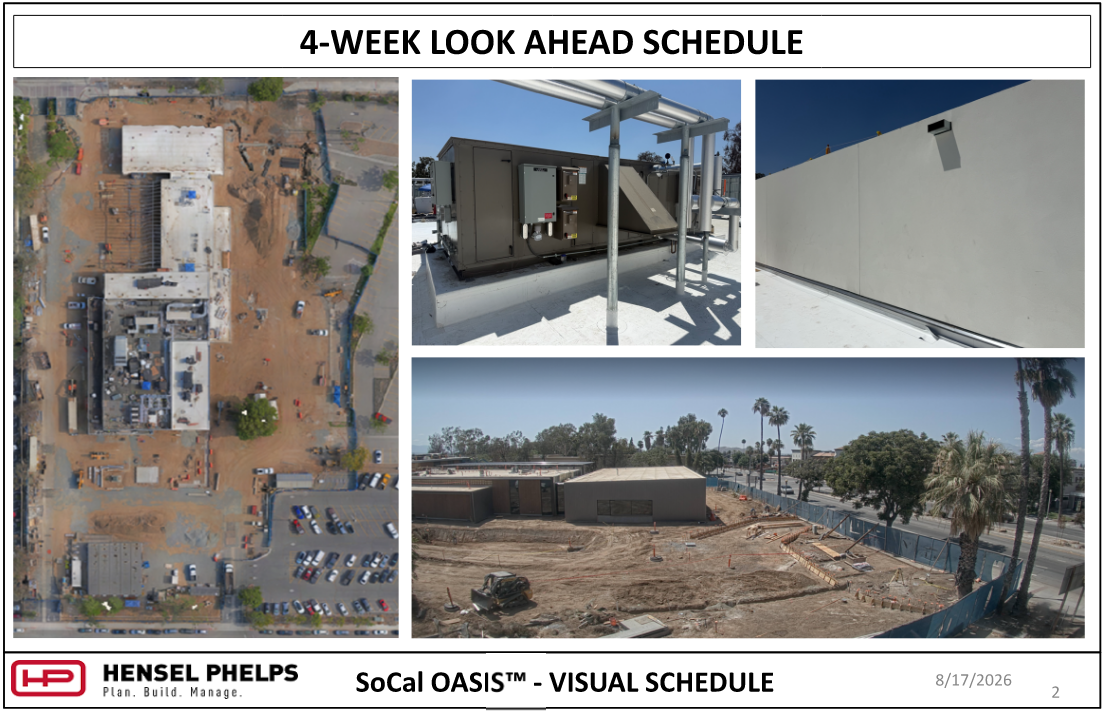

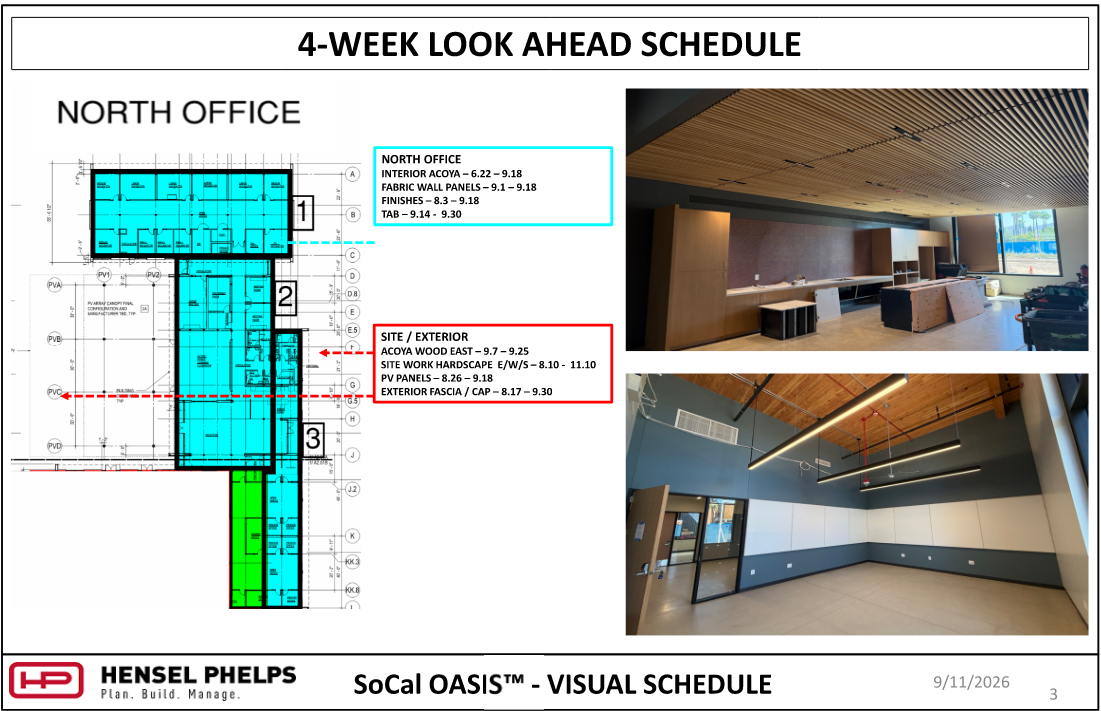

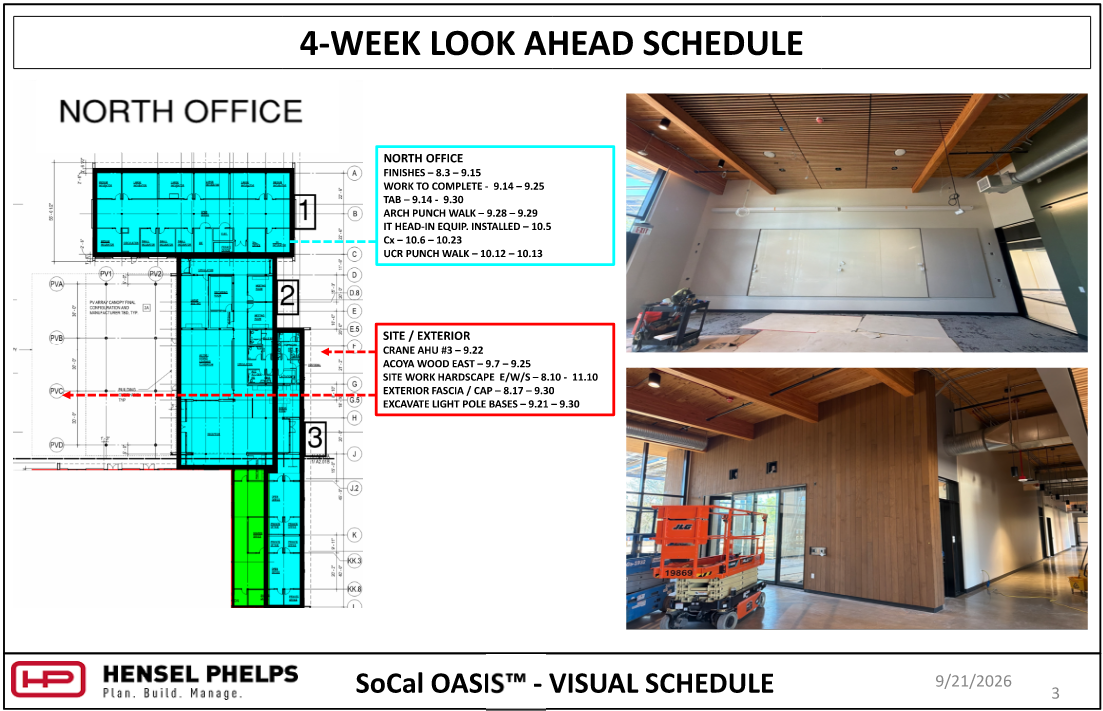

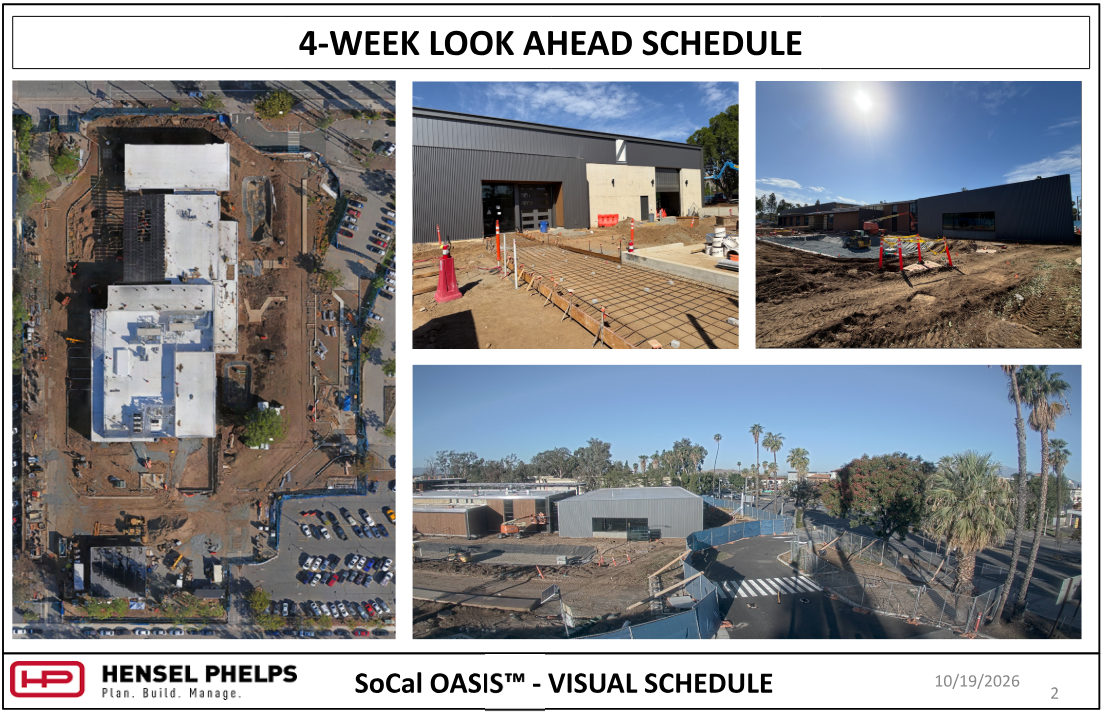

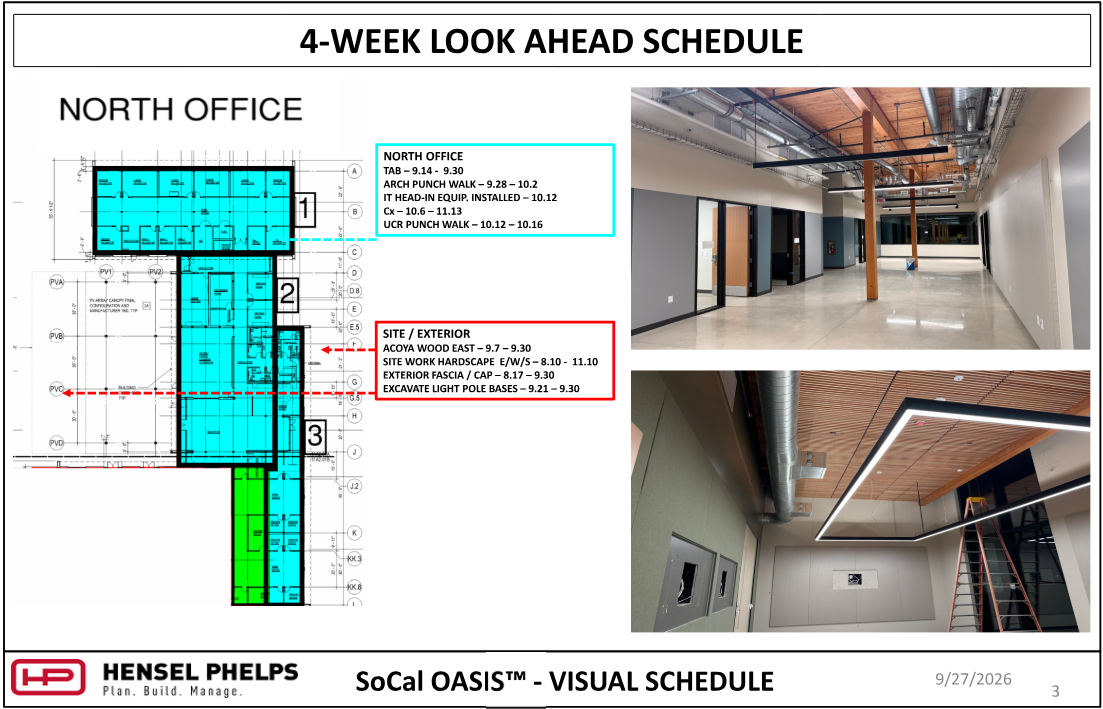

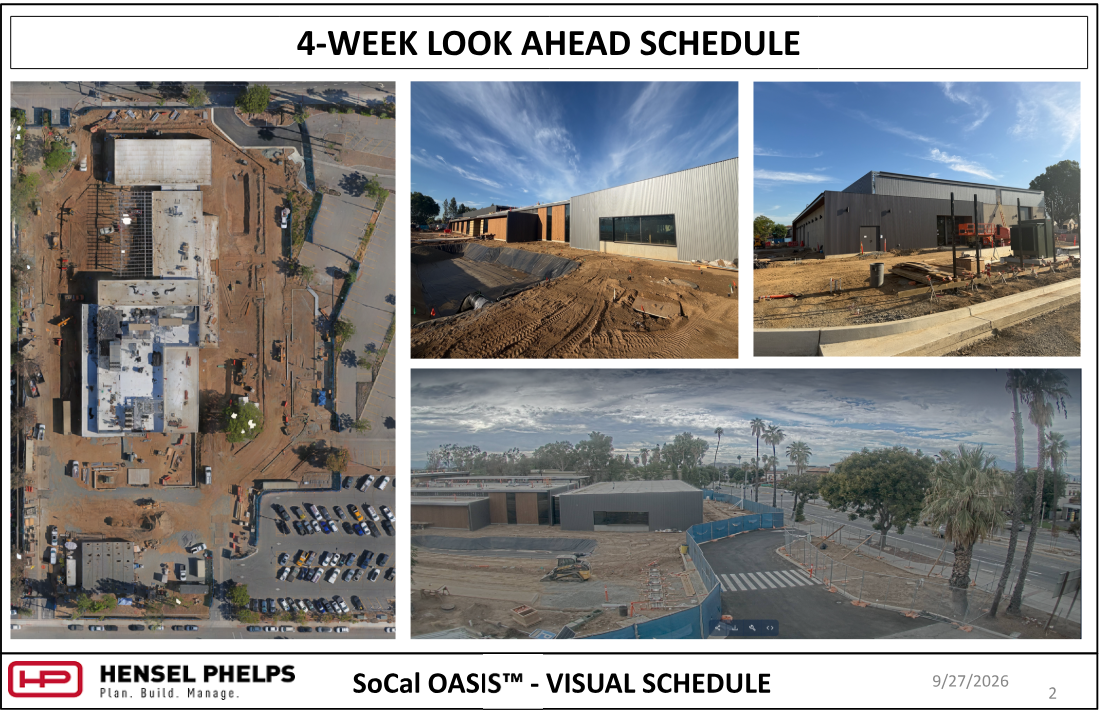

    Slide 2 of the Hensel Phelps visual schedule (October 19, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the site footprint with three photos: rebar grid prepped for a concrete walkway near dark corrugated exterior siding, site grading and staging in front of low-rise structures, and an elevated wide shot showing paved roadways, crosswalk markings, and perimeter fencing near palm trees.

    Slide 3 of the Hensel Phelps visual schedule (October 19, 2026) outlines "North Office" and exterior tasks through mid-November—including TAB report review, UCR punch corrections, commissioning, ACOYA wood east, and light pole base excavation. The highlighted floor plan is paired with two interior photos: an upper image of a presentation room featuring a mounted wall monitor beneath continuous overhead ductwork and accent lighting, and a lower image showing an accessible restroom.

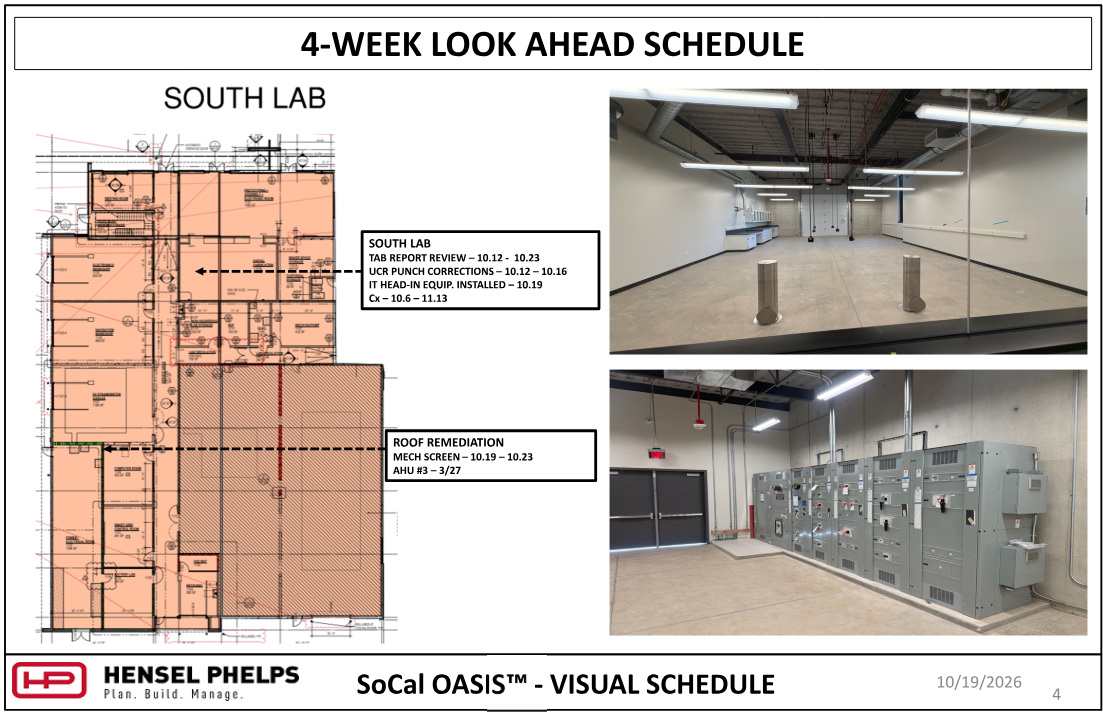

    Slide 4 of the Hensel Phelps visual schedule (October 19, 2026) outlines "South Lab" buildout and roof remediation tasks through mid-November—including TAB report review, UCR punch corrections, commissioning, mechanical screens, and AHU #3. The highlighted floor plan is paired with two photos: an upper image viewing into a clean, empty lab room through a glass wall showing suspended linear lights, and a lower image showing a newly installed gray electrical switchgear panel array alongside double exit doors.

    Slide 5 of the Hensel Phelps visual schedule (October 19, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The rendering shows a presentation or lecture room setup with rows of chairs, dual ceiling-mounted projection screens on the left, and a front wall equipped with a digital display, whiteboard, and dark storage cabinets.

    Current Week – October 19, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – 10.20

    Concrete trucks

    Mid-level construction noise

    Building Site

    PV Underground / E-Shut-Off

    Mini Ex

    Low-level and mid-level construction noise

    Building Site

    Tree Setting

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Light Pole Excavation

    Back-hoe

    Low-level and mid-level construction noise

    Building Site

    Site Hardscape East / West

    Misc. Equipment

    Low-level and mid-level construction noise

    Building Site

    Bio-Basin

    Skip Loader

    Low-level construction noise

    Building Site

    Fascia / Parapet Caps

    Scissor Lift

    Low-level construction noise

    Building Site

    Underground Site Electrical

    Mini Ex

    Low-level construction noise

    Building Site

    Irrigation

    Mini Ex

    Low-level and mid-level construction noise

    Building Site

    Exterior Lights / Devices

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Acoya Wood

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Glazing Replacement

    Boom Lift & Forklift

    Low-level and mid-level construction noise

    Building

    Interior UCR Punchlist Corrections

    Low-level construction noise

    Building

    Fire Alarm Testing

    Low-level and mid-level construction noise

    Building

    UCR Head-In Equipment / WAPS

    Scissor Lift

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Cx-PFT / Fire Alarm Testing

    Scissor Lift

    Low-level construction noise

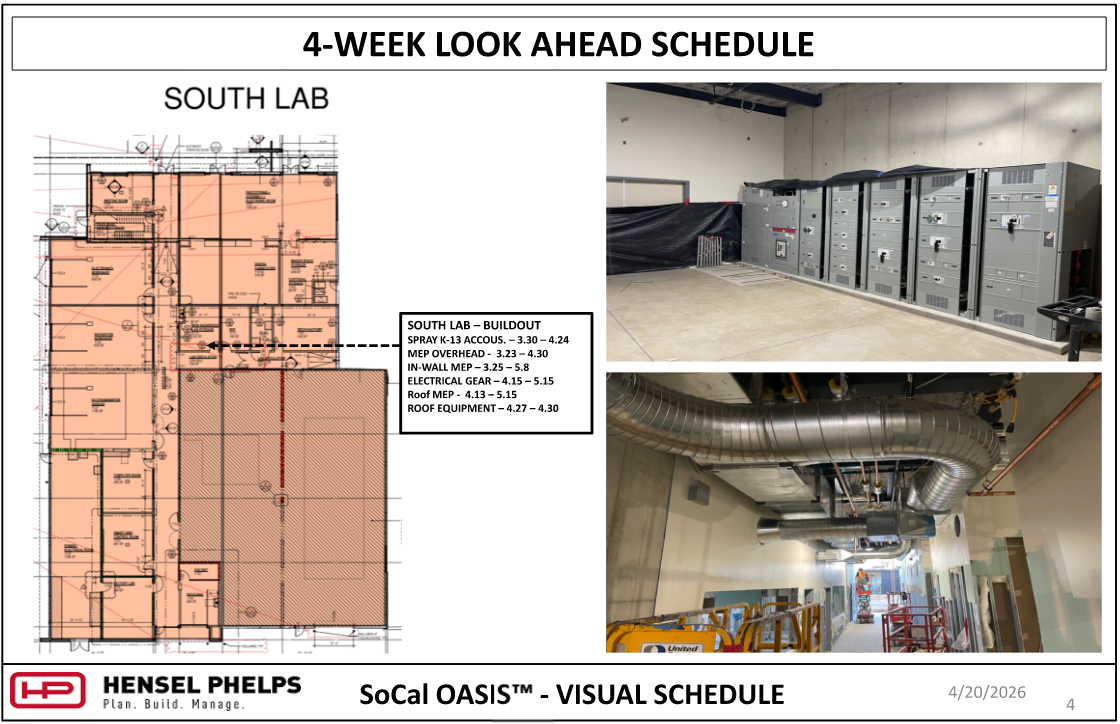

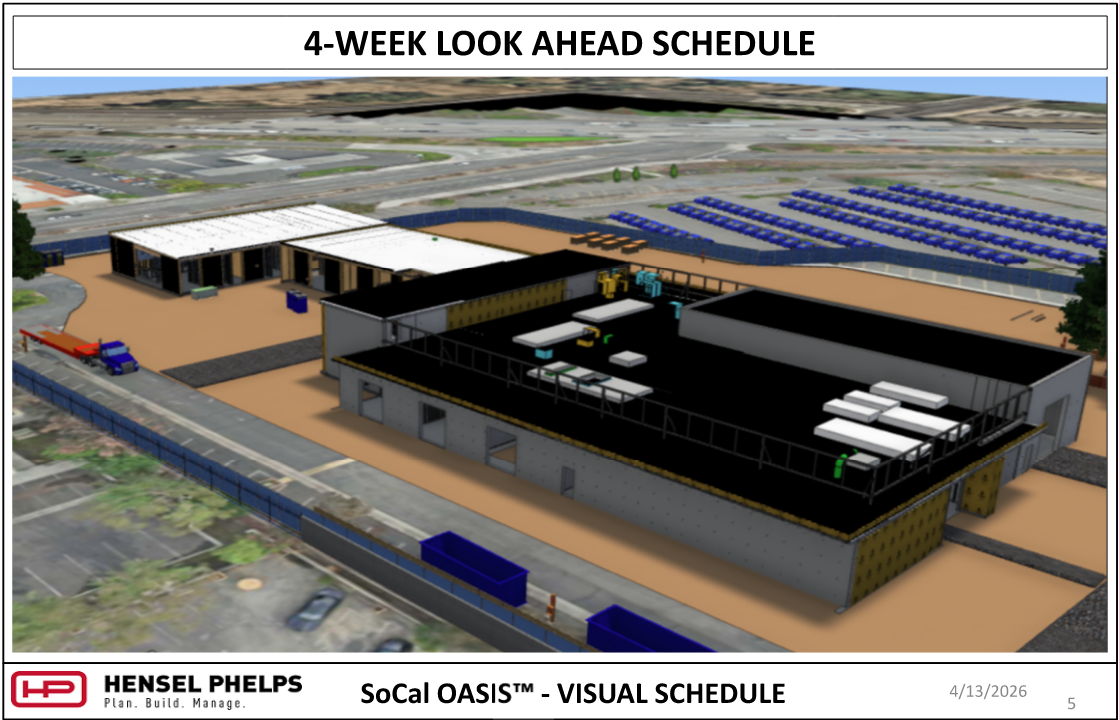

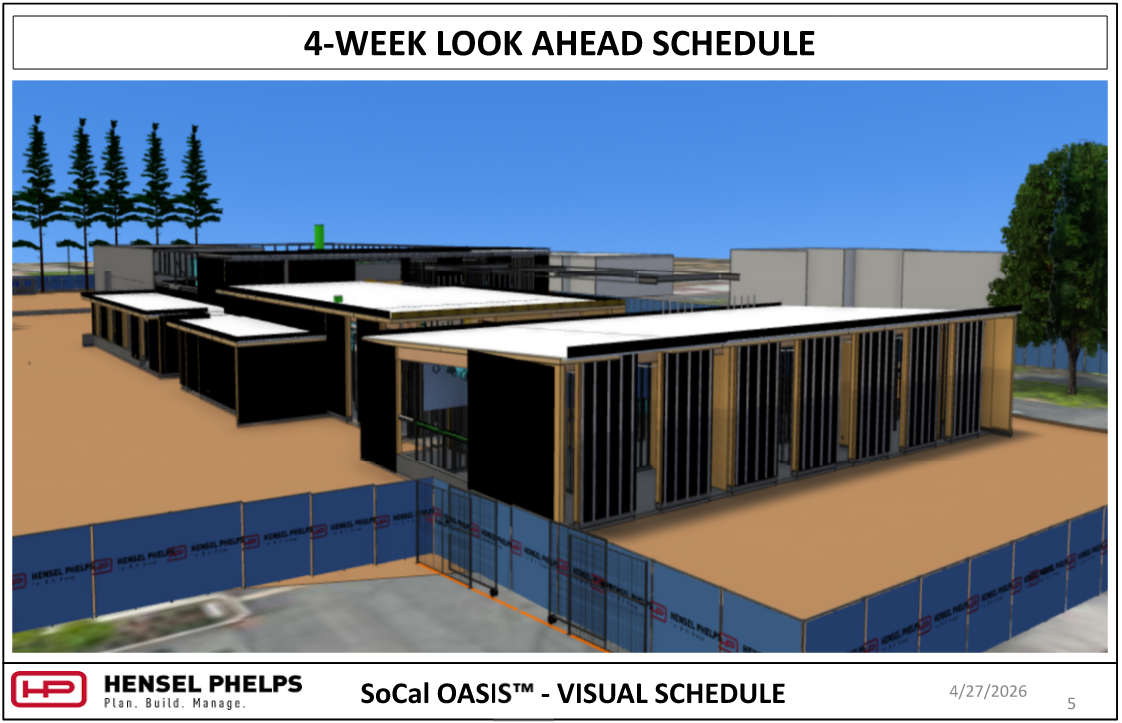

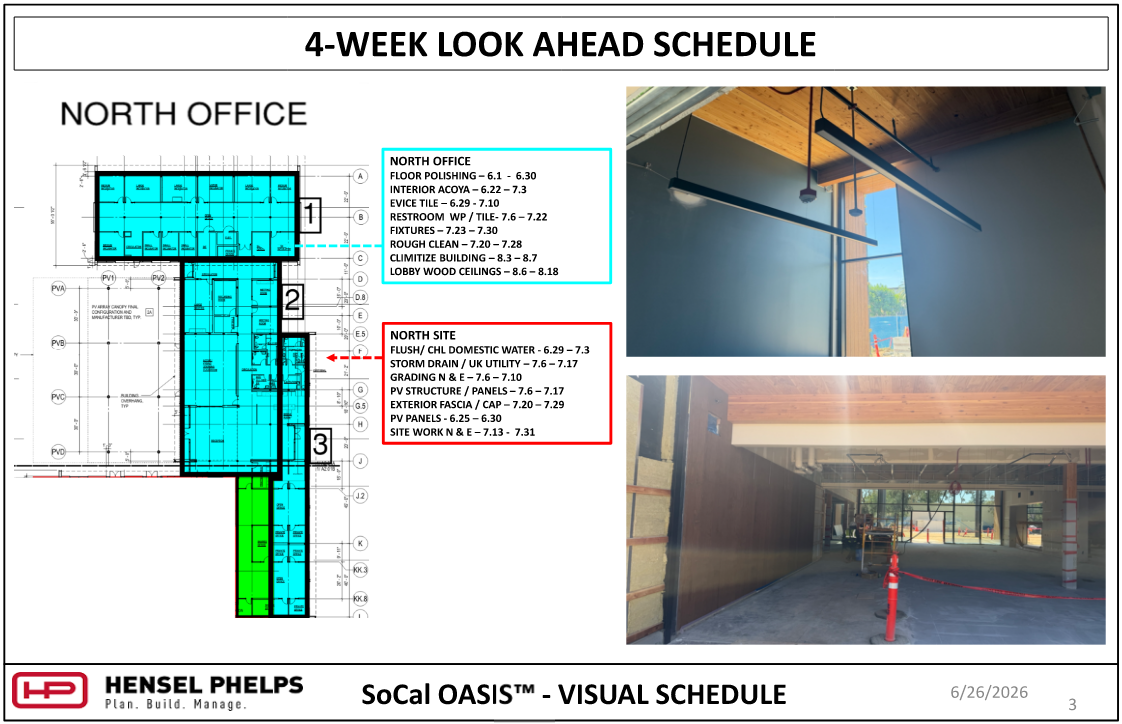

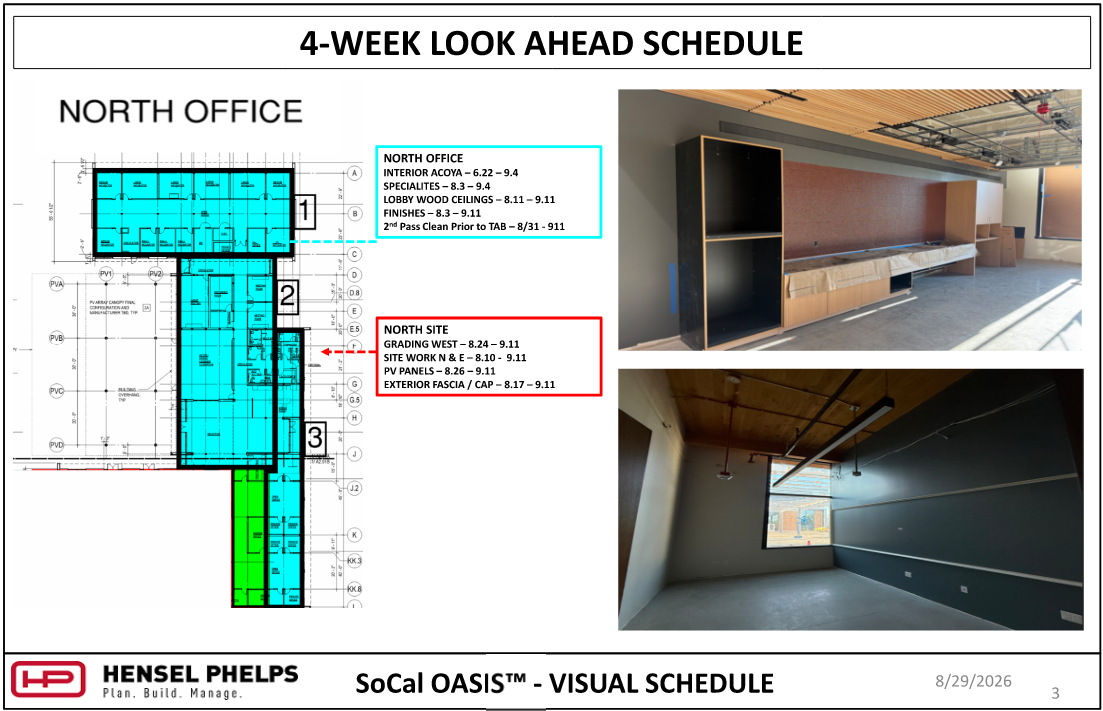

    Week of October 26, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Parking Lot 51 Entrance Everton Closed

    Low-level and Mid-level construction noise

    Building Site

    Demo – Parking Lot 51 Entrance Everton

    Low-level and Mid-level construction noise

    Building Site

    Construction Trailer Removal

    Low-level and Mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – 10.26, 10.28 & 10.30

    Concrete trucks

    Mid-level construction noise

    Building Site

    Metal Panels Mech Screen Remediation

    Low-level and Mid-level construction noise

    Building Site

    Tree Setting

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Bio Basin

    Skip Loader

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East / West

    Misc. Equipment

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Glazing Replacement

    Boom Lift & Forklift

    Low-level and Mid-level construction noise

    Building

    UCR Punch Corrections

    Scissor Lift

    Low-level construction noise

    Building

    Cx - FPT

    Low-level construction noise

    Week of November 2, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – 11.2, 11.4 & 11.6

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Parking Lot 51 Entrance Everton Closed

    Low-level and Mid-level construction noise

    Building Site

    Parking Lot 51 Entrance Everton - UG

    Low-level and Mid-level construction noise

    Building Site

    Grading South Lot

    Low-level and Mid-level construction noise

    Building Site

    Tree Setting & Landscape

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Hardscape

    Low-level and Mid-level construction noise

    Building Site

    Glazing Replacement

    Boom Lift & Forklift

    Low-level and Mid-level construction noise

    Building

    Interior UCR Punchlist - Corrections

    Low-level construction noise

    Building

    Cx - FPT

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    UCR South Parking Lot Entrance Closed (Everton) – (10/26 – 11/20)

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

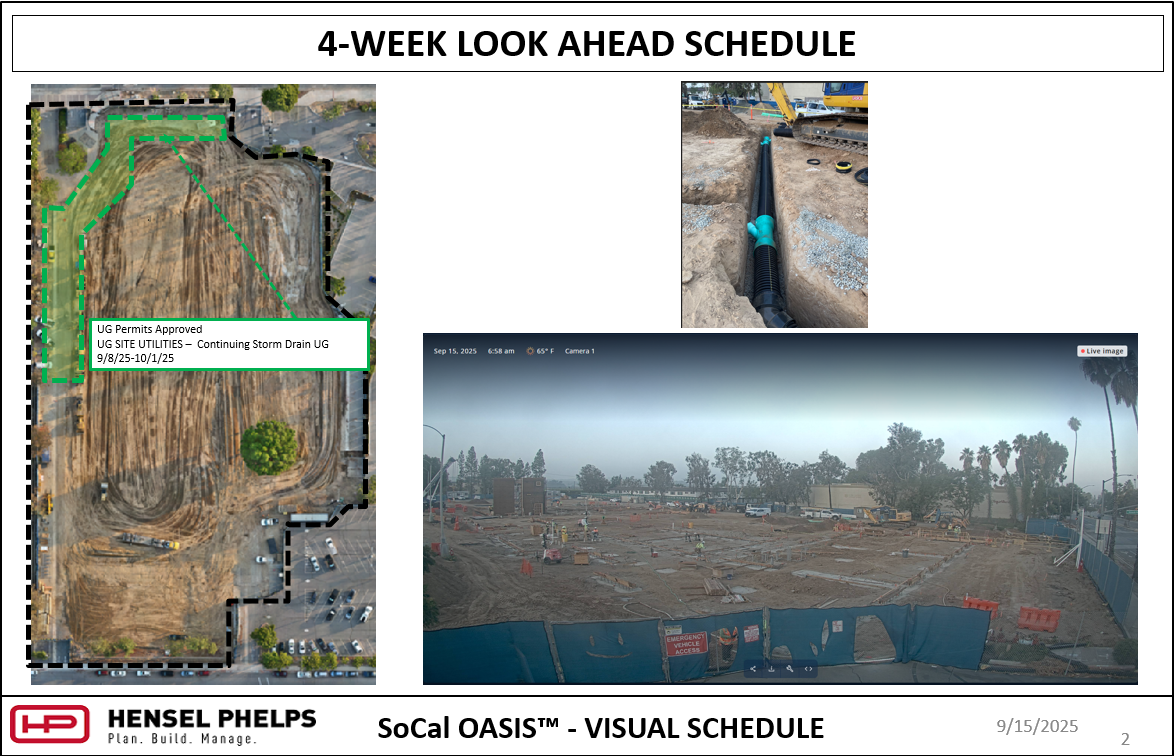

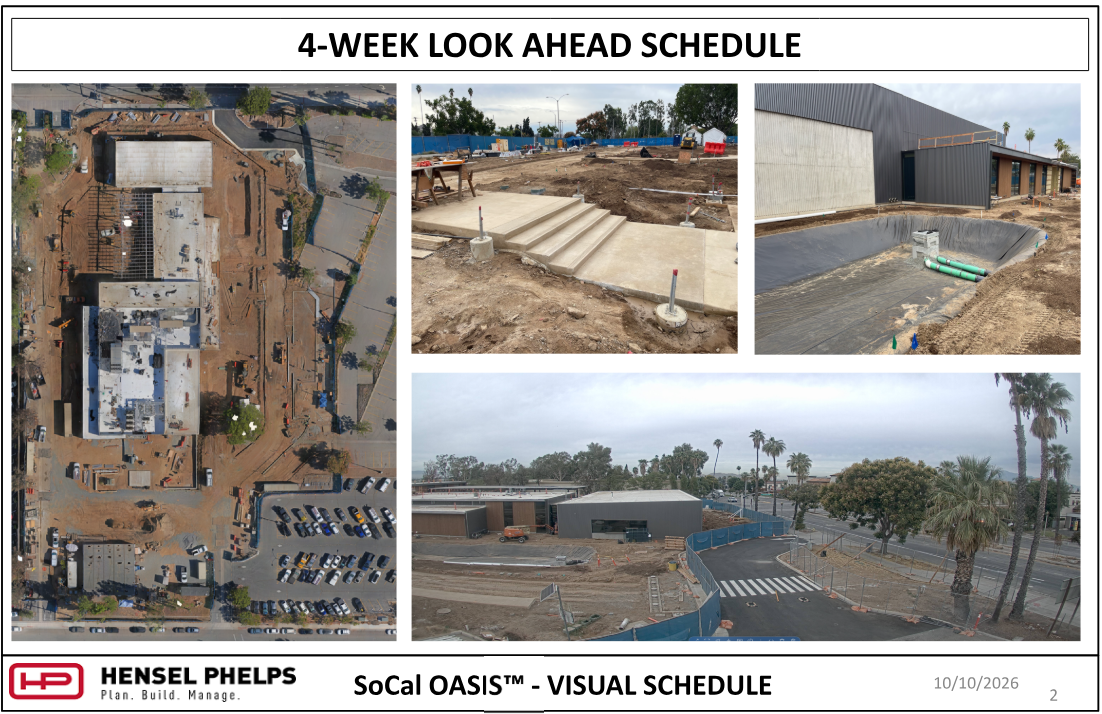

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (10/12/2026)

    Slide 2 of the Hensel Phelps visual schedule (October 10, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the site footprint with three photos: freshly poured concrete steps surrounded by dirt, a lined retention pond with green piping alongside dark building siding, and an elevated wide view showing paved roads, crosswalk markings, and perimeter fencing near palm trees.
    Slide 3 of the Hensel Phelps visual schedule (October 10, 2026) outlines "North Office" and exterior tasks through mid-November—including TAB report review, UCR punch items, IT head-in equipment installation, commissioning, ACOYA wood east, and light pole base excavation. The highlighted floor plan is paired with two interior photos: an upper image showing a long polished hallway featuring exposed wood ceiling beams and hanging linear lights, and a lower image showing an interior corridor.
    Slide 4 of the Hensel Phelps visual schedule (October 10, 2026) outlines "South Lab" buildout and roof remediation tasks through late October—including painting support steel, plastering, and mechanical screen framing and installation. The highlighted floor plan is paired with two photos: an upper image of an open lab space featuring suspended linear lights and a orange scissor lift, and a lower image showing a office area with a wooden reception desk, slatted wood ceilings, and carpeted flooring.

    Slide 5 of the Hensel Phelps visual schedule (October 10, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The rendering features a conference room setting with a central wooden table surrounded by chairs, dual wall-mounted screens above lower storage cabinets, vibrant accent walls, large window panels, and a prominent rectangular suspended light fixture overhead.

    Current Week – October 12, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – 10.14 & 10.16

    Concrete trucks

    Mid-level construction noise

    Building Site

    PV Underground / E-Shut-Off

    Mini Ex

    Low-level and mid-level construction noise

    Building Site

    Tree Setting

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Light Pole Excavation

    Back-hoe

    Low-level and mid-level construction noise

    Building Site

    Site Hardscape East / West

    Misc. Equipment

    Low-level and mid-level construction noise

    Building Site

    Bio-Basin

    Skip Loader

    Low-level construction noise

    Building Site

    Fascia / Parapet Caps

    Scissor Lift

    Low-level construction noise

    Building Site

    Underground Site Electrical

    Mini Ex

    Low-level construction noise

    Building Site

    Irrigation

    Mini Ex

    Low-level and mid-level construction noise

    Building Site

    Exterior Lights / Devices

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Acoya Wood

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Glazing Replacement

    Boom Lift & Forklift

    Low-level and mid-level construction noise

    Building

    Interior UCR Punchlist

    Low-level construction noise

    Building

    Fire Alarm Testing

    Low-level and mid-level construction noise

    Building

    UCR Head-In Equipment / WAPS

    Scissor Lift

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Cx-PFT / Fire Alarm Testing

    Scissor Lift

    Low-level construction noise

    Week of October 19, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – 10.19, 10.21 & 10.23

    Concrete trucks

    Mid-level construction noise

    Building Site

    Metal Panels Mech Screen Remediation

    Low-level and Mid-level construction noise

    Building Site

    Tree Setting

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Bio Basin

    Skip Loader

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East / West

    Misc. Equipment

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Glazing Replacement

    Boom Lift & Forklift

    Low-level and Mid-level construction noise

    Building

    UCR Punch Corrections

    Scissor Lift

    Low-level construction noise

    Building

    Interior UCR Punchlist - Corrections

    Low-level construction noise

    Building

    Cx - PFT

    Low-level construction noise

    Week of October 26, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – 10.26, 10.28 & 10.30

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Parking Lot 51 Entrance Everton Closed

    Low-level and Mid-level construction noise

    Building Site

    Demo – Parking Lot 51 Entrance Everton

    Low-level and Mid-level construction noise

    Building Site

    Construction Trailer Removal

    Low-level and Mid-level construction noise

    Building Site

    Tree Setting & Landscape

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Hardscape

    Low-level and Mid-level construction noise

    Building Site

    Glazing Replacement

    Boom Lift & Forklift

    Low-level and Mid-level construction noise

    Building

    Interior UCR Punchlist - Corrections

    Low-level construction noise

    Building

    Cx - FPT

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    UCR South Parking Lot Entrance Closed (Everton) – (10/26 – 11/20)

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

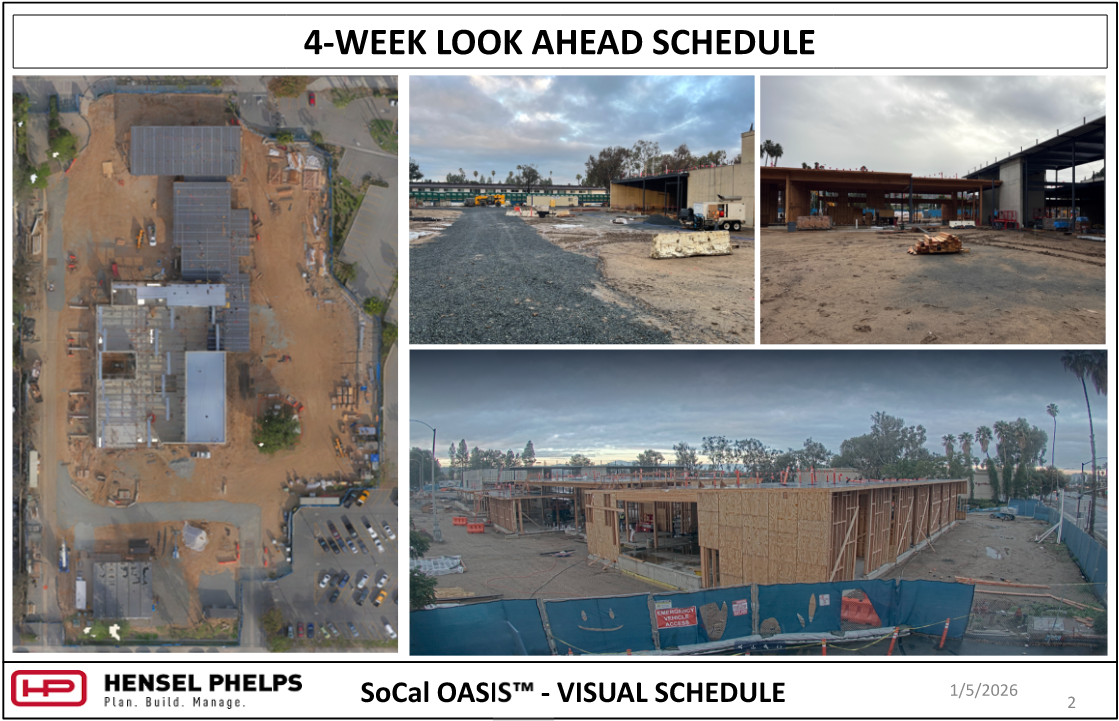

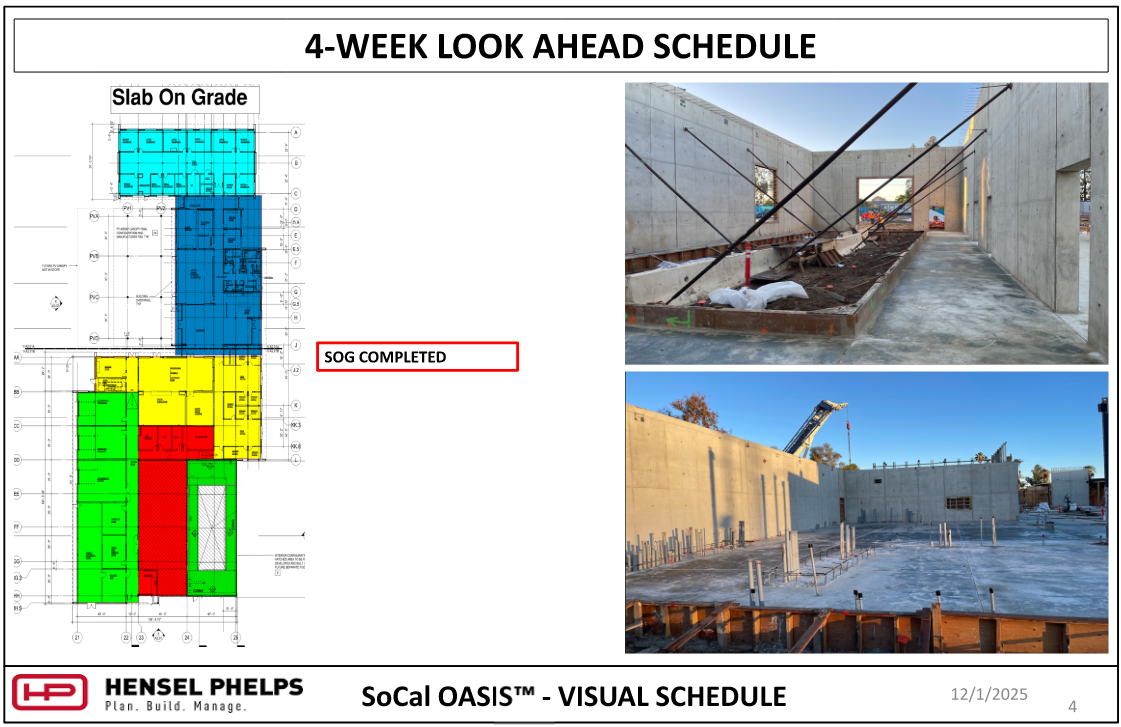

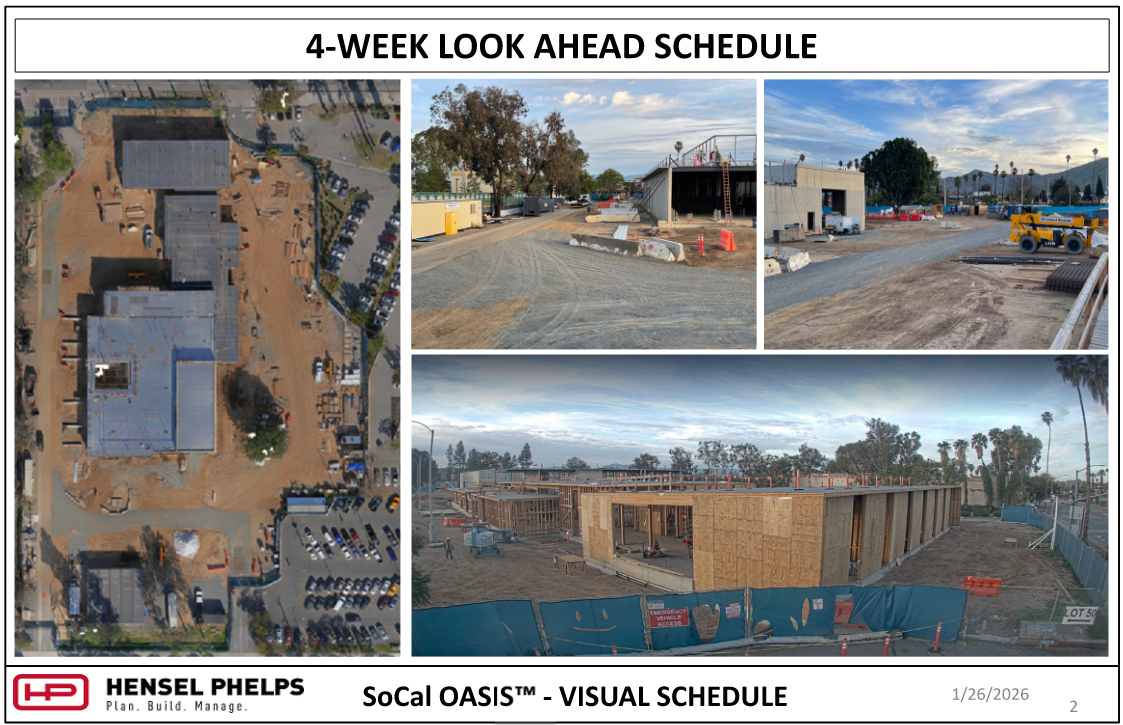

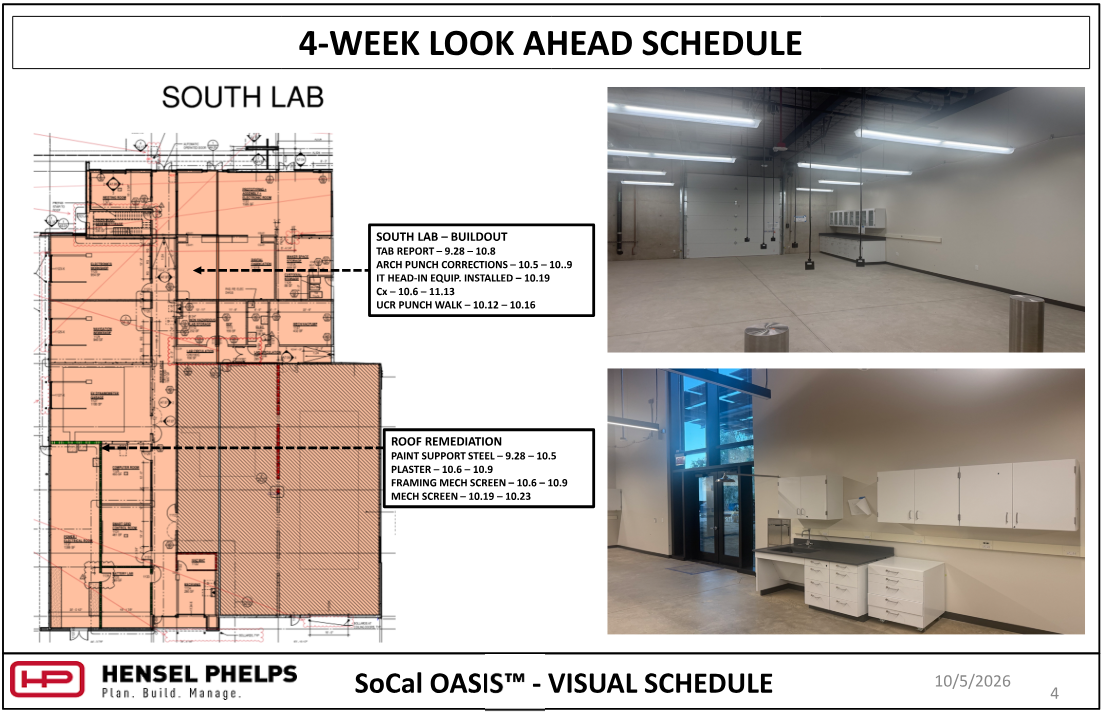

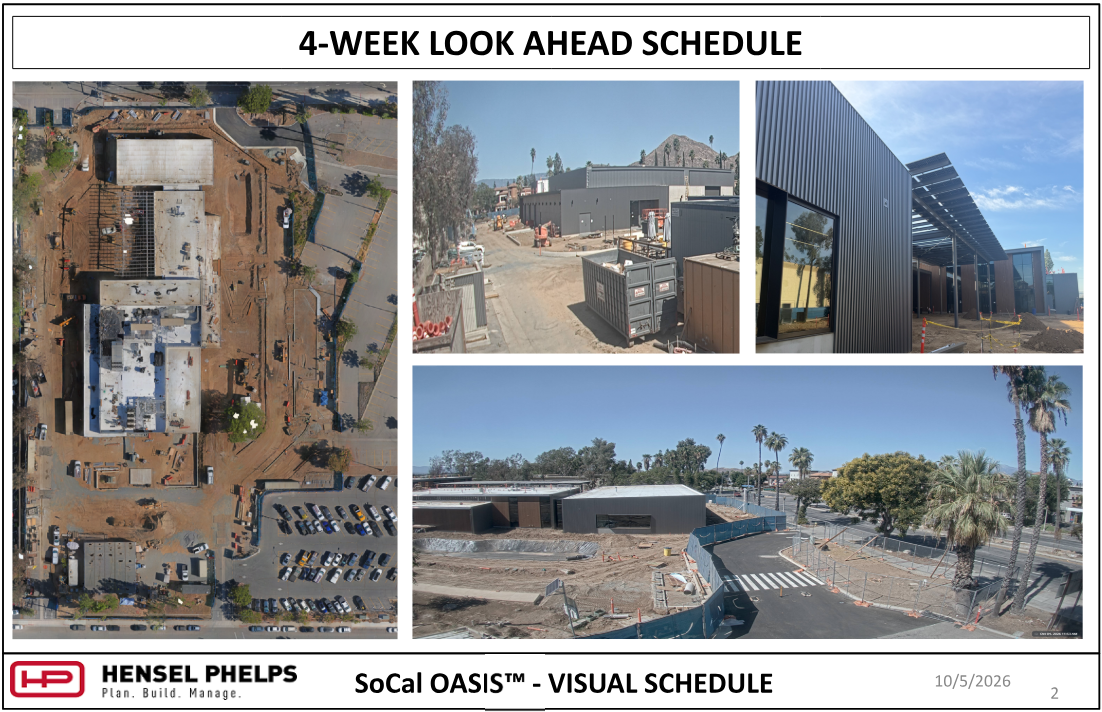

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (10/5/2026)

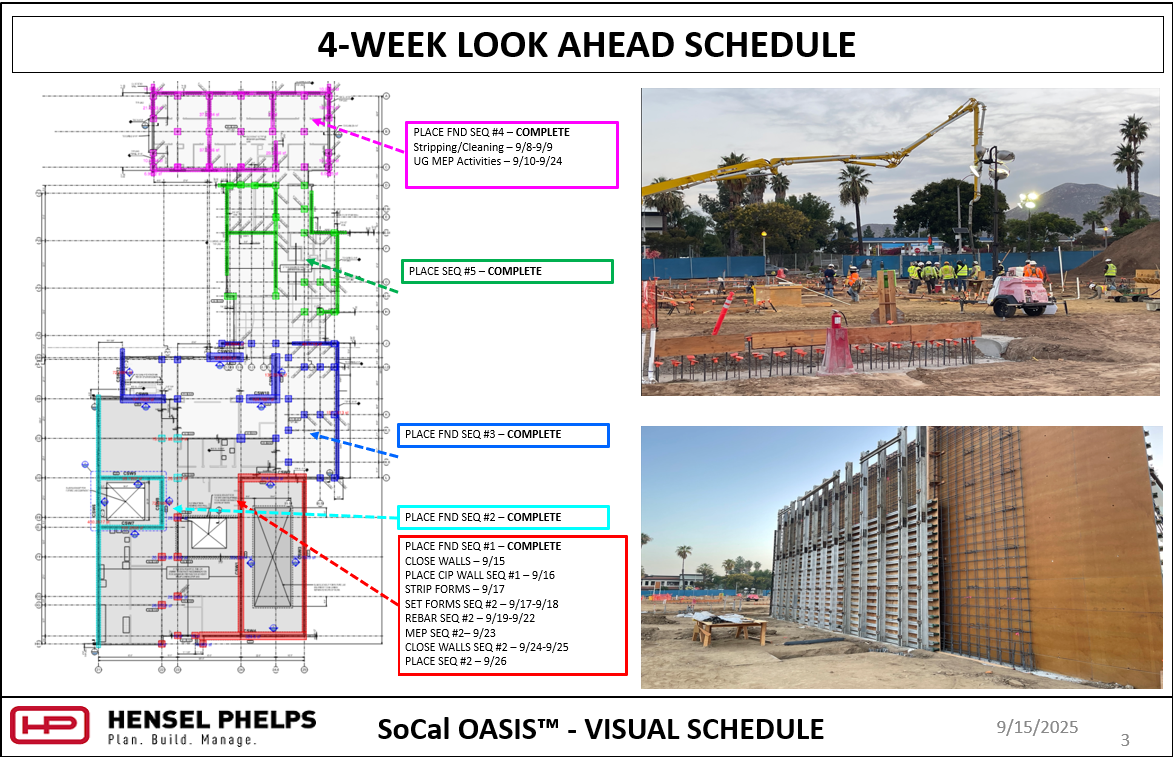

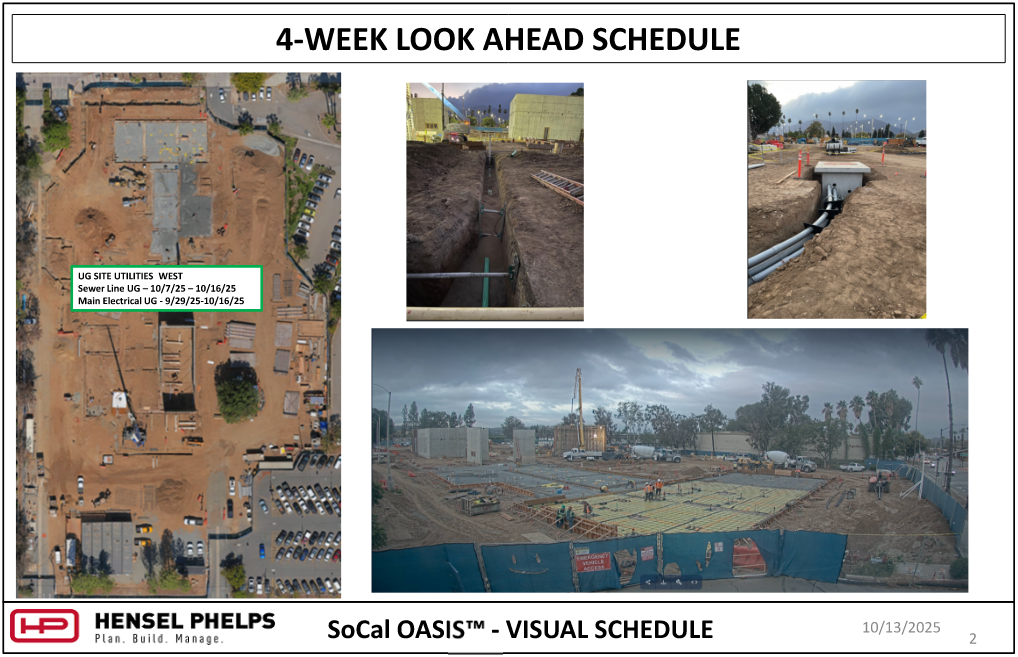

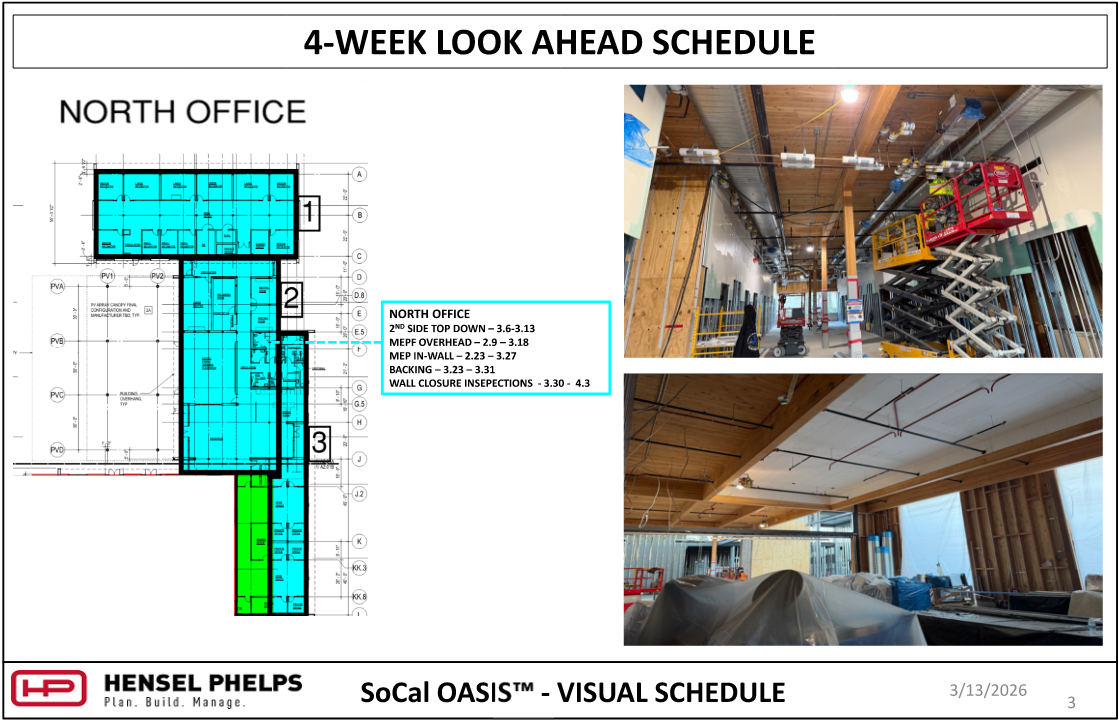

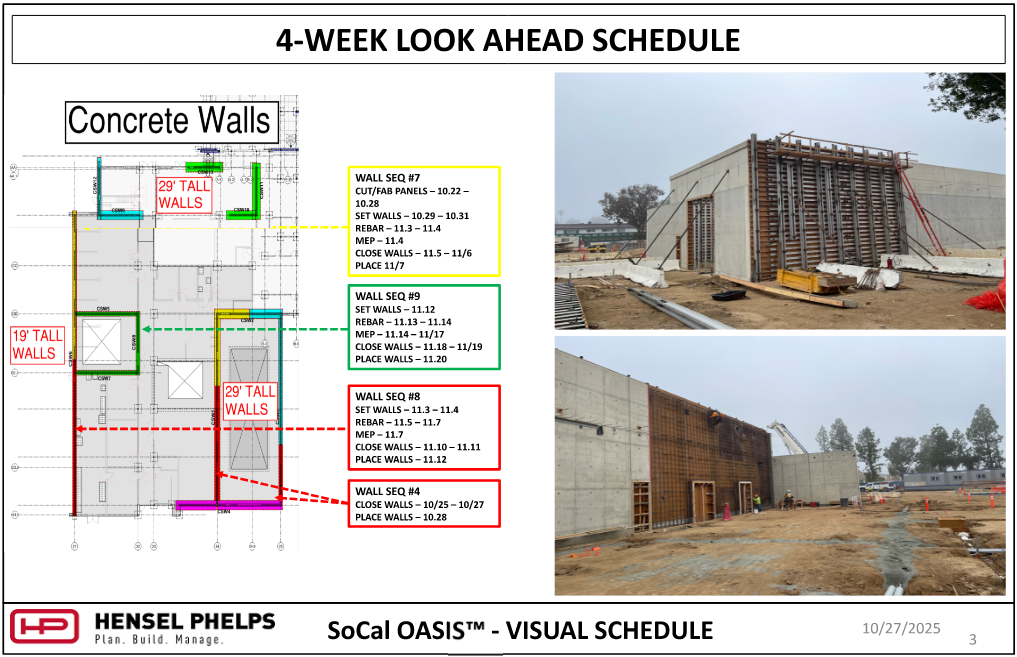

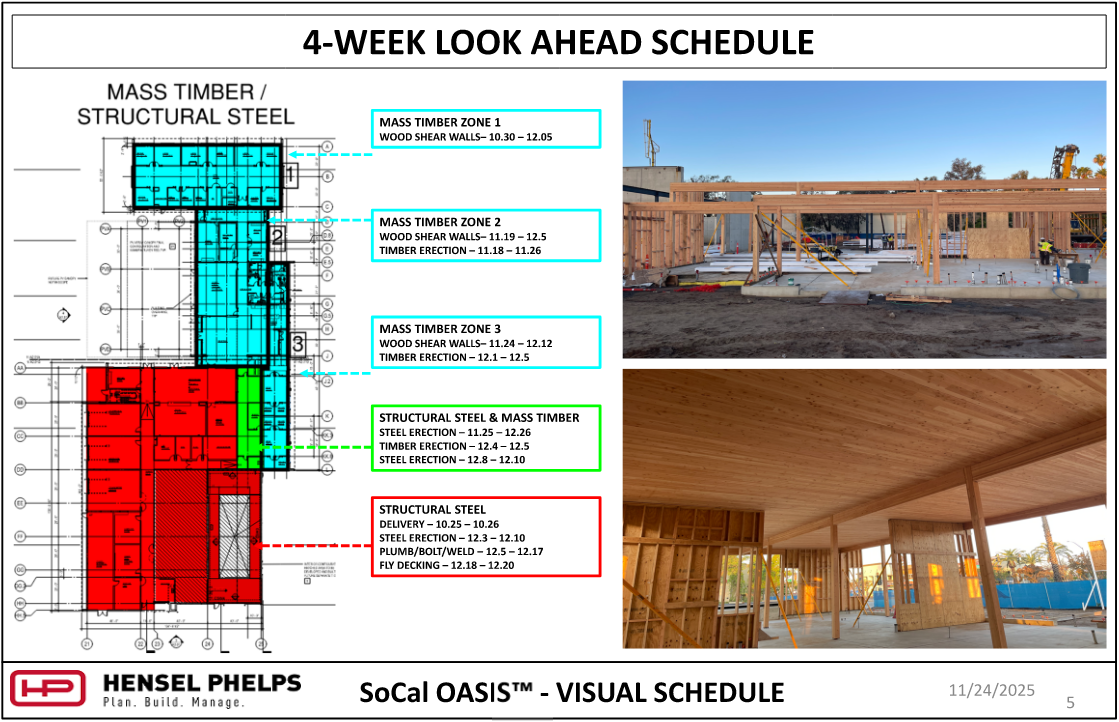

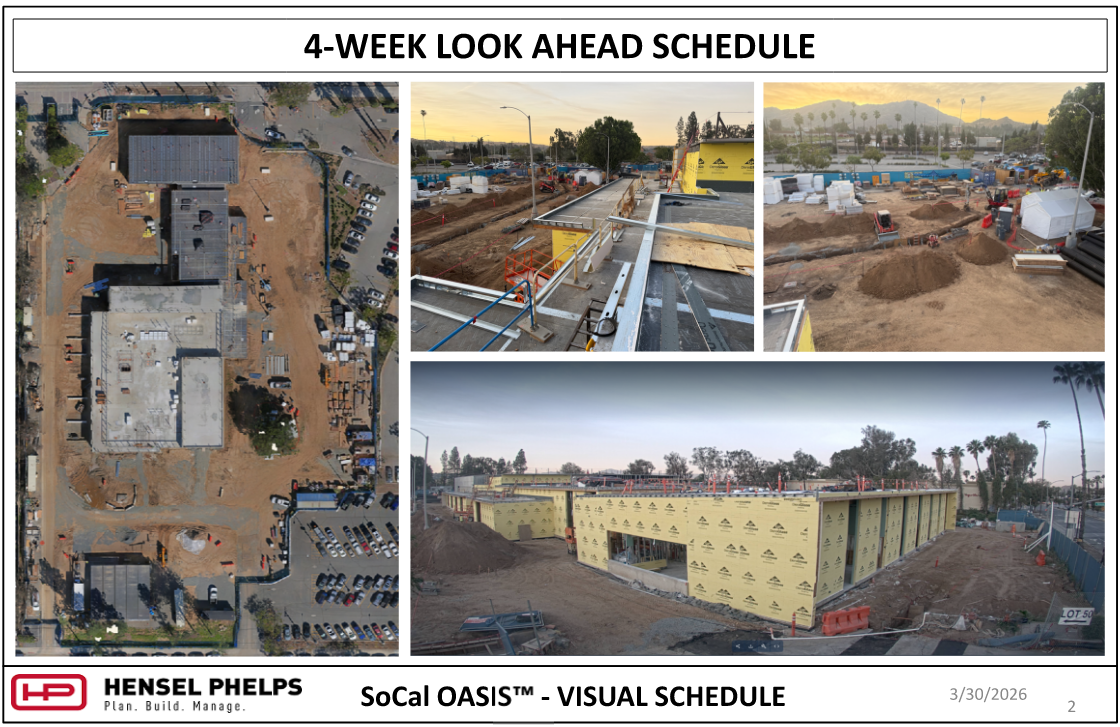

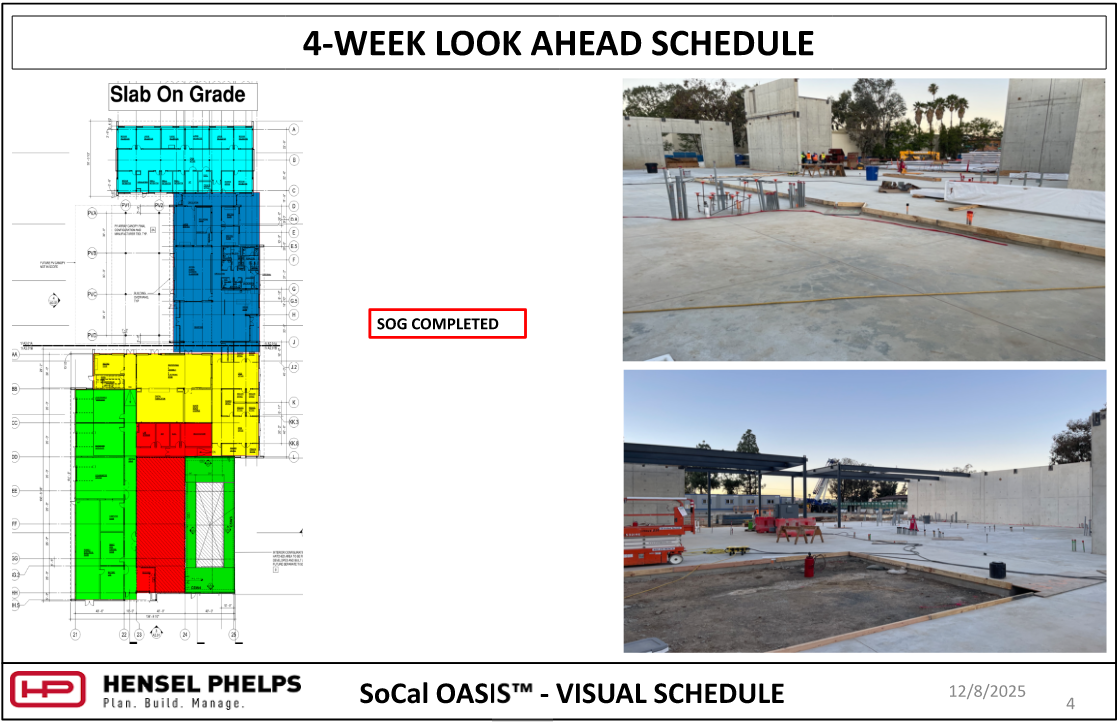

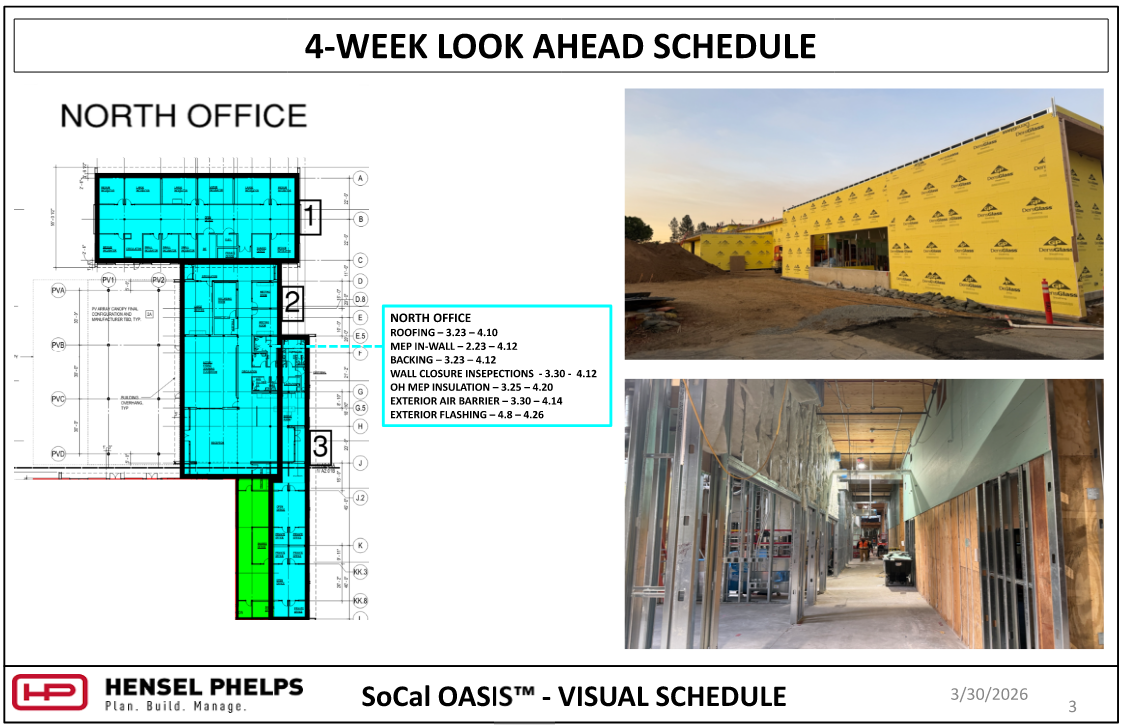

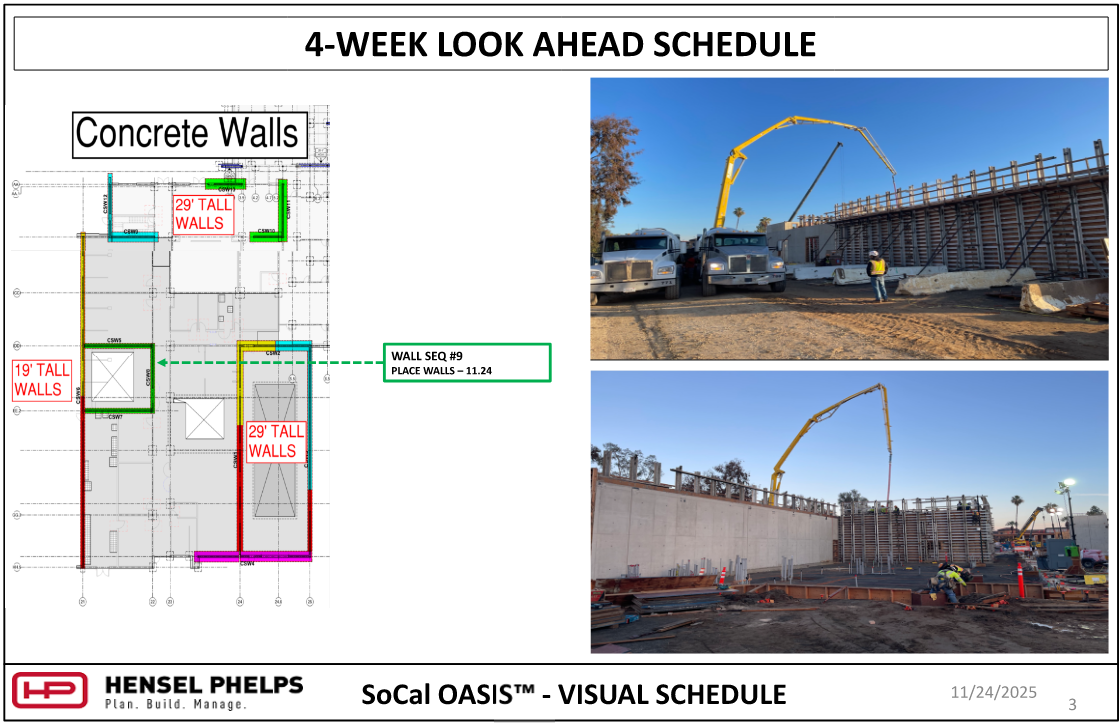

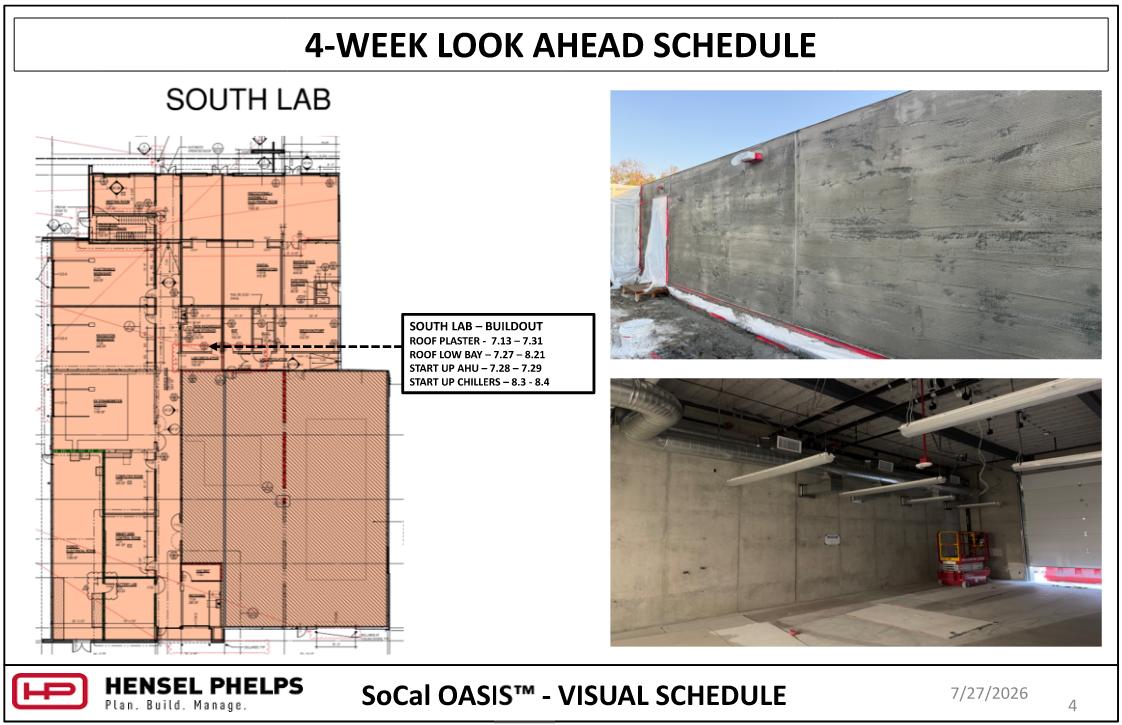

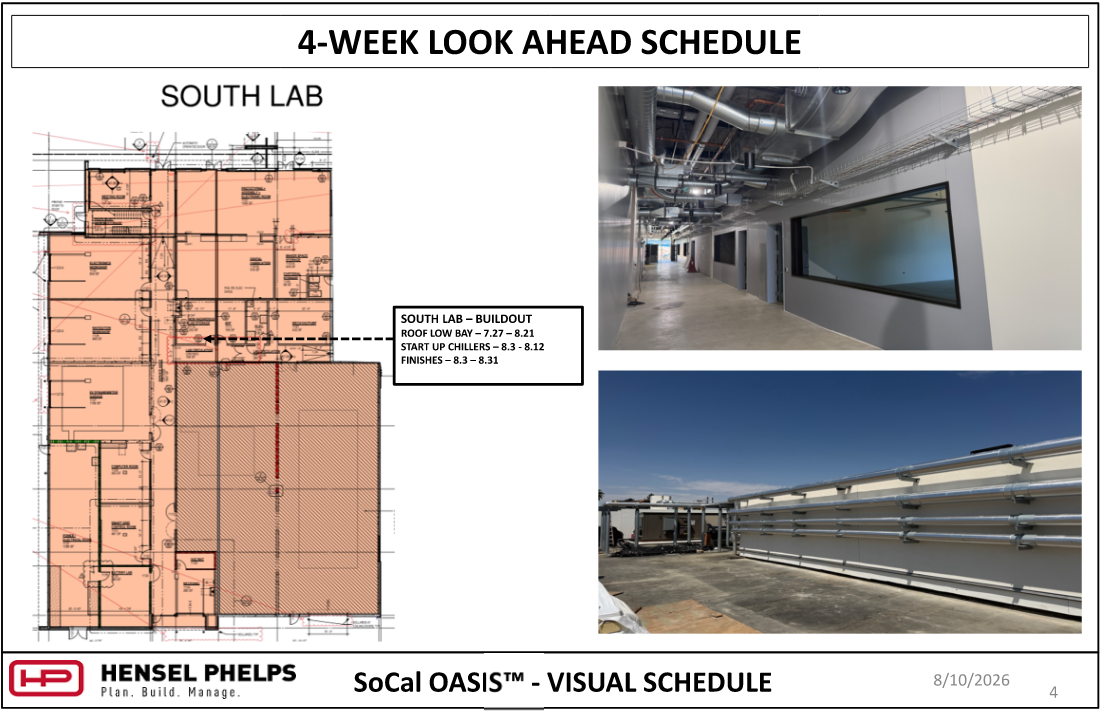

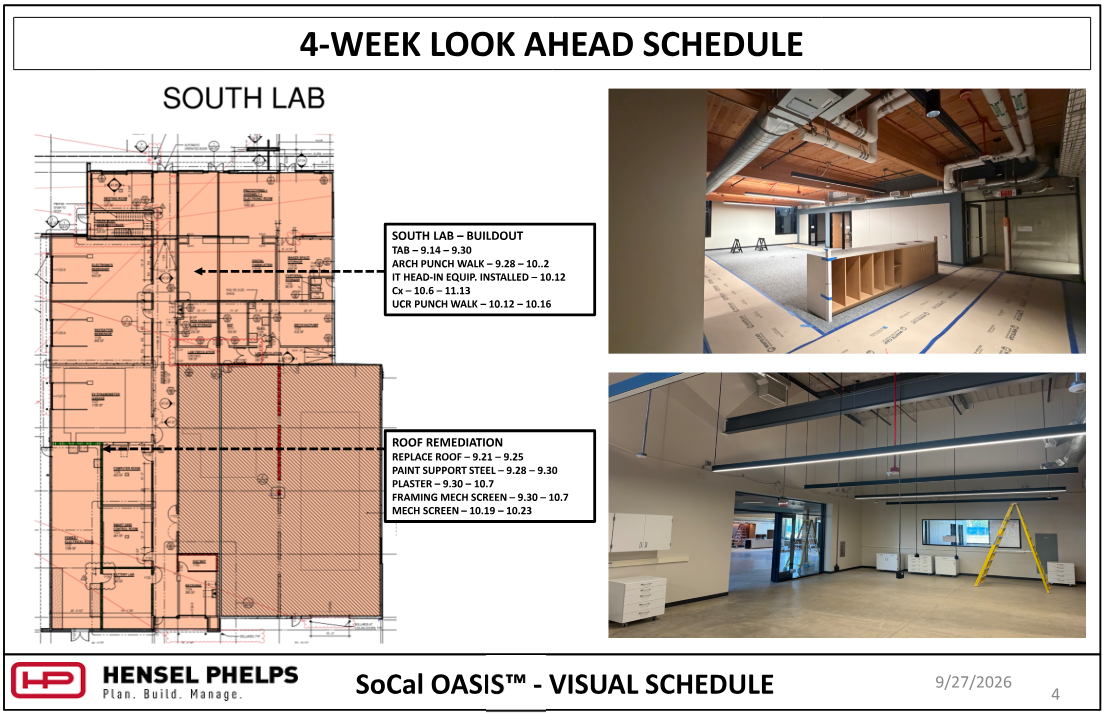

    Slide 2 of the Hensel Phelps visual schedule (October 5, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the site footprint with three photos: storage containers staged along an access road near background hills, dark corrugated metal building siding adjacent to a solar canopy, and an elevated wide view showing paved roadways, crosswalk markings, and perimeter fencing near palm trees.

    Slide 3 of the Hensel Phelps visual schedule (October 5, 2026) outlines "North Office" and exterior tasks through mid-November—including punch corrections, IT equipment setup, commissioning, site hardscape, and exterior fascia. The highlighted floor plan is paired with two photos: an upper image showing a modern restroom with dual sinks, mirrors, and tiled walling, and a lower image showing a large glass folding door system beneath wood ceiling beams and wall paneling.

    Slide 4 of the Hensel Phelps visual schedule (October 5, 2026) outlines "South Lab" buildout and roof remediation tasks through mid-November—including architectural punch corrections, IT equipment installation, commissioning, plastering, and mechanical screens. The highlighted floor plan is paired with two photos: an upper image of an open lab space with suspended linear lights and utility columns, and a lower image showing wall-mounted white cabinets, counter workspace, and a glass entry door system.

    Slide 5 of the Hensel Phelps visual schedule (October 5, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The rendering presents an elevated exterior view of the facility complex, featuring flat-roofed structures with dark siding, a recessed courtyard pit in the central ground area, and blue construction fencing along the perimeter.

    Current Week – October 5, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – 10.5, 10.7 & 10.9

    Concrete trucks

    Mid-level construction noise

    Building Site

    Roof Remediation – Paint, Framing & Plaster

    Low-level and mid-level construction noise

    Building Site

    Light Pole Excavation

    Back-hoe

    Low-level and mid-level construction noise

    Building Site

    Site Hardscape East / West

    Misc. Equipment

    Low-level and mid-level construction noise

    Building Site

    Bio-Basin Liner South

    Low-level construction noise

    Building Site

    Fascia / Parapet Caps

    Scissor Lift

    Low-level construction noise

    Building Site

    Underground Site Electrical

    Mini Ex

    Low-level construction noise

    Building Site

    Irrigation

    Mini Ex

    Low-level and mid-level construction noise

    Building Site

    Exterior Lights / Devices

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Acoya Wood

    Scissor Lift

    Low-level and mid-level construction noise

    Building

    Interior Architectural Punchlist Corrections

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    TAB Report / Fire Alarm Testing

    Scissor Lift

    Low-level construction noise

    Week of October 12, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – 10.12, 10.14 & 10.16

    Concrete trucks

    Mid-level construction noise

    Building Site

    Framing Mech Screen Remediation

    Low-level and Mid-level construction noise

    Building Site

    Plaster Remediation

    Low-level and Mid-level construction noise

    Building Site

    Bio Basin Liner - South

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East / West

    Misc. Equipment

    Low-level and Mid-level construction noise

    Building Site

    PV Underground / E-Shut-Off

    Mini Ex

    Low-level and Mid-level construction noise

    Building Site

    Fascia / Coping Cap

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    UCR IT Head-In Install

    Low-level construction noise

    Building

    Interior UCR Punch List

    Low-level construction noise

    Building

    Cx - PFT / Fire Alarm Testing

    Low-level construction noise

    Week of October 19, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – 10.19, 10.21 & 10.23

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Bio Basin Infill

    Low-level and Mid-level construction noise

    Building Site

    Hardscape

    Low-level and Mid-level construction noise

    Building Site

    Fascia/ Coping Cap

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    Interior UCR Punchlist - Corrections

    Low-level construction noise

    Building

    Cx PFT / Fire Alarm Testing

    Scissor Lift

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    UCR South Parking Lot Entrance Closure (Everton) – (10/26 – 11/20)

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (9/28/2026)

    Slide 2 of the Hensel Phelps visual schedule (September 27, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the site footprint with three photos: earthwork and grading alongside modern corrugated siding, concrete curbing installed next to dark exterior walls, and an elevated wide view showing paved roads, crosswalk markings, and perimeter fencing near palm trees.

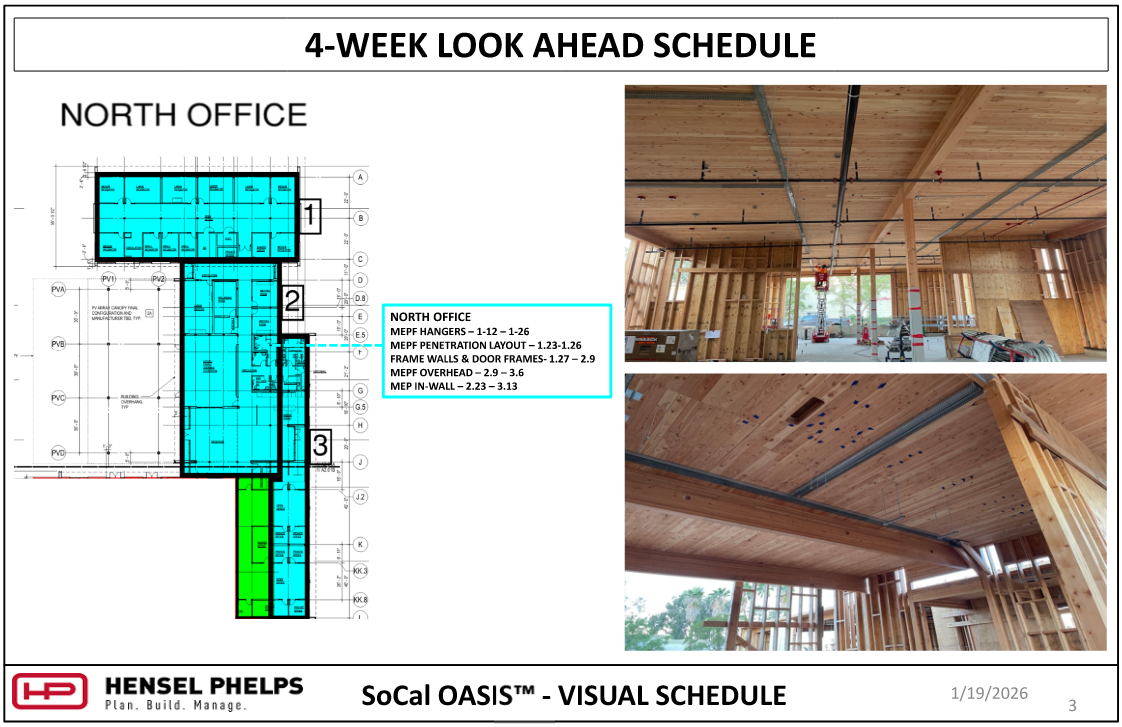

    Slide 3 of the Hensel Phelps visual schedule (September 27, 2026) outlines "North Office" and exterior tasks through mid-November—including architectural punch walks, IT equipment setup, commissioning, site hardscape, and light pole base excavation. The highlighted floor plan is paired with two interior photos: an upper image of a polished corridor with timber posts and suspended linear lighting, and a lower image showing slatted wood ceilings with a large rectangular LED fixture.

    Slide 4 of the Hensel Phelps visual schedule (September 27, 2026) outlines "South Lab" buildout and roof remediation tasks through mid-November—including punch walks, IT equipment setup, commissioning, plastering, and mechanical screen framing. The highlighted floor plan is paired with two photos: an upper image of an open lab room with protected floor coverings and built-in shelving, and a lower image showing a spacious lab area with suspended linear lighting and an yellow A-frame ladder.
    Slide 5 of the Hensel Phelps visual schedule (September 27, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The rendering presents an interior lobby view showing grid-tiled flooring, wood wall paneling, a glass partition on the left, a central reception desk with cabinetry, and white exit doors set into a blue accent wall.

    Current Week – September 28, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Roof Remediation – Roofing & Paint

    Low-level and mid-level construction noise

    Building Site

    Light Pole Excavation

    Back-hoe

    Low-level and mid-level construction noise

    Building Site

    Site Hardscape East / West

    Misc. Equipment

    Low-level and mid-level construction noise

    Building Site

    Bio-Basin Liner South

    Low-level construction noise

    Building Site

    Roofing Parapet Caps

    Scissor Lift

    Low-level construction noise

    Building Site

    Underground Site Electrical

    Mini Ex

    Low-level construction noise

    Building Site

    Exterior Fascia

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior Lights / Devices

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Acoya Wood

    Scissor Lift

    Low-level and mid-level construction noise

    Building

    Architectural Punchlist

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    TAB

    Scissor Lift

    Low-level construction noise

    Week of October 5, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Framing Mech Screen Remediation

    Low-level and Mid-level construction noise

    Building Site

    Plaster Remediation

    Low-level and Mid-level construction noise

    Building Site

    Bio Basin Liner - South

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East / West

    Misc. Equipment

    Low-level and Mid-level construction noise

    Building Site

    PV Underground / E-Shut-Off

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Fascia / Coping Cap

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    IT Head-In Install

    Low-level construction noise

    Building

    Architectural Punch List - Corrections

    Low-level construction noise

    Building

    TAB Report

    Low-level construction noise

    Week of October 12, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Bio Basin Liner

    Low-level and Mid-level construction noise

    Building Site

    Hardscape

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    UCR Punchlist

    Low-level construction noise

    Building

    Cx / Fire Alarm Testing

    Scissor Lift

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    N/A - TBD

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (9/21/2026)

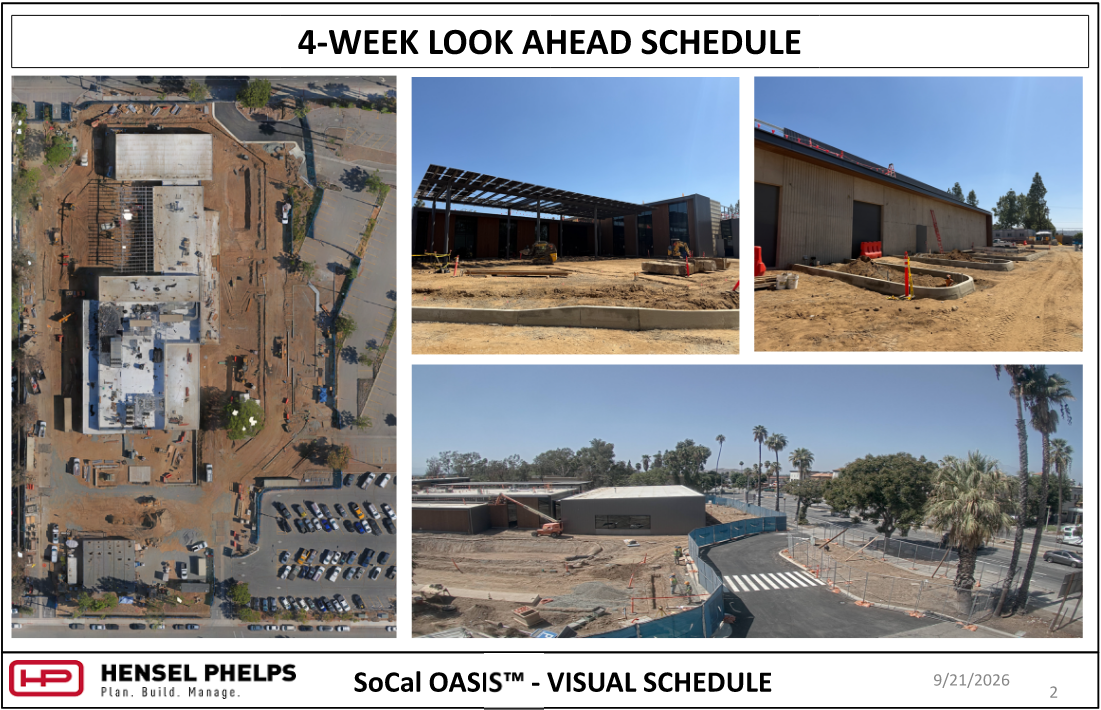

    Slide 2 of the Hensel Phelps visual schedule (September 21, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the site footprint with three photos: the courtyard area beneath an installed rooftop solar canopy, concrete curbing alongside a exterior building wall, and an elevated wide view showing paved roads, crosswalk markings, and ongoing landscaping work near palm trees.

    Slide 3 of the Hensel Phelps visual schedule (September 21, 2026) outlines "North Office" and exterior tasks through mid-October—including IT equipment setup, punch walks, hardscape, and light pole bases. The highlighted plan is paired with two photos: a room with slatted wood ceilings and a whiteboard, and a lobby with wood wall paneling, polished floors, and a scissor lift.

    Slide 4 of the Hensel Phelps visual schedule (September 21, 2026) outlines "South Lab" buildout and roof remediation tasks through late October—including punch walks, IT equipment setup, roof replacement, steel painting, and mechanical screens. The highlighted floor plan is paired with two photos: an upper image showing an expansive lab space with overhead lighting and utility drops, and a lower image showing a large open room with red accent walls, suspended linear lights, and exposed ceiling ductwork.
    Slide 5 of the Hensel Phelps visual schedule (September 21, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The image presents an interior perspective of a wide hallway featuring blue double doors, exposed structural wood support posts, overhead yellow utility trays, and exposed ceiling ductwork

    Current Week – September 21, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Crane for AHU#3

    Crane

    Mid-level construction noise

    Building Site

    Roofing Remediation

    Low-level and mid-level construction noise

    Building Site

    East Light Pole Excavation

    Back-hoe

    Low-level and mid-level construction noise

    Building Site

    Site Hardscape East / West

    Misc. Equipment

    Low-level and mid-level construction noise

    Building Site

    Bio-Basin Liner

    Low-level construction noise

    Building Site

    Roofing Parapet Caps

    Scissor Lift

    Low-level construction noise

    Building Site

    PV Panel Elec Underground for E-Shut-Off

    Mini Ex

    Low-level construction noise

    Building Site

    Exterior Fascia

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior Lights / Devices

    Scissor Lift

    Low-level and mid-level construction noise

    Building

    Work To Complete

    Low-level construction noise

    Low-level construction noise

    Building

    Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    TAB

    Scissor Lift

    Low-level construction noise

    Week of September 28, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Roofing Remediation

    Low-level and Mid-level construction noise

    Building Site

    Framing Mech Screen Remediation

    Low-level and Mid-level construction noise

    Building Site

    Plaster Remediation

    Low-level and Mid-level construction noise

    Building Site

    Bio Basin Liner

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East / West

    Misc. Equipment

    Low-level and Mid-level construction noise

    Building Site

    PV Underground / E-Shut-Off

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    IT Head-In Install

    Low-level construction noise

    Building

    Architectural Punch List

    Low-level construction noise

    Building

    TAB

    Scissor Lift

    Low-level construction noise

    Week of October 5, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Bio Basin Liner

    Low-level and Mid-level construction noise

    Building Site

    Hardscape West

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    Architectural Punch List Corrections

    Low-level construction noise

    Building

    Cx / Fire Alarm

    Scissor Lift

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    N/A - TBD

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (9/14/2026)

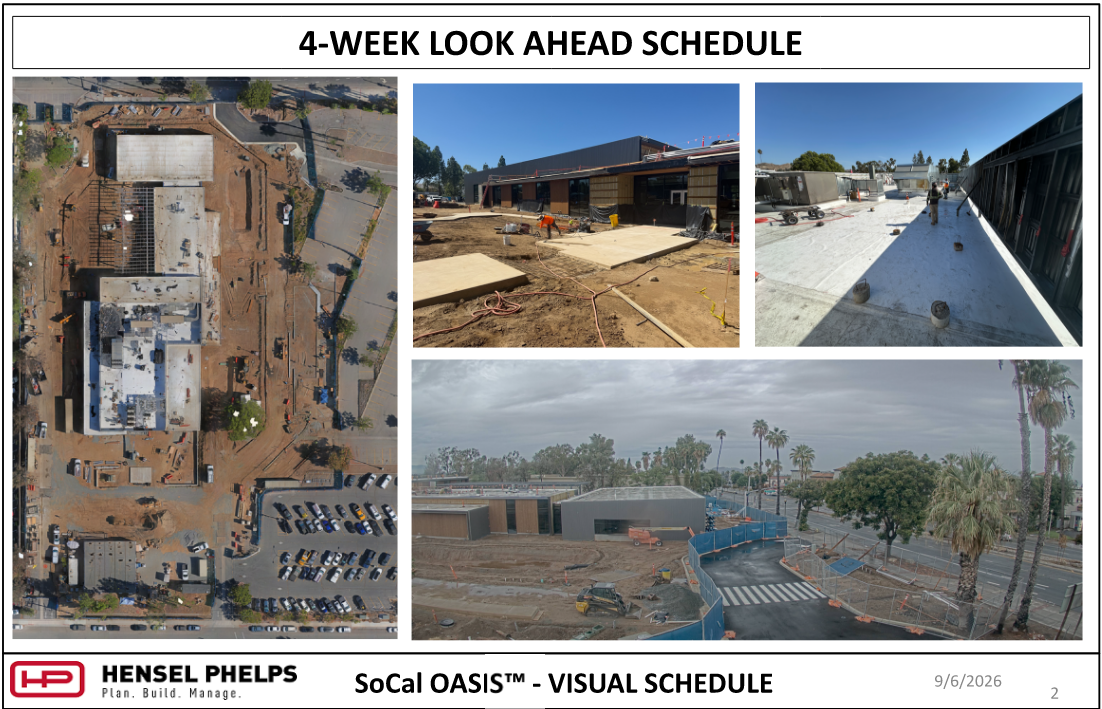

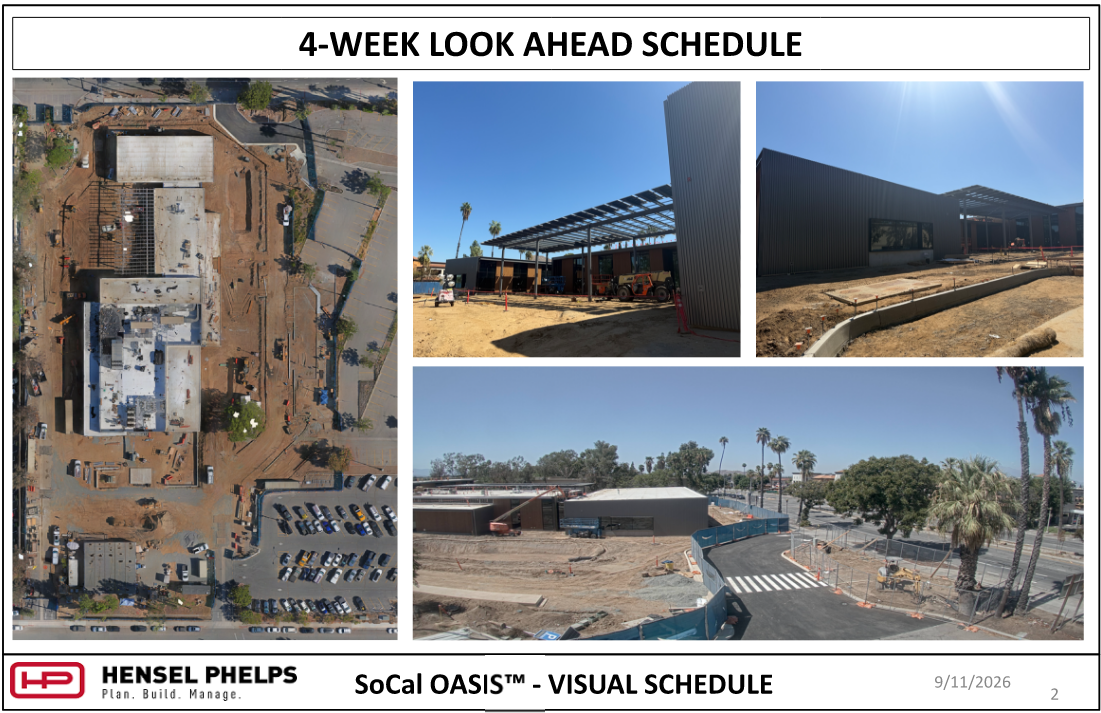

    Slide 2 of the Hensel Phelps visual schedule (September 11, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the site with three photos: an outdoor courtyard area beneath a solar canopy frame, concrete curbing installed alongside dark exterior siding, and an elevated wide shot showing paved roadways, crosswalks, and surrounding palm trees.

    Slide 3 of the Hensel Phelps visual schedule (September 11, 2026) outlines "North Office" and exterior tasks through late September—including fabric wall panels, TAB, site hardscape, and PV panels. The highlighted floor plan is paired with two photos: an upper image showing slatted wood ceiling panels and built-in cabinetry, and a lower image showing a room with white and gray acoustic wall panels and suspended linear light fixtures.

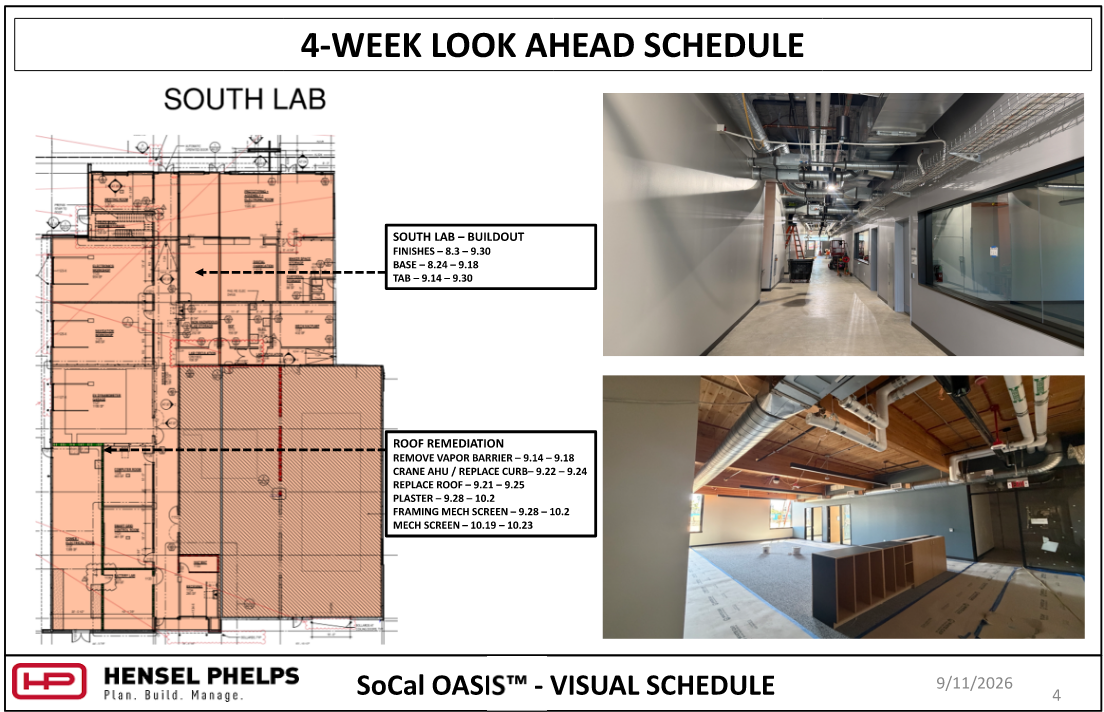

    Slide 4 of the Hensel Phelps visual schedule (September 11, 2026) outlines "South Lab" buildout and roof remediation tasks through late October—including base installation, TAB, vapor barrier removal, roof replacement, and mechanical screens. The highlighted floor plan is paired with two photos: an upper image of a clean interior corridor with overhead piping and conduit, and a lower image showing an open room with timber ceiling beams, exposed spiral ductwork, and built-in shelving units.

    Slide 5 of the Hensel Phelps visual schedule (September 11, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The image presents an elevated view of the central courtyard, showcasing green support columns with an overhead canopy frame set against modern, flat-roofed structures featuring dark paneling and glass curtain walls.

    Current Week – September 14, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – East / West / South Curb/Gutter – 9.15 & 9.17

    Concrete trucks

    Mid-level construction noise

    Building Site

    South Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building Site

    Site Hardscape East / West

    Misc. Equipment

    Low-level and mid-level construction noise

    Building Site

    Bio-Basin Liner

    Low-level construction noise

    Building Site

    Roofing Parapet Caps

    Scissor Lift

    Low-level construction noise

    Building Site

    PV Panels

    Scissor Lift

    Low-level construction noise

    Building Site

    Exterior Fascia

    Scissor Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior Lights / Devices

    Scissor Lift

    Low-level and mid-level construction noise

    Building

    Fabric Wall Panels

    Low-level construction noise

    Low-level construction noise

    Building

    Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    TAB

    Scissor Lift

    Low-level construction noise

    Week of September 21, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Bio Basin Liner

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East / West

    Misc. Equipment

    Low-level and Mid-level construction noise

    Building Site

    PV Underground / E-Shut-Off

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    Acoya Wood

    Low-level construction noise

    Building

    Fabric Wall Panels

    Low-level construction noise

    Building

    Interior Finishes – North & South – Trim & Specialties

    Low-level construction noise

    Building

    TAB

    Scissor Lift

    Low-level construction noise

    Week of September 28, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Bio Basin Liner

    Low-level and Mid-level construction noise

    Building Site

    PV Electrical

    Low-level and Mid-level construction noise

    Building Site

    Hardscape West

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    Interior Misc. Finishes – North & South

    Low-level construction noise

    Building

    TAB

    Scissor Lift

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    N/A - TBD

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

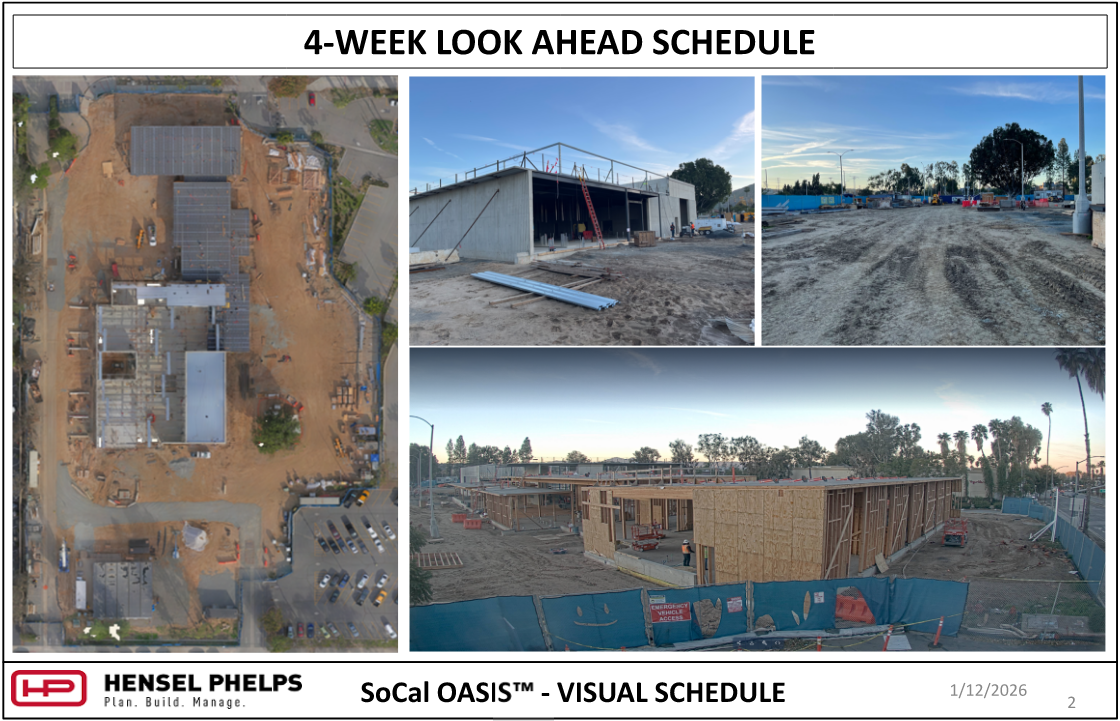

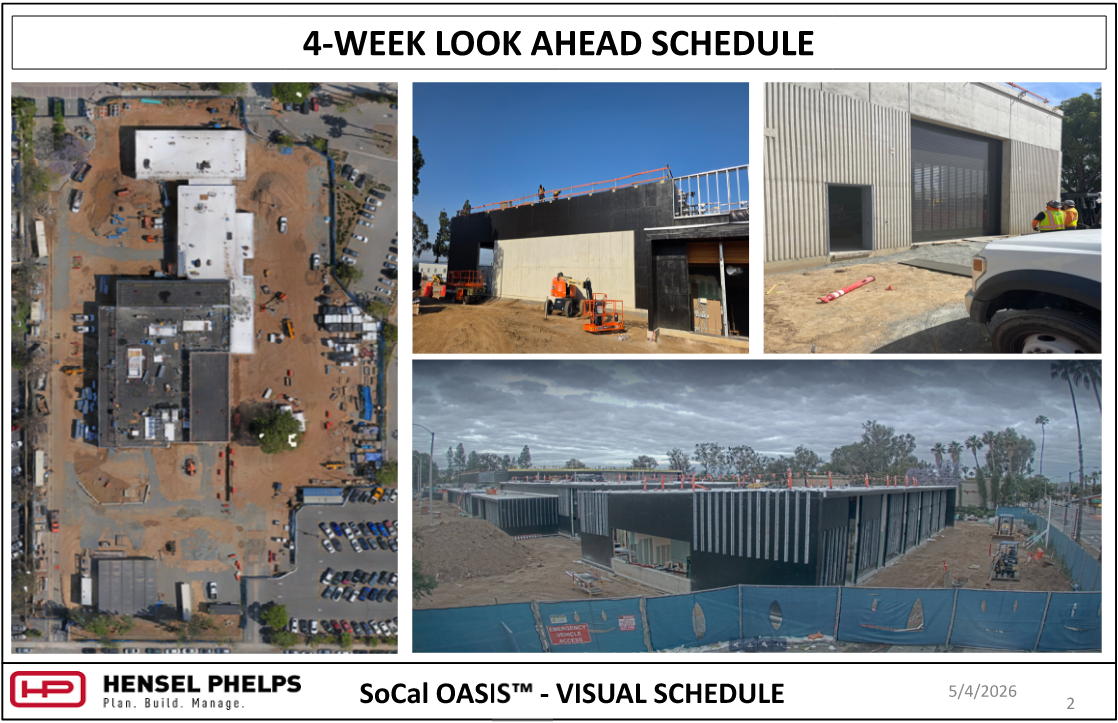

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (9/7/2026)

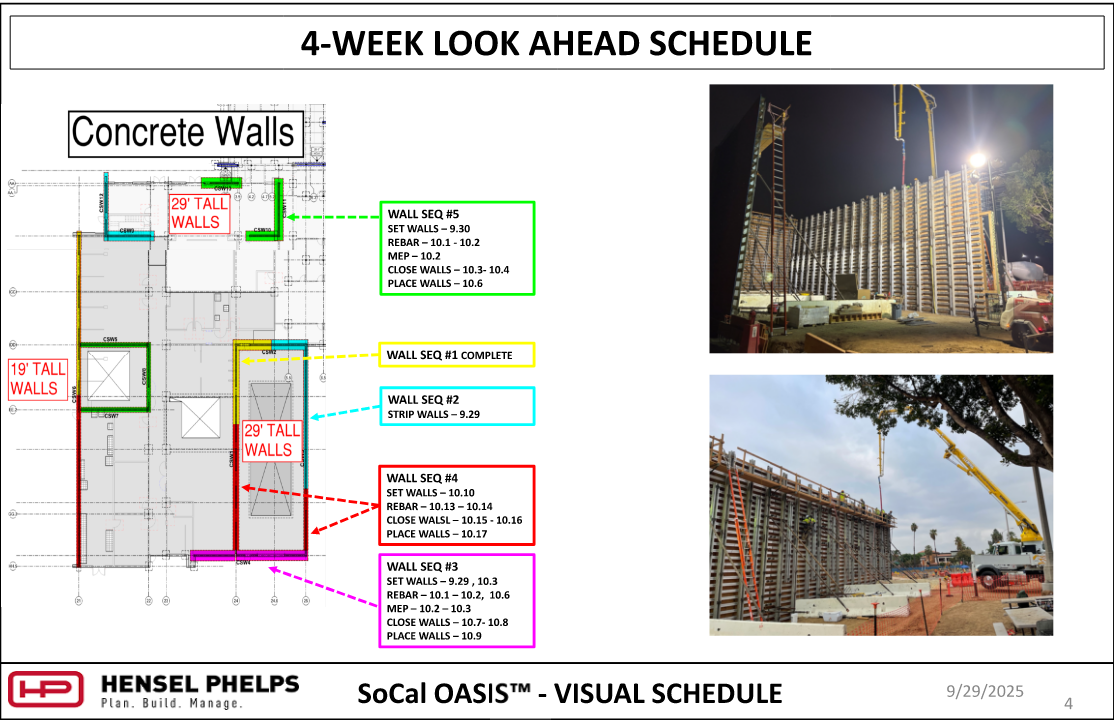

    Slide 2 of the Hensel Phelps visual schedule (September 6, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the site with three photos: concrete flatwork forms laid out on dirt grounds, a clean roof deck alongside screen framing, and a wide elevated view of paved site access roads and perimeter fencing near palm trees.

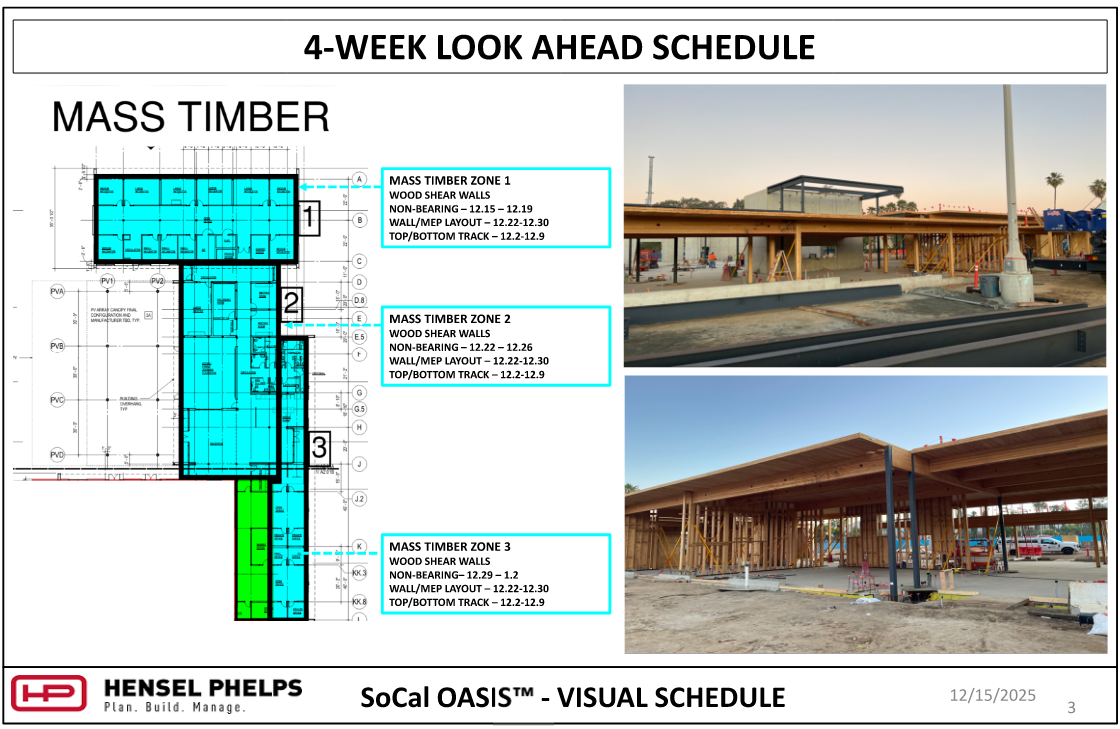

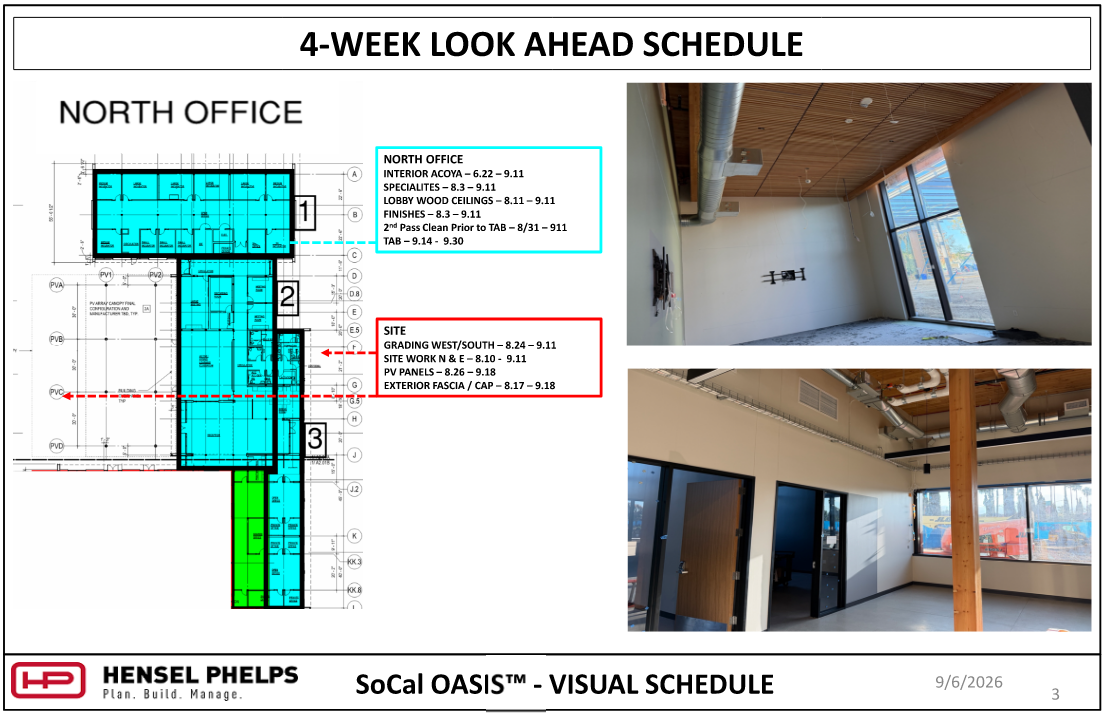

    Slide 3 of the Hensel Phelps visual schedule (September 6, 2026) outlines "North Office" and "Site" tasks through late September—including lobby wood ceilings, testing/adjusting/balancing (TAB), site work, PV panels, and exterior fascia. The highlighted floor plan is paired with two interior photos: an upper image showing slat wood ceiling paneling and large windows, and a lower image showing completed interior doorways, exposed timber posts, and ceiling ductwork.

    Slide 4 of the Hensel Phelps visual schedule (September 6, 2026) outlines "South Lab" tasks through late September—including interior finishes, base installation, cleaning, and testing/adjusting/balancing (TAB). The highlighted floor plan is paired with two photos: an upper image showing a spacious lab area with white wall-mounted cabinets and suspended linear lights, and a lower image showing electrical equipment and conduit mounted against a concrete wall.
    Slide 5 of the Hensel Phelps visual schedule (September 6, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The image presents an elevated perspective of the facility complex, featuring flat roofs, dark side paneling with vertical windows, an open courtyard with shade structure framing under a clear blue sky.

    Current Week – September 7, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – East / West Curb/Gutter – 9.11

    Concrete trucks

    Mid-level construction noise

    Building Site

    West / South Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building Site

    Site Hardscape East / West

    Low-level and mid-level construction noise

    Building Site

    Roofing Parapet Caps

    Low-level construction noise

    Building Site

    PV Panels

    Scissor Lift

    Low-level construction noise

    Building Site

    Exterior Fascia

    Scissor Lift

    Low-level and mid-level construction noise

    Building

    Fabric Wall Panels

    Low-level construction noise

    Low-level construction noise

    Building

    Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Wood Ceilings

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Trim - All

    Low-level construction noise

    Building

    Energize Lights

    Low-level construction noise

    Building

    2nd Pass Clean Prior to TAB

    Scissor Lift

    Low-level construction noise

    Week of September 14, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Bio Basin Liner

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East

    Low-level and Mid-level construction noise

    Building Site

    PV Panels

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    Acoya Wood

    Low-level construction noise

    Building

    Fabric Wall Panels

    Low-level construction noise

    Building

    Interior Finishes – North & South – Trim & Specialties

    Low-level construction noise

    Building

    TAB

    Scissor Lift

    Low-level construction noise

    Week of September 21, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Bio Basin Liner

    Low-level and Mid-level construction noise

    Building Site

    PV Electrical

    Low-level and Mid-level construction noise

    Building Site

    Hardscape West

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    Interior Misc. Finishes – North & South

    Low-level construction noise

    Building

    TAB

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    N/A - TBD

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (8/31/2026)

    Construction status slide titled "4-Week Look Ahead Schedule" for SoCal OASIS by Hensel Phelps, featuring an aerial top-down view of the site and three ground-level progress photos showing concrete walls, earthwork excavation, and freshly paved asphalt.
    4-Week Look Ahead Schedule" slide for North Office at SoCal OASIS by Hensel Phelps, displaying a floor plan layout with schedule callout boxes alongside interior progress photos showing millwork, wood ceilings, and dark accent walls.

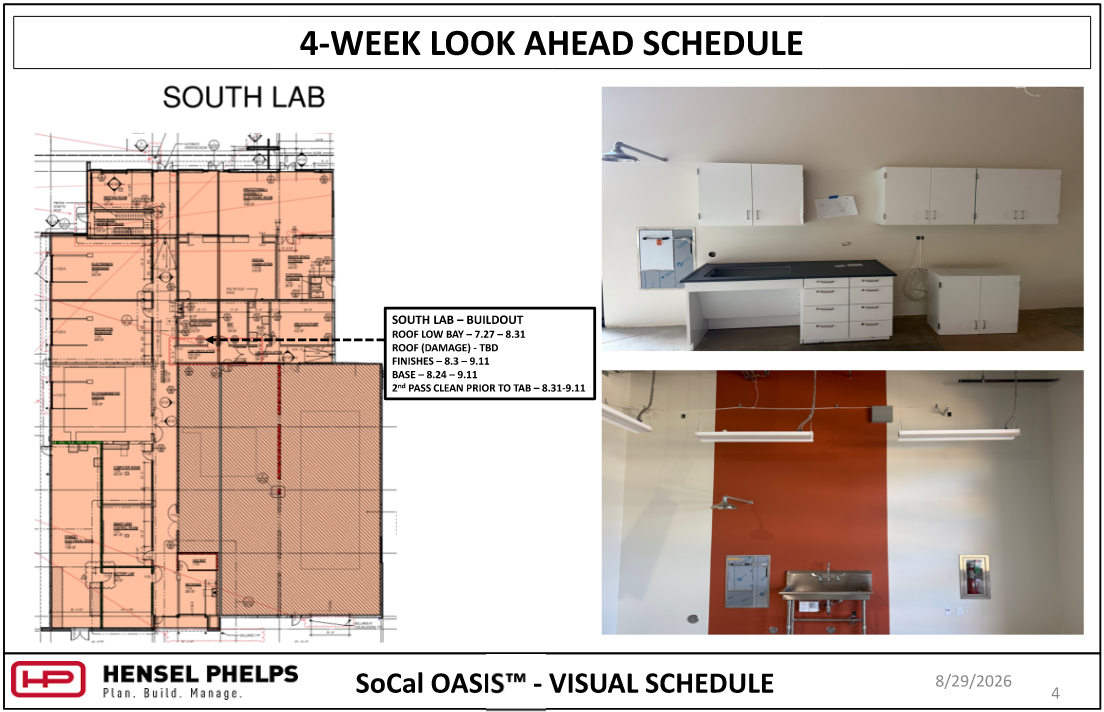

    "4-Week Look Ahead Schedule" slide for South Lab at SoCal OASIS by Hensel Phelps, featuring an architectural floor plan with schedule milestones alongside lab interior progress photos showing installed white cabinetry, countertops, and utility fixtures against a orange accent wall.
    "4-Week Look Ahead Schedule" slide for SoCal OASIS by Hensel Phelps, featuring a 3D architectural rendering of the facility, showing modern dark exterior cladding, flat roofs with mechanical equipment, and surrounding landscaped grounds.

    Current Week – August 31, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – East Curb/Gutter – 9.1 & 9.3

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and mid-level construction noise

    Building Site

    West Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building Site

    Prep Parking Entrance for Opening

    Low-level construction noise

    Building Site

    Site Hardscape East

    Low-level and mid-level construction noise

    Building Site

    Paint PV Trim

    Scissor Lift

    Low-level construction noise

    Building Site

    PV Panels

    Scissor Lift

    Low-level construction noise

    Building Site

    Exterior Fascia

    Scissor Lift

    Low-level and mid-level construction noise

    Building

    Building Specialties

    Low-level construction noise

    Building

    Fabric Wall Panels

    Low-level construction noise

    Low-level construction noise

    Building

    Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Trim - All

    Low-level construction noise

    Building

    Energize Lights

    Low-level construction noise

    Building

    2nd Pass Clean Prior to TAB

    Scissor Lift

    Low-level construction noise

    Week of September 7, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Parking Lot Entrance - OPEN

    Building Site

    West / South Grading

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building Site

    Hardscape East

    Low-level and Mid-level construction noise

    Building Site

    PV Panels

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lifts

    Low-level construction noise

    Building

    Acoya Wood

    Low-level construction noise

    Building

    Fabric Wall Panels

    Low-level construction noise

    Building

    Interior Finishes – North & South – Trim & Specialties

    Low-level construction noise

    Building

    2nd Pass Clean Prior to TAB

    Scissor Lift

    Low-level construction noise

    Week of September 14, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Bio Basin Liner

    Low-level and Mid-level construction noise

    Building Site

    PV Electrical

    Low-level and Mid-level construction noise

    Building Site

    Hardscape West

    Low-level and Mid-level construction noise

    Building Site

    Fascia

    Scissor Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior Lights / Trim

    Scissor Lift

    Low-level and Mid-level construction noise

    Building

    Interior Misc. Finishes – North & South

    Low-level construction noise

    Building

    TAB

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 9/4

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (8/24/2026)

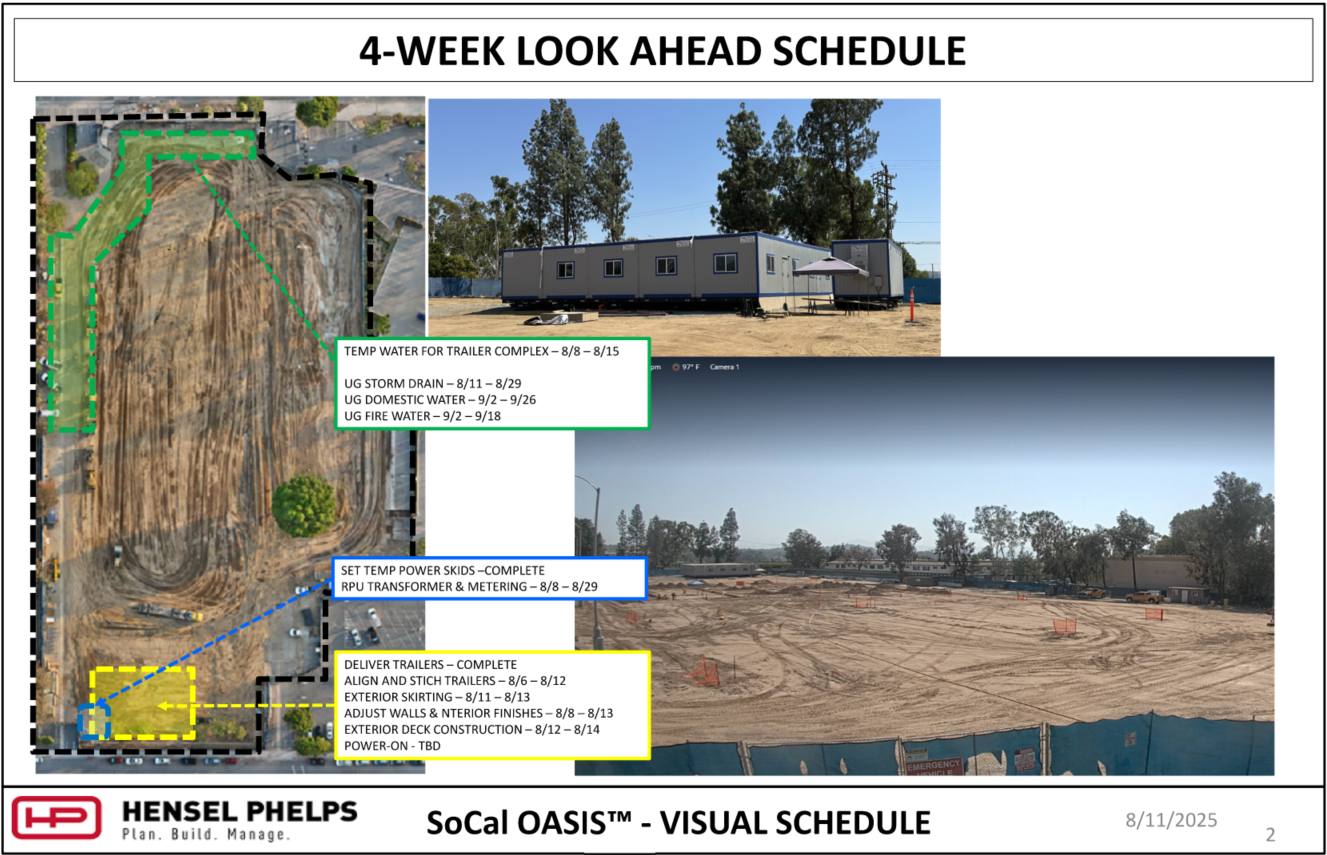

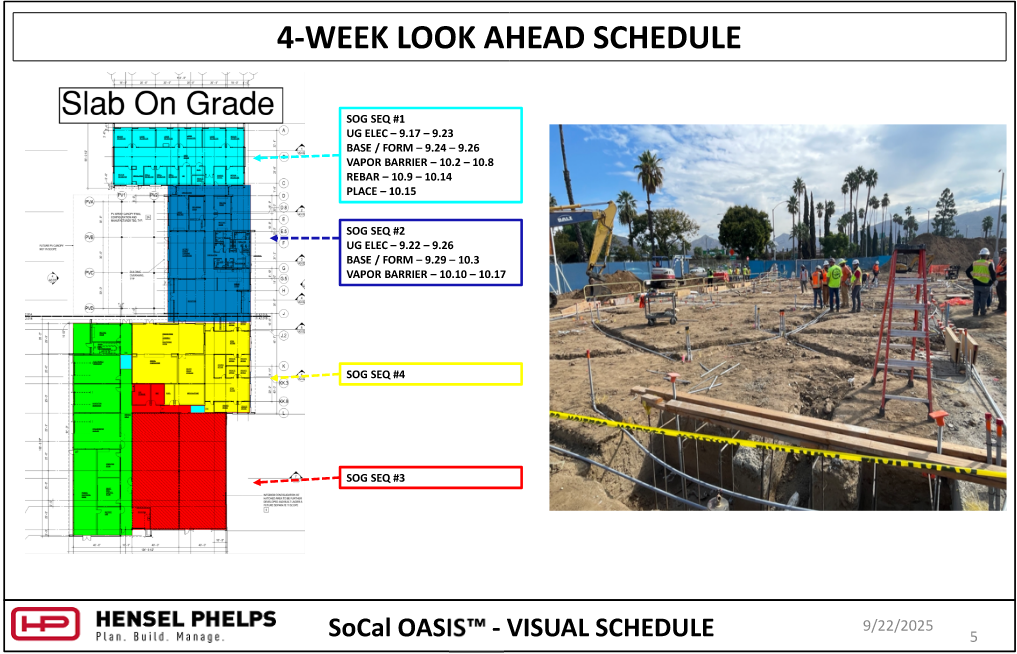

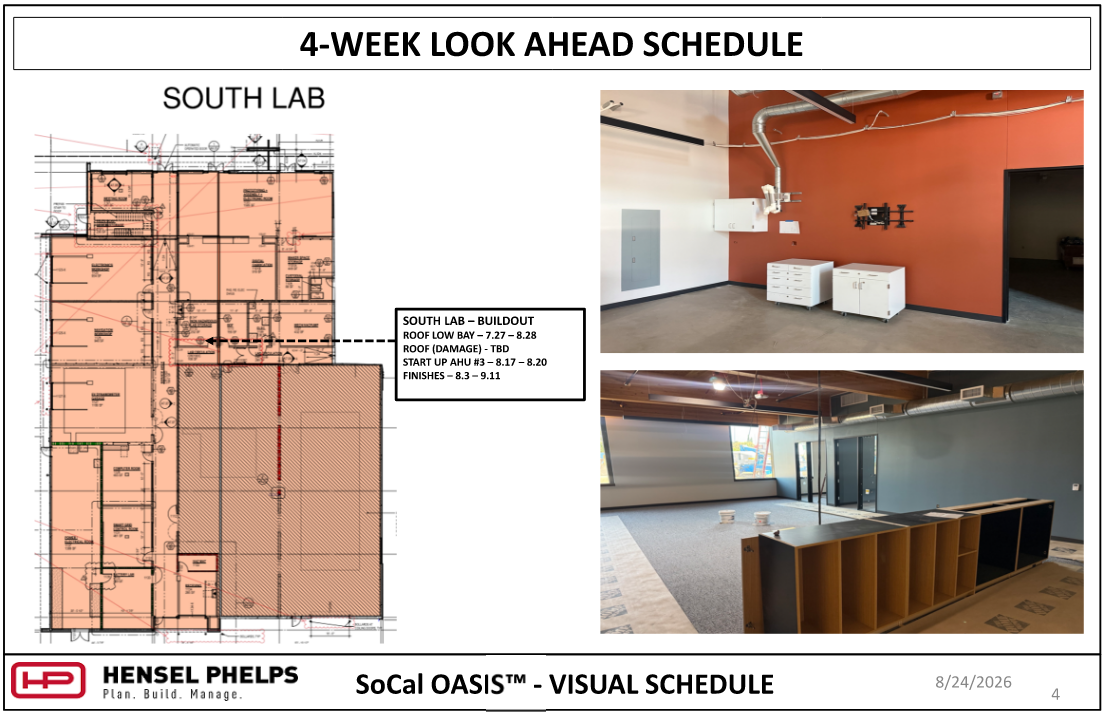

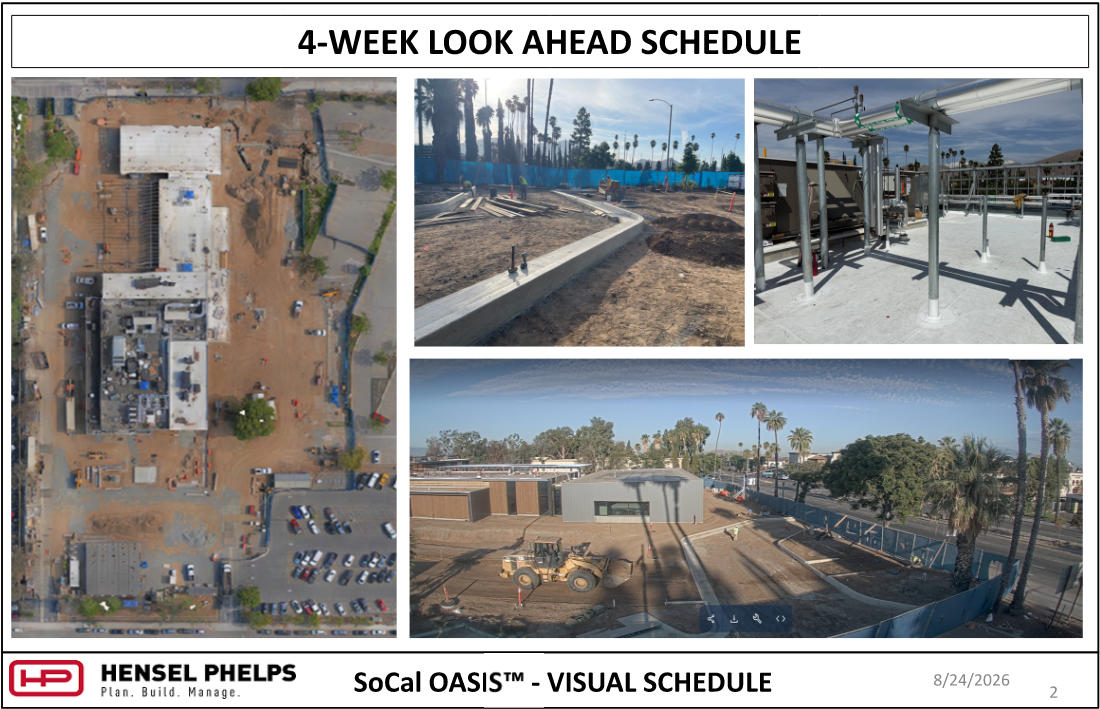

    Slide 2 of the Hensel Phelps visual schedule (August 24, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the site with three progress photos: newly poured concrete curbing along a dirt pathway, rooftop pipe support framing with insulated overhead lines, and a wide elevated view of site grading featuring heavy machinery and palm trees along the perimeter fence.

    Slide 3 of the Hensel Phelps visual schedule (August 24, 2026) outlines "North Office" and "North Site" tasks through mid-September—including interior glazing, lobby ceilings, site work, PV panels, and exterior fascia. The highlighted floor plan is paired with two photos: an upper room showing exposed wooden ceiling beams and suspended linear lighting, and a lower image showing a large open lobby with floor-to-ceiling windows and protective floor covering.

    Slide 4 of the Hensel Phelps visual schedule (August 24, 2026) outlines "South Lab" tasks through mid-September—including roof low bay work, roof repair, AHU #3 startup, and interior finishes. The highlighted floor plan is paired with two photos: an upper image of a room featuring a terracotta-red wall section with mounted cabinetry and exposed ductwork, and a lower image showing an open room with carpet tile, black and wood shelving units, and slate blue accent walls.
    Slide 5 of the Hensel Phelps visual schedule (August 24, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The image presents an elevated view of an open courtyard area, highlighting tall green steel support columns framing an outdoor shade canopy in front of modern, dark-clad facility structures with floor-to-ceiling glass windows.

    Current Week – August 24, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – Service Yard Retaining Wall – 8.25

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and mid-level construction noise

    Building Site

    East Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building Site

    North Base & Paving

    Heavy Equipment

    Low-level and mid-level construction noise

    Building

    Site Hardscape East

    Building

    Building Specialties

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Doors

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building Site

    PV Panels

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Exterior – Metal Panels & Fascia

    Boom Lift

    Low-level and mid-level construction noise

    Week of August 31, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building Site

    PV Panels

    Boom Lift

    Low-level construction noise

    Building Site

    Grading East

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Finishes

    Low-level construction noise

    Building

    Interior Finishes – North & South – Trim & Specialties

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Service Yard Retaining Walls Strip

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    OPEN Parking Entrance 9.4

    Low-level and Mid-level construction noise

    Building Site

    Site Concrete – North / East

    Backhoe

    Low-level and Mid-level construction noise

    Week of September 7, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Grading West

    Skip Loader

    Low-level and Mid-level construction noise

    Building Site

    Site Hardscapes - West

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lift

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Interior Finishes – Trim, Specialties

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lifts

    Low-level and Mid-level construction noise

    Building

    PREP for TAB

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 9/4

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  •

    Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (8/17/2026)

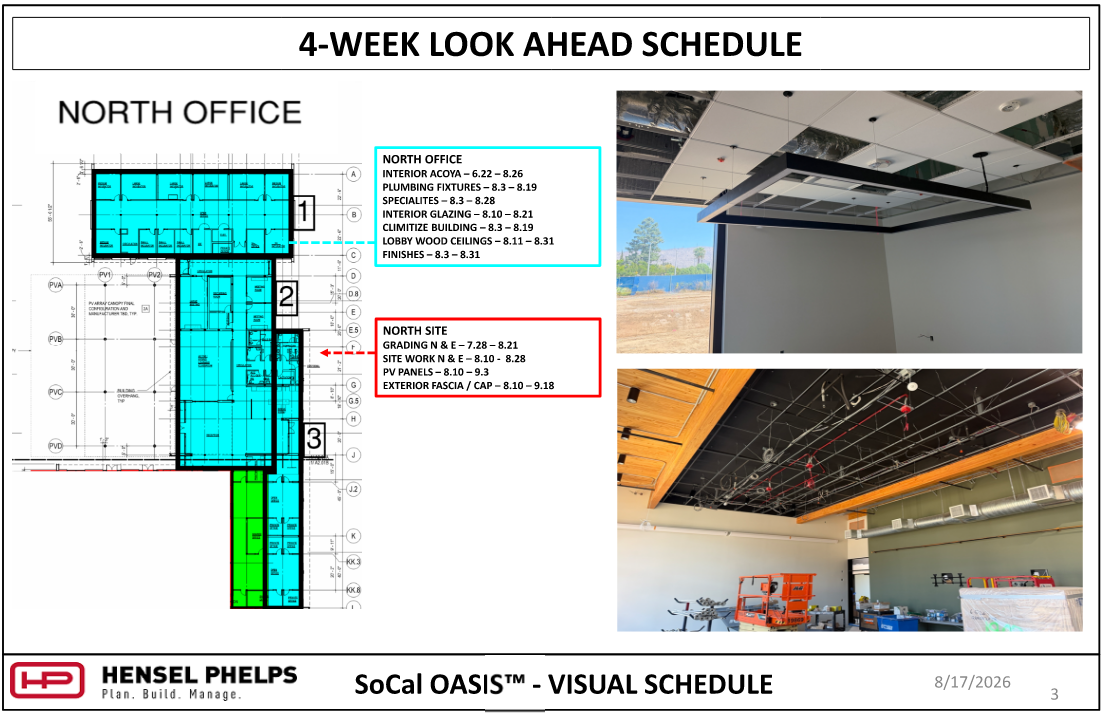

    Slide 2 of the Hensel Phelps visual schedule (August 17, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the project footprint with three progress photos: rooftop HVAC unit installation with overhead piping, a close-up of finished exterior wall plaster, and a wide elevated view of ongoing site excavation, grading, and concrete formwork bordered by palm trees.

    Slide 3 of the Hensel Phelps visual schedule (August 17, 2026) outlines "North Office" and "North Site" tasks through mid-September including finishes, lobby ceilings, site work, and PV panels. The highlighted floor plan is paired with two photos: an office with a suspended rectangular light fixture, and an open lobby showing exposed ceiling gridwork, wood accents, and construction equipment.

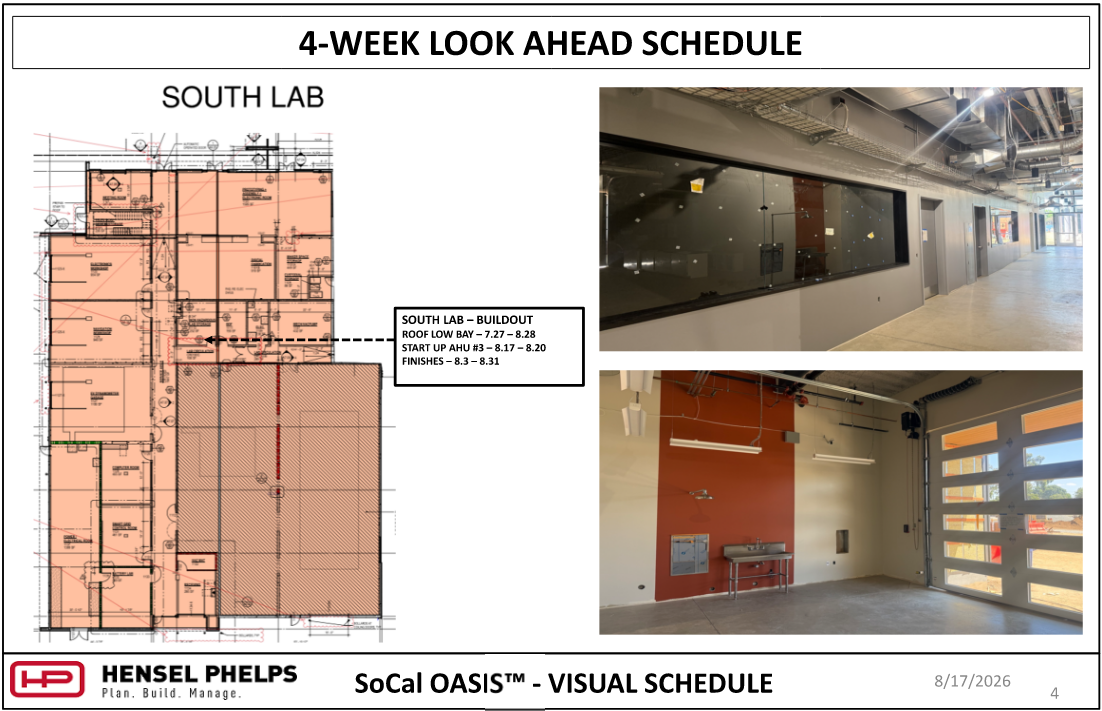

    Slide 4 of the Hensel Phelps visual schedule (August 17, 2026) outlines upcoming "South Lab" tasks through late August including roof low bay work, AHU #3 startup, and interior finishes. The highlighted floor plan is paired with two photos: an upper image showing a long hallway with glass observation windows and overhead tray wiring, and a lower image showing a bay area with a terracotta-red wall section, stainless steel utility sink, and large glass sectional door.

    Slide 5 of the Hensel Phelps visual schedule (August 17, 2026) displays an elevated 3D architectural rendering for the SoCal OASIS™ project. The image highlights rooftop mechanical and HVAC equipment layouts featuring color-coded chillers, air handlers, and piping set atop modern facility structures with parking visible in the background.

    Current Week – August 17, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – North Curb & Gutter 8/19

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and mid-level construction noise

    Building Site

    North / East Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building

    Site Hardscape

    Building

    Building Fixtures

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Doors

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Grid Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Roof Start Up – Chiller

    Acclimation

    Low-level construction noise

    Building

    AHU #3 Start Up – 8.17

    Low-level construction noise

    Building Site

    Exterior – Metal Panels & Fascia

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Manholes

    Low-level and Mid-level construction noise

    Week of August 24, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building Site

    PV Panels

    Boom Lift

    Low-level construction noise

    Building Site

    Grading North / West

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Finishes

    Low-level construction noise

    Building

    Interior Finishes – North & South – Trim & Specialties

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building

    Roof Start Up – Acclimation

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    North Base & Paving

    Skip Loader / Paving Machine

    Low-level and Mid-level construction noise

    Building Site

    Site Concrete – North / East

    Backhoe

    Low-level and Mid-level construction noise

    Week of August 31, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Grading West

    Skip Loader

    Low-level and Mid-level construction noise

    Building Site

    Site Hardscapes - East

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lift

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Interior Finishes – Trim, Specialties

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    North Parking Lot Entrance – Prep for Opening

    Low-level construction noise

    Building Site

    Service Yard – Retaining Wall

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 9/4

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (8/10/2026)

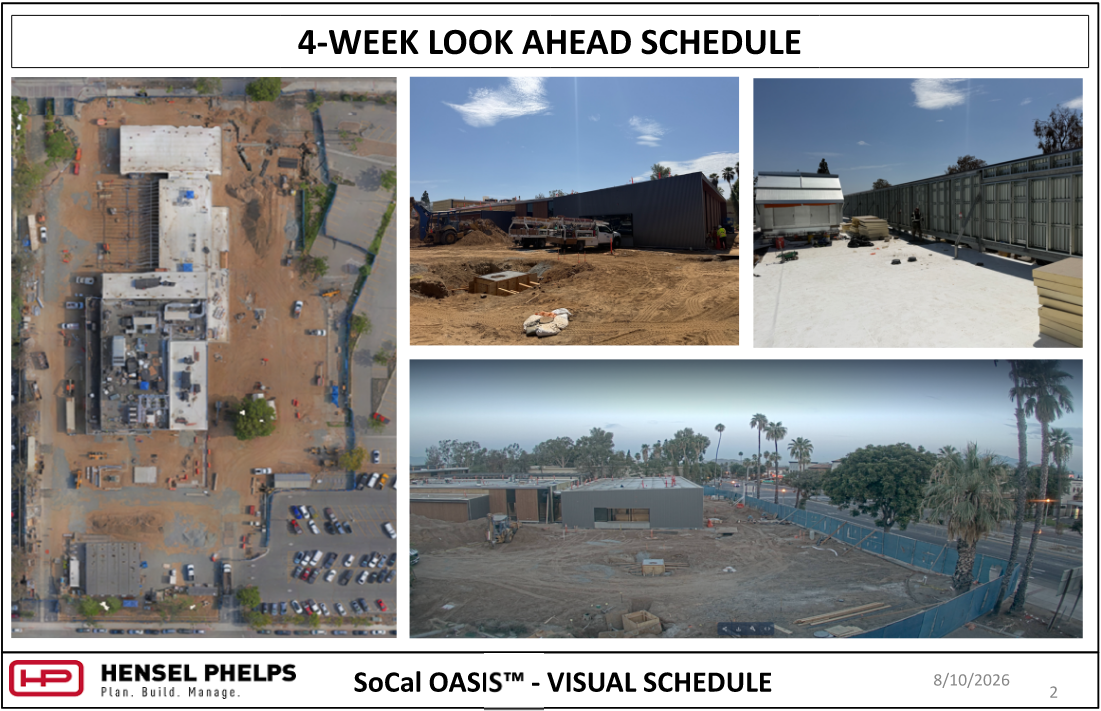

    Slide 2 of the Hensel Phelps visual schedule (August 10, 2026) highlights SoCal OASIS™ site progress. It pairs an overhead aerial view of the layout with three photos: ground-level utility vault work, rooftop screen framing with roof deck materials, and a wide elevated view of ongoing excavation and site grading bordered by palm trees.
    Slide 3 of the Hensel Phelps visual schedule (August 10, 2026) outlines tasks for the "North Office" and "North Site" zones of the SoCal OASIS™ project through late August—covering interior glazing, finishes, storm drain manholes, grading, and PV panel installation. The highlighted floor plan is paired with two photos: an upper image showing decorative wall tile in a room with stored boxes, and a lower image displaying installed drop ceiling tiles and a linear pendant light fixture.
    Slide 4 of the Hensel Phelps visual schedule (August 10, 2026) outlines upcoming tasks for the "South Lab" section of the SoCal OASIS™ project through late August—including roof low bay work, chiller startup, and general finishes. The highlighted floor plan is paired with two photos: an upper image of an interior hallway showing exposed ceiling ductwork and glass viewing windows, and a lower image showing insulated utility pipes running along an exterior wall under a blue sky.

    Slide 5 of the Hensel Phelps visual schedule (August 10, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The image presents a ground-level perspective view of the facility layout, featuring dark-paneled exterior walls with vertical windows, flat rooftops, rooftop solar canopy framing, and surrounding site grounds under a clear blue sky.

    Current Week – August 10, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – N/A

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and mid-level construction noise

    Building Site

    North / East Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building

    Restroom Fixtures

    Low-level construction noise

    Building

    Interior Door Frames

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Grid Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Roof Start Up – Chiller

    Acclimation

    Low-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Manholes

    Backhoe

    Low-level and Mid-level construction noise

    Week of August 17, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building Site

    PV Panels

    Boom Lift

    Low-level construction noise

    Building Site

    Grading North / East

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Finishes

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building

    Roof Start Up – Acclimation

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Concrete – North / East

    Backhoe

    Low-level and Mid-level construction noise

    Week of August 24, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Site Hardscapes

    Backhoe

    Low-level and Mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    PV Panels

    Boom Lift

    Low-level and Mid-level construction noise

    Building

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lift

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Interior Finishes - Trim

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    North / East Hardscape

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 9/4

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (8/3/2026)

    Slide 2 of the Hensel Phelps visual schedule (August 3, 2026) highlights overall construction site progress for the SoCal OASIS™ project. It features an overhead aerial view of the building layout alongside three updated site photos: a high-angle view looking down the length of the complex, a close-up of insulated exterior utility piping mounted along a concrete wall, and a wide elevated view of ongoing site work, excavation, and green utility pipes bordered by palm trees along the perimeter.

    Slide 3 of the Hensel Phelps visual schedule (August 3, 2026) updates upcoming tasks for the "North Office" of the SoCal OASIS™ project. It pairs a color-coded floor plan and schedule callouts covering plumbing fixtures, interior glazing, lobby wood ceilings, storm drain manholes, PV panels, and site work through late August. With two interior photos: an upper image showing progress on a tiled wall and floor, and lower image showing a lobby area with wood wall paneling, exposed timber beams, and windows.

    Slide 4 of the Hensel Phelps visual schedule (August 3, 2026) updates upcoming tasks for the "South Lab" section of the SoCal OASIS™ project. It features a highlighted floor plan schedule for roof plaster, roof low bay work, and interior finishes through late August. The plan is paired with two photos: an upper image showing concrete walls, window cutout, and mechanical piping, and an image showing a large room featuring a terracotta-red accent wall, lighting, overhead ductwork, and doorway passages.

    Slide 5 of the Hensel Phelps visual schedule (August 3, 2026) displays an elevated 3D architectural rendering for the SoCal OASIS™ project. The rendering highlights rooftop utility infrastructure, showing color-coded mechanical and HVAC equipment (including pink and blue components) integrated into the roof deck atop modern, dark-clad facility structures.

    Current Week – August 3, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – N/A

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and mid-level construction noise

    Building Site

    North / East Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building

    Restroom Fixtures

    Low-level construction noise

    Building

    Interior Door Frames

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Grid Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Roof Start Up – Chiller

    Acclimation

    Low-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roof Plaster

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Re-route & Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of August 10, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building Site

    PV Panels

    Boom Lift

    Low-level construction noise

    Building Site

    Grading North / East

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Finishes

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building

    Roof Start Up – Acclimation

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Concrete – North / East

    Backhoe

    Low-level and Mid-level construction noise

    Week of August 17, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Site Hardscapes

    Backhoe

    Low-level and Mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    PV Panels

    Boom Lift

    Low-level and Mid-level construction noise

    Building

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building

    Lobby Wood Ceilings

    Scissor Lift

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Interior Finishes - Trim

    Low-level construction noise

    Building

    Casework

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    North / East Hardscape

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 9/4

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (7/27/2026)

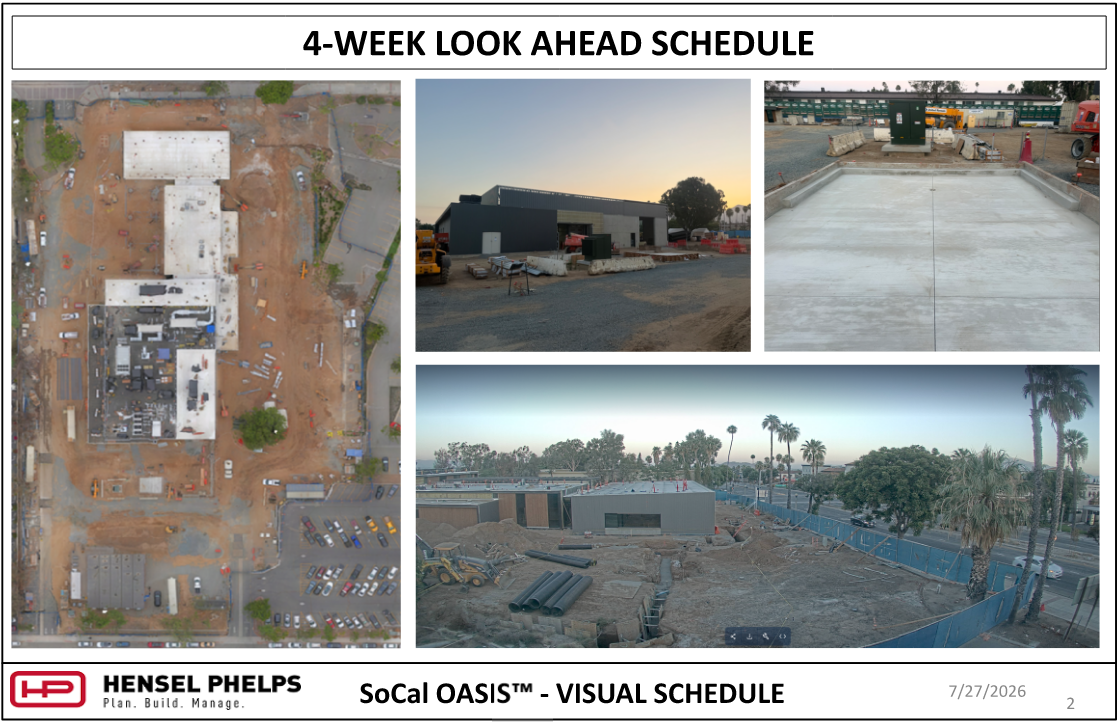

    Slide 2 of the Hensel Phelps visual schedule (July 27, 2026) highlights overall construction site progress for the SoCal OASIS™ project. It features an overhead aerial view of the building footprint alongside three updated progress photos: a low-angle exterior view of the modern building facade at dusk, a newly poured concrete pad with electrical transformers nearby, and a wide elevated view showing ongoing site work, earthwork, stored piping, and perimeter fencing bordered by palm trees.

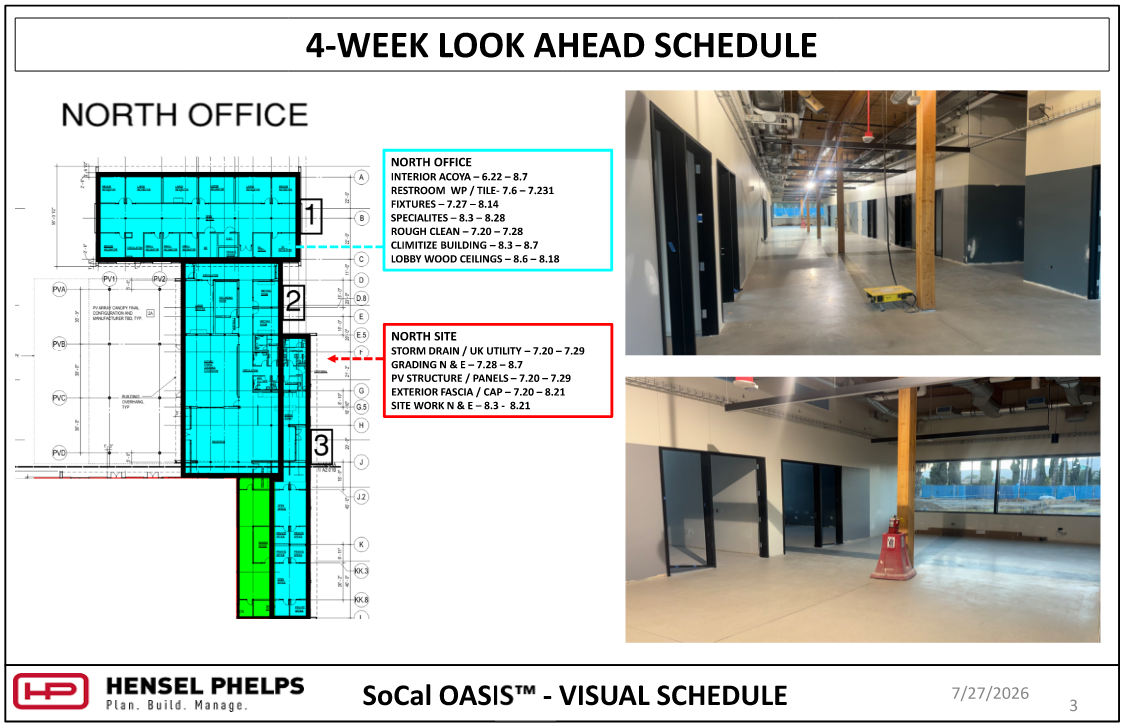

    Slide 3 of the Hensel Phelps visual schedule (July 27, 2026) updates upcoming tasks for the "North Office" and "North Site" zones of the SoCal OASIS™ project. It pairs a color-coded floor plan and schedule callouts—covering interior finishes, fixtures, lobby wood ceilings, grading, storm drains, and site work through late August—with two interior photos showing wide corridor spaces with exposed ceiling infrastructure, timber support columns, and framed doorway openings.

    Slide 4 of the Hensel Phelps visual schedule (July 27, 2026) updates upcoming tasks for the "South Lab" section of the SoCal OASIS™ project. It features a highlighted floor plan with a schedule for roof plaster, roof low bay construction, and equipment startups through early August. The plan has two photos: an upper image showing a board-formed concrete exterior wall with base flashing, and a lower image showing an interior bay space with concrete walls, suspended lighting, and a open roll-up doorway.

    Slide 5 of the Hensel Phelps visual schedule (July 27, 2026) displays an elevated 3D architectural rendering for the SoCal OASIS™ project. The rendering shows an aerial perspective of the facility layout, featuring flat rooftops, dark exterior wall cladding with tall vertical glass windows, and adjacent neighboring buildings set against a blue sky.

    Current Week – July 27, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – N/A

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and mid-level construction noise

    Building Site

    North / East Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building

    Restroom Tile

    Low-level construction noise

    Building

    Interior Door Frames

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Grid Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Initial Cleaning

    Scissor Lifts

    Low-level construction noise

    Building

    Roof Start Up – AHU’s

    Low-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roof Plaster

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Re-route & Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of August 3, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building Site

    PV Panels

    Boom Lift

    Low-level construction noise

    Building Site

    Grading North / East

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building

    Restroom Finishes

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Interior Glazing

    Low-level construction noise

    Building

    Roof Plaster

    Low-level construction noise

    Building

    Roof Start Up - Chillers

    Low-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of August 10, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Low Bay PVC Roofing

    Low-level and Mid-level construction noise

    Building

    Restroom Finishes

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Interior Finishes - Trim

    Low-level construction noise

    Building

    Interior Wood Acclimation

    Low-level construction noise

    Building Site

    PV Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – Fascia

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    North / East Hardscape

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (7/20/2026)

    Presentation slide titled "4-WEEK LOOK AHEAD SCHEDULE" from Hensel Phelps for "SoCal OASIS™ - VISUAL SCHEDULE" dated 7/20/2026. The slide displays four construction progress photographs: an aerial overhead view of the building footprint and surrounding dirt site, a close-up of dark structural steel framing with a scissor lift underneath, a street-level view of a modern wood-paneled and glass building facade, and a wide elevated view of the construction site bordered by palm trees and a road.

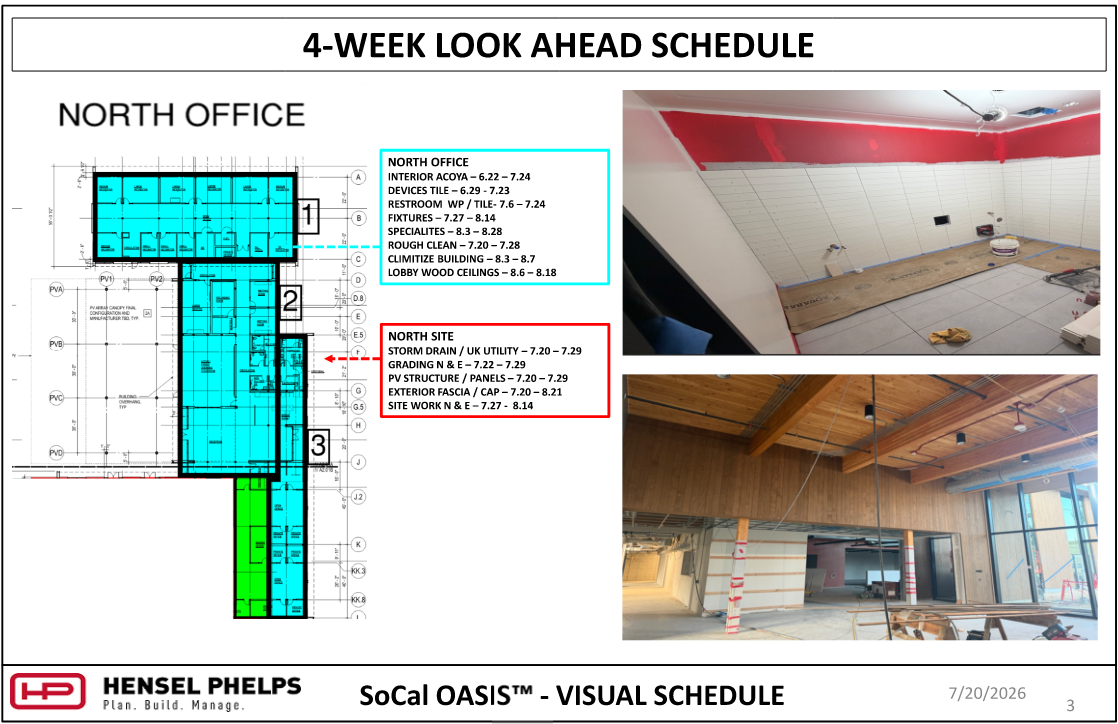

    Slide 3 of the Hensel Phelps visual schedule (July 20, 2026) highlights upcoming tasks for the "North Office" and "North Site" zones of the SoCal OASIS™ project. It pairs a color-coded floor plan and schedule callouts—covering interior finishes, tiling, fixture installation, site grading, storm drains, and PV panel setup through mid-August—with photos of a tiled room featuring a red accent wall and a lobby with exposed timber ceiling beams.

    Hensel Phelps visual schedule (July 20, 2026) highlights upcoming tasks for the "South Lab" section of the SoCal OASIS™ project. It features a floor plan with highlighted zones and a schedule for buildout tasks—including tile devices, roof screen panels, roof plaster, and startups for pumps, AHU, and chillers. There are two photos: an one of interior corridor with exposed ceiling ductwork, and a lower image showing a roll-up sectional door and adjacent glass door looking out to the construction site.
    Hensel Phelps visual schedule (July 20, 2026) displays a 3D architectural rendering for the SoCal OASIS™ project. The image shows an exterior perspective view of a modern facility featuring olive-green and grey wall paneling, glass entryway doors, rooftop mechanical equipment, and a large open bay entrance set against a clear blue sky.

    Current Week – July 20, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – N/A

    Concrete trucks

    Mid-level construction noise

    Building Site

    RPU – Irrigation Stub Out - TBD

    Low-level and mid-level construction noise

    Building Site

    Paint Testing for PV Structure

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    PV Purlins

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    North / East Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building

    Restroom Tile

    Low-level construction noise

    Building

    Interior Door Frames

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Grid Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Roof – Pump Start Up / Flush

    Low-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roof Plaster

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Re-route & Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of July 27, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    PV Purlins / Panels

    Boom Lift

    Low-level construction noise

    Building Site

    Grading North / East

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building

    Restroom Tile

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Ceilings – North & South

    ACT Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Roof Plaster

    Low-level construction noise

    Building

    Roof Mech Pipe Insulation

    Low-level construction noise

    Building

    Roof Start Up AHU’s

    Low-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of August 3, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Roof Plaster

    Low-level and Mid-level construction noise

    Building

    Chiller Start Up

    Low-level construction noise

    Building

    Restroom Specialties

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Interior Finishes - Trim

    Low-level construction noise

    Building

    Interior Wood Acclimation

    Low-level construction noise

    Building Site

    PV Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels / Fascia

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    North / East Hardscape

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

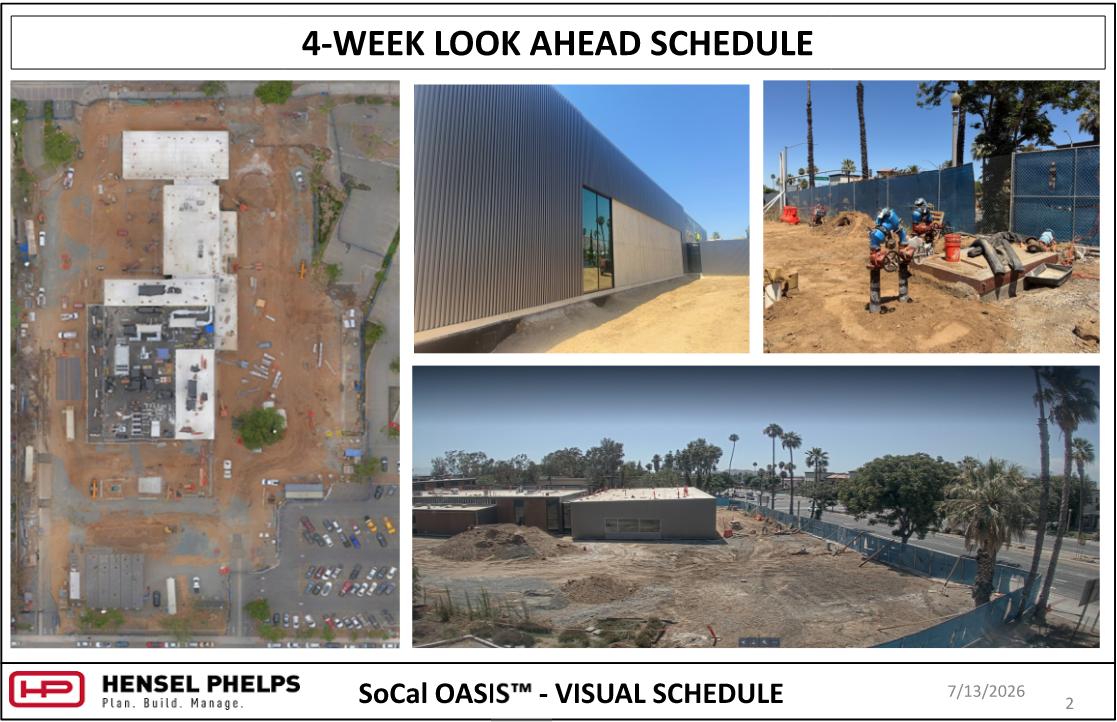

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (7/13/2026)

    An image titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps "SoCal OASIS™" project (page 2, dated July 13, 2026). It features four construction progress photos: an aerial site view, a building exterior with grey corrugated siding and a large window, outdoor blue utility piping in a dirt area, and a wide view of the construction site adjacent to a palm-tree-lined street.
    An image titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps "SoCal OASIS™" project (page 3, dated July 13, 2026). It features a highlighted floor plan of the "North Office" and scheduled tasks for interior and site work. Two interior progress photos on the right show a doorway blocked with blue painter's tape, a wood-paneled wall, and an open-concept room with concrete flooring and an exposed ceiling grid.

    An image titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps "SoCal OASIS™" project (page 4, dated July 13, 2026). It features a highlighted floor plan of the "South Lab" and a text box detailing buildout dates for tasks like starting up pumps and chillers. Two photos on the right show progress: the top displays outdoor industrial utility piping with electrical control panels, and the bottom shows an interior space featuring exposed ceiling ductwork, suspended linear lighting, and an orange wall.
    An image titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps "SoCal OASIS™" project (page 5, dated July 13, 2026). It shows a 3D digital architectural rendering of the building complex from a different angle, highlighting a grey exterior wall with roll-up doors in the foreground, detailed rooftop mechanical equipment, and solar panel arrays in the background.

    Current Week – July 13, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – N/A

    Concrete trucks

    Mid-level construction noise

    Building Site

    RPU – Irrigation Stub Out - TBD

    Low-level and mid-level construction noise

    Building Site

    Paint Testing for PV Structure

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Glazing Window Testing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    North / East Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building

    Restroom Waterproofing Testing / Tile

    Low-level construction noise

    Building

    Exterior Glazing Doors

    Scissor Lifts

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Grid Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Roof – Equipment Electrical Tie-Ins

    Low-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roof Plaster

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Re-route & Storm Drain - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of July 20, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    PV Substructure

    Boom Lift

    Low-level construction noise

    Building Site

    Grading North / East

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building

    Restroom Tile

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Ceilings – North & South

    ACT Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Roof Plaster

    Low-level construction noise

    Building

    Roof Mech Pipe Insulation

    Low-level construction noise

    Building

    Roof Start Up / Flush Pumps

    Low-level construction noise

    Building Site

    PV – Sub-Structure/ Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of July 27, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Roof Plaster

    Low-level and Mid-level construction noise

    Building

    AHU Start Up

    Low-level construction noise

    Building

    Restroom Specialties

    Low-level construction noise

    Building

    Interior Finishes – North & South

    Low-level construction noise

    Building

    Interior Finishes - Trim

    Low-level construction noise

    Building Site

    PV Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels / Fascia

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    Site Work – North Entrance

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (7/6/2026)

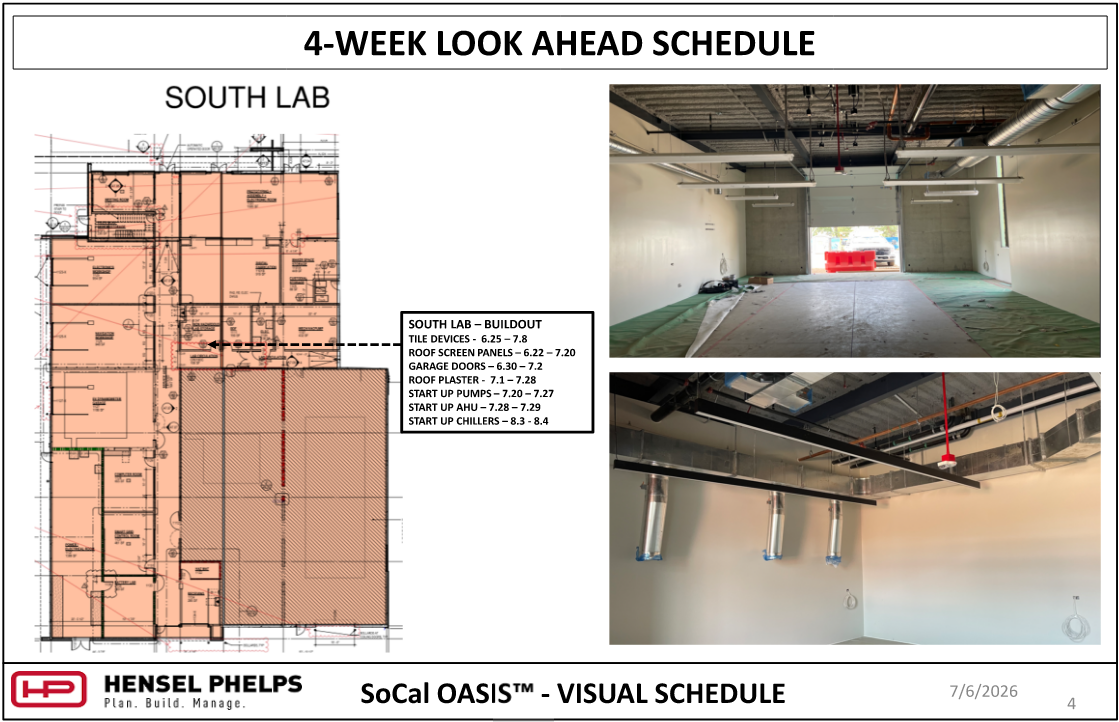

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated 6/22/2026. The slide features an aerial overhead site plan of the construction campus alongside three progress photos: an empty paved area enclosed by blue security fences and surrounded by trees, a steel frame structure over a dirt courtyard area, and a wide panoramic shot showing a crane boom arm extended next to the building's newly finished dark corrugated metal facade.
    A 4-Week Look Ahead Schedule for the North Office and North Site of the SoCal OASIS™ project, dated 7/6/2026. The slide displays a color-coded floor plan and active interior/exterior task lists alongside two construction photos: an expansive interior view highlighting newly installed, exposed wood ceiling panels and a polished concrete floor, and a second interior shot showing overhead stainless steel ductwork, utility pipes, and electrical trays routed beneath a wooden beam framework near glass windows.

    A 4-Week Look Ahead Schedule for the South Lab of the SoCal OASIS™ project, dated 7/6/2026. The slide features a highlighted floor plan and task schedule alongside two interior photos: a garage bay with its white overhead door rolled up to a construction barrier outside, and a room with an open-plenum ceiling showing exposed ductwork, piping, and hanging lights over white walls.
    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated 7/6/2026. This slide features an angled 3D BIM model rendering of the facility, showcasing its flat white roofs, dark corrugated siding, tan window framing panels, and an open dirt courtyard featuring an newly added overhead steel canopy grid structure under development.

    Current Week – July 6, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – N/A

    Concrete trucks

    Mid-level construction noise

    Building Site

    RPU – Irrigation Stub Out  - TBD

    Low-level and mid-level construction noise

    Building Site

    PV Steel Erection / Paint & PV Substructure

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    North Site –

    Domestic Water Backflow Re-Flush & Re-Chlorination Test

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    North / East Grading

    Heavy Equipment

    Low-level and mid-level construction noise

    Building

    Restroom Waterproofing

    Low-level construction noise

    Building

    Concrete Polishing Lobby

    Grinding Equipment

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Grid Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – North / South

    Scissor Lifts

    Low-level construction noise

    Building

    Roof – Equipment Electrical Tie-Ins

    Low-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior Garage Doors

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Re-route & Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

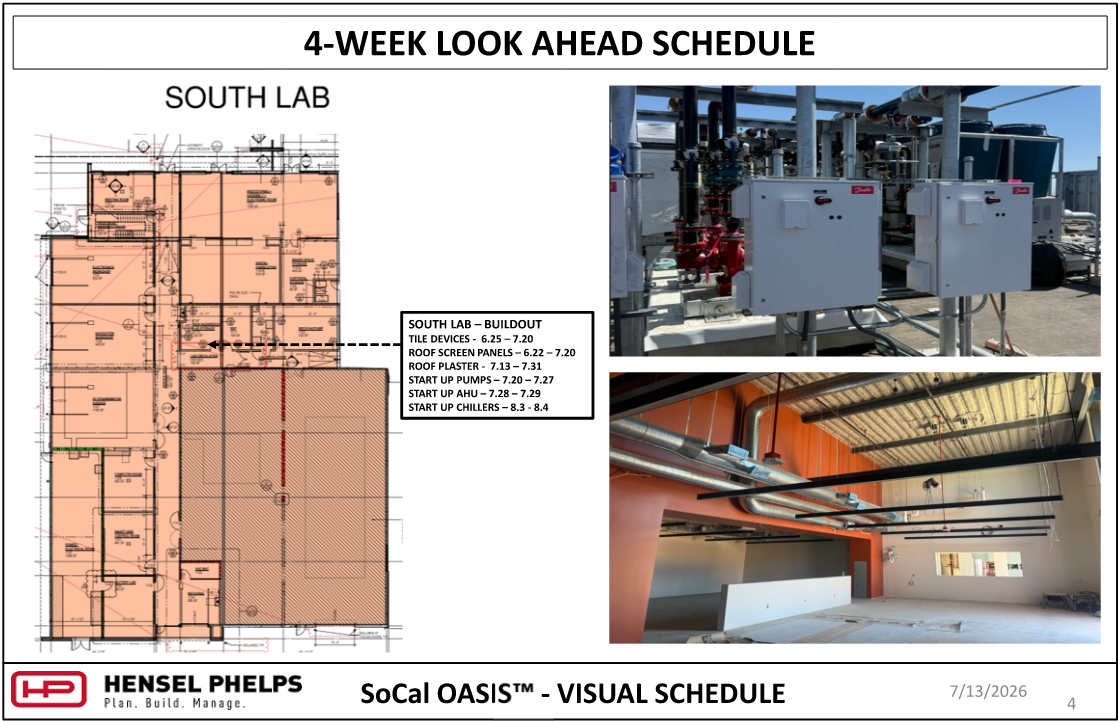

    Week of July 13, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    Window Water Testing

    Low-level construction noise

    Building

    Restroom WP / Tile

    Low-level construction noise

    Building

    Interior Finishes - Concrete Polishing

    Grinding / Polishing Equipment

    Low-level construction noise

    Building

    Interior Finishes – North

    ACT Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Tile

    Low-level construction noise

    Building

    Roof Plaster

    Low-level construction noise

    Building Site

    Grading Site North / East

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building Site

    PV – Sub-Structure/ Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

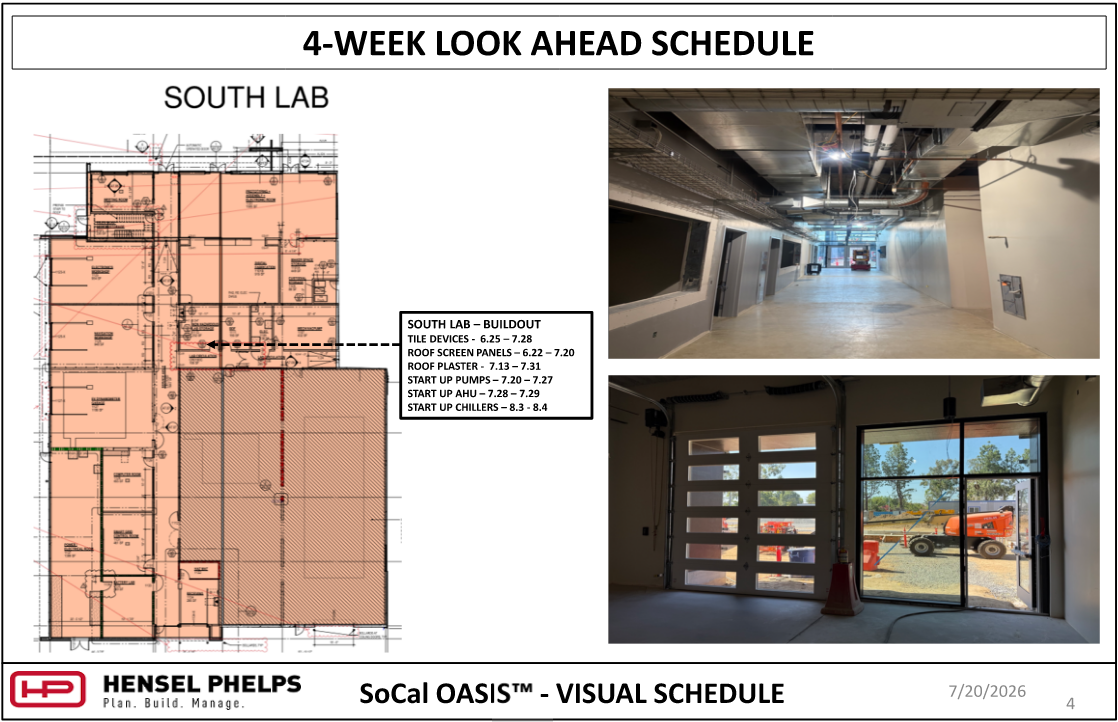

    Week of July 20, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Pumps Start Up / Flush

    Low-level construction noise

    Building

    Restroom Specialties

    Low-level construction noise

    Building

    Interior Buildout – Grid - MEP Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Roof Plaster

    Low-level construction noise

    Building Site

    PV Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (6/29/2026)

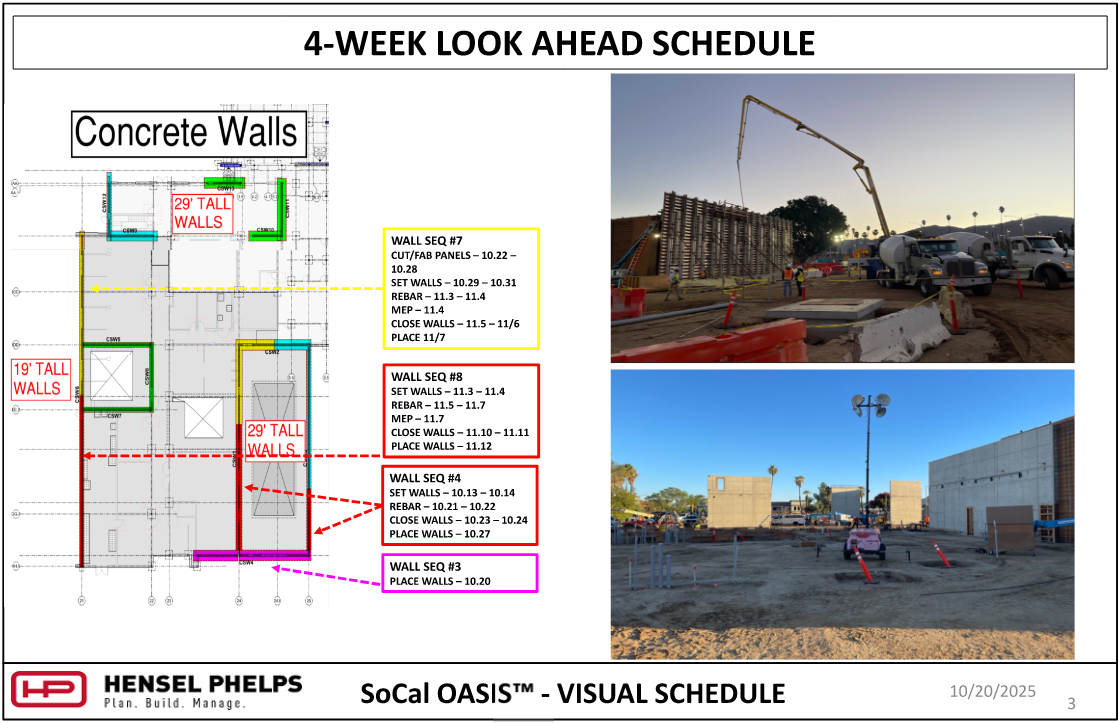

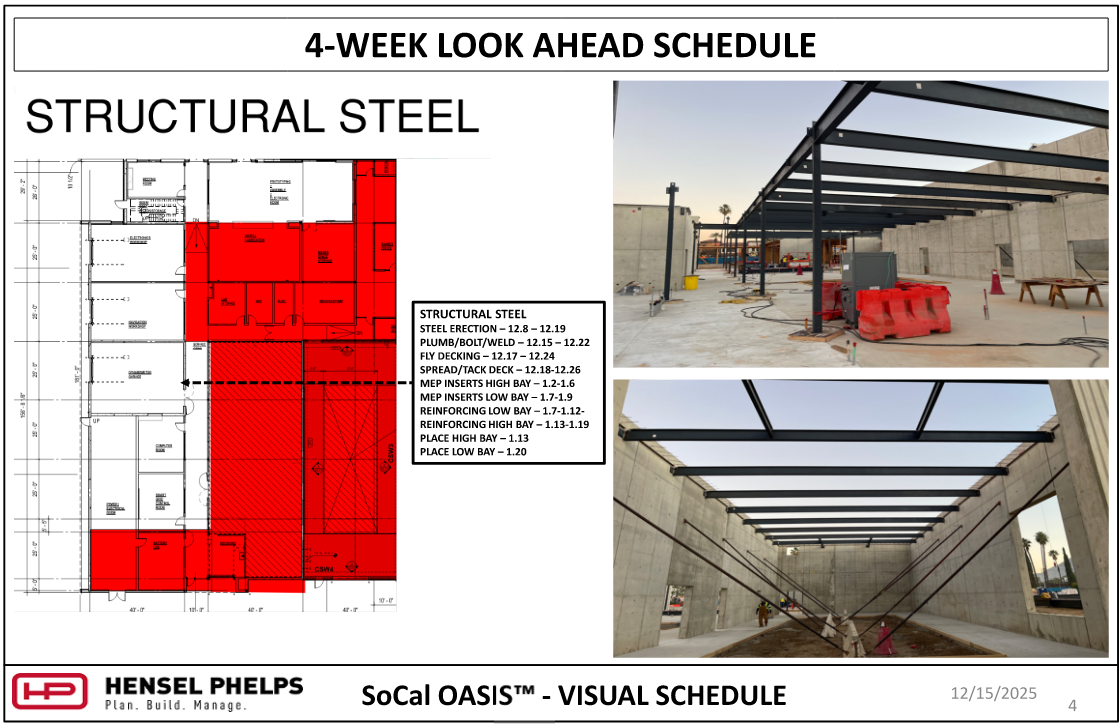

    An image titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps "SoCal OASIS™" project, dated June 26, 2026. It features four construction progress photos: an aerial site view, a steel canopy frame next to a building, an outdoor electrical transformer unit, and a wide view of the construction site with heavy machinery and surrounding palm trees.
    An image titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps "SoCal OASIS™" project (page 3, dated June 26, 2026). It shows a highlighted floor plan of the "North Office" alongside text boxes detailing schedules for interior tasks (such as floor polishing and lobby wood ceilings) and exterior "North Site" tasks (such as storm drains and PV panels). Two interior construction photos on the right showcase high wood-paneled ceilings, modern hanging light fixtures, and open-concept rooms.
    An image titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps "SoCal OASIS™" project (page 4, dated June 26, 2026). It features a highlighted floor plan of the "South Lab" and a text box detailing buildout dates for tasks like garage doors and starting up chillers. Two photos on the right show exterior progress with a boom lift installing grey corrugated siding, and interior progress featuring exposed ceiling ductwork and a bright orange accent wall.
    An image titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps "SoCal OASIS™" project (page 5, dated June 26, 2026). It shows a 3D digital architectural rendering of a modern low-rise commercial building complex with flat roofs, large glass windows, and tan and black exterior walls, situated on a simulated dirt ground surface.

    Current Week – June 29, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – 6.29 Retaining Wall Foundation

    Concrete trucks

    Mid-level construction noise

    Building Site

    RPU – Meter Set

    Low-level construction noise

    Building Site

    PV Steel Erection / Paint

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    North Site –

    Domestic Water Backflow Re-Flush & Re-Chlorination Test

    Backhoe

    Low-level and mid-level construction noise

    Building

    Concrete Polishing Lobby

    Grinding Equipment

    Low-level construction noise

    Building

    Lobby Acoya Wood

    Scissor Lifts

    Low-level construction noise

    Building

    Grid Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – South

    Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior Garage Doors

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Re-route & Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of July 6, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building

    Concrete Polishing

    Grinding / Polishing Equipment

    Low-level construction noise

    Building

    Restroom WP / Tile

    Low-level construction noise

    Building

    Interior Finishes - Concrete Polishing

    Grinding / Polishing Equipment

    Low-level construction noise

    Building

    Interior Finishes – North

    ACT Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Waterproofing / Tile

    Low-level construction noise

    Building

    Roof Plaster

    Low-level construction noise

    Building Site

    Grading Site North / East

    Heavy Equipment

    Low-level and Mid-level construction noise

    Building Site

    PV – Sub-Structure/ Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Electrical – RPU Perm Power

    Low-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of July 13, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Restroom WP / Tile

    Low-level construction noise

    Building

    Interior Buildout – Grid - MEP Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Tile

    Low-level construction noise

    Building

    Roof Plaster

    Low-level construction noise

    Building Site

    PV Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – Window Testing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Electrical – Power to Pumps

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (6/22/2026)

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated 6/22/2026. The slide features an overhead aerial site plan of the construction zone next to a parking lot, paired with three field progress photos: a parking lot area enclosed by a blue security fence under trees, an open steel structural beam canopy frame erected over a dirt ground area next to the building facade, and a wide panoramic shot showing an orange boom lift truck parked alongside the buildings corrugated panels.
    A 4-Week Look Ahead Schedule for the North Office and North Site of the SoCal OASIS™ project, dated 6/22/2026. The slide displays a color-coded floor plan with task timelines alongside two construction photos: an interior view of workers in safety vests finishing walls and prepping floors in a long hallway, and an exterior view of the finished dark corrugated metal panels and warm wood paneling on the building's facade under an overcast sky.

    A 4-Week Look Ahead Schedule for the South Lab of the SoCal OASIS™ project by Hensel Phelps, dated 6/22/2026. The slide features a highlighted floor plan diagram with a buildout task list specifying target dates for grid/device tiles, pull wire, and garage doors, alongside two field progress photos: an interior view of a room with a red scissor lift parked under an open ceiling grid showing flexible air ducts, and an outdoor view of large, commercial-grade YORK HVAC chiller

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated 6/22/2026. This slide features a 3D architectural BIM model rendering showing an aerial perspective of the facility layout. The digital model showcases a modern structure with flat roofs, dark vertical cladding on the left wing, tan panels with large blue-tinted windows along the main facade, and a courtyard featuring a row of tall structural columns intended for an overhead canopy framework un

    Current Week – June 22, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building Site

    RPU – Set Transformer / Pull Cable

    Forklift

    Low-level and mid-level construction noise

    Building Site

    PV Steel Erection

    Forklift

    Low-level and mid-level construction noise

    Building

    Concrete Polishing

    Grinding Equipment

    Low-level construction noise

    Building

    Interior Finishes – North

    Lights

    Scissor Lifts

    Low-level construction noise

    Building

    ACT Grid

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – South

    Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North

    Wood Panels / Metal Panels / Glazing

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Framing - Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior Garage Doors

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roofing – Curb Terminations

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Roof Connections

    Forklift

    Low-level and mid-level construction noise

    Building Site

    North Site –

    Domestic Water Backflow Re-Flush & Re-Chlorination Test

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Service Yard

    Retaining Wall Reinforcement

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Re-route & Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 29, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – TBD

    Concrete trucks

    Mid-level construction noise

    Building

    Concrete Polishing

    Grinding / Polishing Equipment

    Low-level construction noise

    Building

    Lights

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes - Concrete Polishing

    Grinding / Polishing Equipment

    Low-level construction noise

    Building

    Interior Finishes – North

    ACT Device Tiles

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – South

    ACT Grid

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Waterproofing / Tile

    Low-level construction noise

    Building Site

    PV – Sub-Structure Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – North

    Metal Panels / Glazing

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical – RPU Perm Power

    Low-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of July 6, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Interior Finishes North – Grid, MEP Devices, Bathroom Tile

    Polishing Equipment

    Low-level construction noise

    Building

    Interior Buildout South – Grid, MEP Devices

    Scissor Lifts

    Low-level construction noise

    Building

    Restroom Tile

    Low-level construction noise

    Building Site

    PV Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – North

    Metal Panel System, Glazing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels, Glazing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof Plaster

    Low-level and Mid-level construction noise

    Building Site

    Electrical – Power

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – North Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (6/15/2026)

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated 6/15/2026. The slide features an overhead aerial site plan of the construction campus alongside three progress photos. Exterior view of completed vertical wood paneling siding on a single-story wing, outdoor rooftop installation showing parallel utility piping arrays secured along a wall facade, a wide panoramic shot showing continuing exterior wall and paneling progress across the main facility structure.
    A 4-Week Look Ahead Schedule for the North Office and North Site sections of the SoCal OASIS™ project, dated 6/15/2026. The slide displays a color-coded floor plan with task lists alongside two construction photos: an exterior view showing dark vertical corrugated metal panels wrapping around the corner of the building facade, and an interior shot highlighting a newly polished concrete floor in a room with smooth gray drywall and a large rectangular window looking outside.

    A 4-Week Look Ahead Schedule for the South Lab of the SoCal OASIS™ project, dated 6/15/2026. The slide shows a highlighted floor plan with a task list for paint, garage doors, and roof screen panels, alongside two interior photos: a large room with an orange accent wall, exposed ceiling beams, and long metallic ventilation ducts, and a technical view of an indoor electrical room featuring an extensive bank of heavy-duty industrial circuit breakers and open power distribution panels.
    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated 6/15/2026. This slide features a 3D architectural BIM model rendering showing an aerial perspective of the building's flat white roofs, corrugated dark metal siding on the foreground wing, bright yellow panel details on the rear facade, and an unpaved courtyard layout.

    Current Week – June 15, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – Retaining Wall Foundation

    Concrete trucks

    Mid-level construction noise

    Building Site

    Exterior Painting – PV Structure

    Forklift

    Low-level construction noise

    Building Site

    PV Steel Erection

    Forklift

    Low-level and mid-level construction noise

    Building

    Concrete Polishing

    Grinding Equipment

    Low-level construction noise

    Building

    Interior Finishes – North

    Lights

    Scissor Lifts

    Low-level construction noise

    Building

    ACT Grid

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – South

    Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North

    Wood Panels / Metal Panels / Glazing

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Framing - Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior Garage Doors

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roofing – Curb Terminations

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Roof

    Forklift

    Low-level and mid-level construction noise

    Building Site

    North Site –

    Domestic Water Backflow Chlorination Testing Results

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    RPU Scheduling Power

    Forklift

    Low-level construction noise

    Building Site

    SHUT DOWN  – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    Re-route & Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 22, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building

    Concrete Polishing

    Grinding / Polishing Equipment

    Low-level construction noise

    Building

    Lights

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes - Concrete Polishing

    Grinding / Polishing Equipment

    Low-level construction noise

    Building

    Interior Finishes – North

    ACT Grid

    Scissor Lifts

    Low-level construction noise

    Building

    Interior Finishes – South

    ACT Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    PV – Sub-Structure Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – North

    Metal Panels / Glazing

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical – RPU Perm Power Scheduling

    Low-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – Demo

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 29, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building

    Interior Finishes North – Grid, MEP Devices, Bathroom Tile

    Polishing Equipment

    Low-level construction noise

    Building

    Interior Buildout South – Grid, MEP Devices

    Scissor Lifts

    Low-level construction noise

    Building Site

    PV Panel Install

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – North

    Metal Panel System, Glazing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels, Glazing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof Plaster

    Low-level and Mid-level construction noise

    Building Site

    Electrical – RPU Wire Pull / Set Transformer

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE)

    Site Work

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (6/8/2026)

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated 6/3/2026. The slide presents an overhead aerial site plan of the construction zone next to a parking lot, alongside three field progress photos: a freshly poured and leveled concrete slab foundation, workers near an exterior building facade being wrapped in dark weatherproofing material, and a wide panoramic shot showing insulation paneling installation along the main facility structure behind a blue perimeter fence.

    A 4-Week Look Ahead Schedule for the North Office and North Site of the SoCal OASIS™ project, dated 6/3/2026. The slide displays a color-coded floor plan with matching task timelines alongside two construction photos: an exterior view of thick insulation panels installed within a metal grid framework on a building facade, and an interior shot showing a black ceiling with red fire sprinkler piping, a prominent wood accent beam, and a long silver ventilation duct running above an olive-green wall.

    A 4-Week Look Ahead Schedule for the South Lab of the SoCal OASIS™ project, dated 6/3/2026. The slide features a highlighted orange floor plan with an active buildout task list alongside two progress photos: an exterior view of a single-story building facade showing window installations and yellow insulation panels, and an interior view of a gray wall with overhead wire cable trays, metal HVAC ductwork, and utility piping.
    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated 6/3/2026. This slide features an angled 3D BIM model rendering of the facility, showing flat white roofs, black and yellow-panel exterior walls with open window frames, and an open rooftop section exposing complex HVAC, ductwork, and structural layout configurations.

    Current Week – June 8, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – Retaining Wall Foundation

    Concrete trucks

    Mid-level construction noise

    Building Site

    Exterior Painting – PV Structure

    Low-level construction noise

    Building Site

    Concrete Floor Prep

    Grinding Equipment

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Restroom Lights

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North

    Wood Panels / Metal Panels / Glazing

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Framing - Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – Curb Low Bay

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Roof

    Forklift

    Low-level and mid-level construction noise

    Building Site

    North Site –

    Domestic Water Backflow Flush / Chlorination

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Electrical / IDF – Terminate

    RPU Inspection

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 15, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Floor Prep – Clean Up

    Grinding / Polishing Equipment

    Low-level construction noise

    Building Site

    PV Structure Erection

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Interior Rough Buildout – North

    ACT Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    ACT Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North

    Metal Panels / Glazing

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical – RPU Perm Power Scheduling

    Low-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 22, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Finishes North – Grid, MEP Devices, Bathroom Tile

    Polishing Equipment

    Low-level construction noise

    Building Site

    Interior Buildout South – Grid, MEP Devices

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North

    Metal Panel System, Glazing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    North Site – PV Structure Erect

    Crane

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Buildout / Wire Pull

    Scissor Lifts

    Low-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Re-route Unidentified Line

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (6/1/2026)

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated May 31, 2026. This visual summary includes an updated aerial overhead site plan of the construction campus alongside three field photos showing recent progress: workers using compacting equipment in a dirt trench, a concrete mixer truck pouring a foundation slab, and a wide shot of the building’s exterior facade showing insulation and panel installation progress behind the blue fence line.
    A 4-Week Look Ahead Schedule for the North Office and North Site of the SoCal OASIS™ project, dated May 31, 2026. The slide includes a floor plan with color-coded zones and two progress photos: an exterior view of installed vertical wood paneling and window frames along a dirt path, and an interior view showing a black painted ceiling accented by wood beams, overhead wiring, and a metal air duct.

    A 4-Week Look Ahead Schedule for the South Lab of the SoCal OASIS™ project, dated May 31, 2026. The slide features a highlighted floor plan with a task list covering structural inspections, electrical gear, and roof MEP work. Accompanying progress photos show an interior space with a bright orange accent wall, exposed ceiling joists, and hanging metallic ventilation ducts, alongside an outdoor rooftop equipment area under a blue sky featuring supporting frames and covered mechanical units.
    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated May 31, 2026. This slide features an overhead 3D BIM model rendering of the facility, showcasing progress on the single-story building's flat white roof segments, exterior wall framing, and a dirt courtyard punctuated by concrete foundation square cutouts.

    Current Week – June 1, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – Retaining Wall Foundation

    Concrete trucks

    Mid-level construction noise

    Building Site

    Exterior Painting – Steel & PV Structure

    Low-level construction noise

    Building Site

    Concrete Floor Prep

    Grinding Equipment

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Paint / Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North

    Glazing Mullions / Wood Panels / Metal Panels / Glazing

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – South

    High Bay PVC Roofing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Roof

    Forklift

    Low-level and mid-level construction noise

    Building Site

    North Site – Fire Backflow Flush

    Domestic Water Backflow Install

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Service Yard – Retaining Wall

    Low-level and mid-level construction noise

    Building Site

    Electrical / IDF – Terminate

    RPU Inspection

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 8, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Floor Prep – Clean Up

    Grinding / Polishing Equipment

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Paint / Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Paint / Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North

    Metal Panels / Glazing

    PV Structure Paint

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels Roof Screen

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical – RPU Perm Power Scheduling

    Low-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Domestic Water Flush / Chlorinate

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 15, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Finishes North – Concrete Polish

    Polishing Equipment

    Low-level construction noise

    Building Site

    Interior Buildout South – Grid, MEP Drops

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North

    Metal Panel System, Glazing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    North Site – PV Structure Erect

    Crane

    Low-level and Mid-level construction noise

    Building Site

    Exterior – South

    Metal Panels

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Buildout / Wire Pull

    Scissor Lifts

    Low-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Service Yard Retaining Wall

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Re-route Unidentified Line

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (5/26/2026)

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated May 26, 2026. This visual overview includes an aerial site plan of the construction zone next to a parking lot, alongside on-site photos showing a newly installed concrete vault hatch in a utility trench, rooftop mechanical and HVAC units, and exterior facade installation progress featuring framing and panels behind a blue construction fence.
    A 4-Week Look Ahead Schedule for the North Office section of the SoCal OASIS™ project, dated May 26, 2026. The slide features a floor plan with highlighted work zones and an updated task list including exterior flashing, wood paneling, and metal panel installations. Accompanying photos show progress on the courtyard's concrete foundations and trenches, as well as an interior view of a finished white wall with exposed overhead utility conduits and ductwork running along a wood-plank ceiling.

    A 4-Week Look Ahead Schedule for the South Lab section of the SoCal OASIS™ project, dated May 26, 2026. The slide features a floor plan with highlighted orange work zones and an active buildout task list covering drywall, electrical gear, painting, and roof MEP. Accompanying photos show interior technical progress, including open electrical equipment cabinets with complex wiring and conduits, and a freshly painted room with gray and rust-red walls beneath an exposed ceiling with overhead ductwork.

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated May 26, 2026. This slide features a 3D architectural BIM model of the building's single-story exterior facade, illustrating different stages of construction siding, panels, and window framing facing an unpaved courtyard area under a clear blue sky.

    Current Week – May 26, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – Service Yard Trash Pad – 5/29

    Concrete trucks

    Mid-level construction noise

    Building Site

    Grading – Service Yard & Backfill PV Foundations

    Backhoe

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Tape & Finish / Paint / Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Drywall / Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing / Z-Girts / Glazing Mullions / Metal Panels & Wood

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – South

    High Bay PVC Roofing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Roof

    Forklift

    Low-level and mid-level construction noise

    Building Site

    North Site – Fire Backflow

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Electrical / IDF – Buildout

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 1, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Tape & Finish / Paint / Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing,/ Metal Panels / Glazing

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical – RPU Perm Power Inspection

    Low-level construction noise

    Building Site

    Service Yard Retaining Walls

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 9, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Finishes North – Grid, MEP Drops

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Buildout South – Grid, MEP Drops

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Metal Panel System, Glazing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Buildout / Wire Pull

    Scissor Lifts

    Low-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Service Yard Retaining Wall / Curbs

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) – 6/17

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    6/17 – 2 Months

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (5/18/2026)

     A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated May 18, 2026. This visual summary includes an aerial site plan showing completed white roofing on the upper building section, alongside photos of a courtyard with foundation trenches, rooftop mechanical units, and progress on the exterior facade featuring a mix of black panels, yellow insulation, and wood-toned finishes under a cloudy sky.
     A 4-Week Look Ahead Schedule for the North Office section of the SoCal OASIS™ project, dated May 18, 2026. The slide presents a floor plan with highlighted work zones and a list of tasks such as closing drywall walls, installing exterior metal panels, and PV foundation placement. Accompanying photos show progress on the exterior facade with yellow insulation strips fitted between dark window frames, and an interior view of a large room containing stacked drywall panels and exposed overhead framing.

    A 4-Week Look Ahead Schedule for the South Lab section of the SoCal OASIS™ project, dated May 18, 2026. The slide features a floor plan with highlighted orange work zones and a buildout task list covering MEP overhead, drywall, electrical gear, and painting. Accompanying photos show interior construction progress, including a large mechanical unit with rectangular silver ductwork installed near a concrete wall ceiling, and a finished hallway with white drywall, window cutouts, and exposed overhead pipes.

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated May 18, 2026. This 3D BIM rendering showcases the building's exterior with a detailed cross-section cutout. The cutout reveals color-coded interior MEP systems—such as blue and yellow overhead ductwork—running above metal stud wall framing and support columns.

    Current Week – May 18, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – PV Foundations - 5/20 @ 5 am

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Drywall / Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Drywall / Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing / Z-Girts / Glazing Mullions / Metal Panels & Wood

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – South

    High Bay PVC Roofing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Roof

    Forklift

    Low-level and mid-level construction noise

    Building Site

    North Site – Fire Backflow

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Electrical / IDF – Buildout / Wire Pull

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of May 25, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Tape & Finish / Paint / Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing,/ Metal Panels / Glazing Mullions / Wood Panels

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF – Buildout / Wire Pull

    Low-level construction noise

    Building Site

    Service Yard Retaining Wall / Curbs

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of June 1, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Finishes North - Grid

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Buildout – South

    Paint Finishes

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Metal Panel System, Glazing, Wood Panels

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Buildout / Wire Pull

    Scissor Lifts

    Low-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Service Yard Retaining Wall / Curbs

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    TBD – 1 Week

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (5/11/2026)

     A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated May 11, 2026. This visual summary includes an aerial site view showing roofing progress and photos of the building's exterior with black vertical metal panels and yellow insulation. Additional shots highlight rooftop mechanical units and ongoing window system installation.

     A 4-Week Look Ahead Schedule for the South Lab section of the SoCal OASIS™ project, dated May 11, 2026. The slide features a floor plan with highlighted orange zones and a task list for electrical gear, drywall, and painting. Accompanying photos show an interior electrical room with large gray power panels and a view of high-ceiling construction where workers are using a scissor lift to install overhead systems.

    A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated May 11, 2026. This 3D BIM rendering shows the building's exterior from a street-level perspective, featuring dark architectural metal panels, glass windows, and rooftop mechanical enclosures. The digital model includes a realistic sky, a paved road in the foreground, and landscaping with a large tree.

    Current Week – May 11, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – N/A

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Drywall / Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Drywall / Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing / Z-Girts / Glazing Mullions / Metal Panels & Wood

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – South

    High Bay PVC Roofing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Roof

    Forklift

    Low-level and mid-level construction noise

    Building Site

    North Site – Modualar Wetland

    Fire Backflow

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Electrical / IDF – Buildout / Wire Pull

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of May 18, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Tape & Finish / Paint

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing,/ Metal Panels / Glazing Mullions / Wood Panels

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – South High Bay

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF – Buildout / Wire Pull

    Low-level construction noise

    Building Site

    Service Yard Retaining Wall / Curbs

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of May 25, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Buildout – North

    Paint / Finishes

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Buildout – South

    Paint Finishes

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Metal Panel System, Glazing, Wood Panels

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Buildout / Wire Pull

    Scissor Lifts

    Low-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Service Yard Retaining Wall / Curbs

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    TBD – 1 Week

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (5/4/2026)

    A presentation slide titled "4-WEEK LOOK AHEAD SCHEDULE" for the Hensel Phelps SoCal OASIS project, dated May 4, 2026. The slide features an aerial site map and three construction progress photos showing building exteriors, installation of black facade panels, and ground-level site work.

    A construction update slide for the North Office of the SoCal OASIS™ project. It features a color-coded floor plan and a task list including drywall, roofing, and painting scheduled through May 2026. Accompanying photos show interior drywall progress in a corridor and exterior window frame installation.
    A construction update slide for the South Lab of the SoCal OASIS™ project. It features an orange-shaded floor plan and a schedule for MEP buildout, drywall, and roof equipment through early June 2026. Supporting photos show the building's exterior facade progress and interior high-bay construction with scaffolding.

     A 3D architectural rendering for the SoCal OASIS™ project, titled "4-Week Look Ahead Schedule" and dated 5/4/2026. The image provides a top-down perspective of the building's rooftop and mechanical yard, showcasing detailed HVAC equipment, cooling towers, and complex piping systems. Significant mechanical units are color-coded in pink and grey within a walled-in enclosure.

    Current Week – May 4, 2026 (SAFETY WEEK)

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – N/A

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Drywall

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    In-Wall Inspections

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing / Z-Girts / Glazing Mullions

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – South

    High Bay PVC Roofing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Setting Roof Top Equipment – 5/6

    Crane

    Low-level and mid-level construction noise

    Building Site

    North Site – Modualar Wetland

    Re-route Unknown Utility

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Electrical / IDF - Buildout

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of May 11, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Drywall / Tape & Finish

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Drywall

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing,/ Metal Panels / Glazing Mullions

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF - Buildout

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of May 18, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout – North

    Tape & Finish

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Tape & Finish

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Metal Panel System, Glazing Mullion

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Buildout

    Scissor Lifts

    Low-level construction noise

    Building Site

    Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Service Yard Retaining Wall / Curbs

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    TBD – 1 Week

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (4/27/2026)

    Construction progress slide for the SoCal OASIS project by Hensel Phelps, dated April 27, 2026. The visual schedule includes an aerial view of the site, a close-up of underground utility trenching, and two photos of the building's exterior showing black weatherproofing and vertical metal framing in progress.

     A construction schedule slide for the "North Office" section of the SoCal OASIS project, dated April 27, 2026. It features a color-coded floor plan and a list of active tasks including branch ductwork, wall inspections, and roofing. Two interior photos show exposed metal wall framing, overhead mechanical ducting, and wood ceiling beams in progress.

     A construction schedule slide for the "South Lab" section of the SoCal OASIS project, dated April 27, 2026. It includes a highlighted floor plan and a task list covering spray acoustic insulation, MEP overhead/in-wall work, and roof equipment. Supporting photos show the building’s black exterior with a white corrugated section and an outdoor installation of horizontal black piping along a concrete wall.

     A 3D architectural rendering for the SoCal OASIS project visual schedule, dated April 27, 2026. The model depicts a modern, single-story facility with black exterior panels, wood accents, and flat white roofs. The building is shown within a simulated construction site featuring a blue Hensel Phelps perimeter fence and dirt grading.

    Current Week – April 27, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – Roof ISP Pad In-Fill

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    In-wall Completion

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    K-13 Spray / MEP OH

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing / Z-Girts / Glazing Mullions

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment Stands / MEP

    Forklift

    Low-level and mid-level construction noise

    Building Site

    North Site – Modualar Wetland

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Electrical / IDF - Buildout

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of May 4, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Prep for Wall Closure & Drywall

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Flashing,/ Z-Girts / Glazing Mullions

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment – Setting

    5/6

    Crane

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF - Buildout

    Building Site

    Exterior Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of May 11, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout – North

    Drywall

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Wall Closure Inspections

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Metal Panel System, Glazing Mullion

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Buildout

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Service Yard Curbs

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    TBD – 1 Week

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (4/20/2026)

     A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated April 20, 2026. The visual schedule features a collage of construction progress images, including an aerial view of the site, workers on a scissor lift installing interior wall panels, and exterior shots showing the building's facade and structural steel framing.

    A 4-Week Look Ahead Schedule for the North Office section of the SoCal OASIS™ project, dated April 20, 2026. This visual schedule includes a floor plan with highlighted work zones and a checklist of tasks such as roofing, exterior air barriers, and mullion installation. Accompanying photos show the building's exterior with black panels and interior shots of mechanical equipment and wall framing progress.
    A 4-Week Look Ahead Schedule for the South Lab section of the SoCal OASIS™ project, dated April 20, 2026. This slide includes a floor plan with work zones highlighted in orange and a schedule for tasks including electrical gear installation and roof equipment. Accompanying photos show a row of large electrical panels and overhead mechanical ductwork being installed within the facility.

     A 4-Week Look Ahead Schedule for the SoCal OASIS™ project by Hensel Phelps, dated April 20, 2026. This slide features a 3D BIM (Building Information Modeling) rendering of the facility, showcasing the architectural massing with gray and black exterior walls, rooftop mechanical areas with safety railings, and a single tree within a courtyard area against a digital blue sky.

    Current Week – April 20, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (7AM Start) – Roof ISP Pad In-Fill

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    In-wall Completion

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    K-13 Spray / MEP OH

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Air Barrier North / Z-Girts / Flashing

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – North & South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment Stands / MEP

    Forklift

    Low-level and mid-level construction noise

    Building Site

    East Site – Storm Drain – MH’s

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Electrical / IDF - Buildout

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of April 27, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Walls – Clean Up

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Air Barrier,/ Z-Girts / Flashing

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment - Setting

    Crane

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF - Buildout

    Building Site

    Exterior Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

    Week of April 27, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Metal Panel System, Glazing Mullion

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof MEP

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Buildout

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior Concrete - Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Exterior Concrete Sealing

    Boom Lift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    TBD – 1 Week

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (4/13/2026)

    Construction progress slide for the SoCal OASIS™ project by Hensel Phelps, dated April 13, 2026. show an updated aerial site view, installation of black exterior wall panels, and progress on the building's roof and overall envelope.

    Construction schedule slide for the North Office section of the SoCal OASIS™ project (4/13/2026). Features a floor plan diagram, a milestone list, and showing roof membrane installation and interior metal framing.
    Construction schedule slide for the South Lab section of the SoCal OASIS™ project (4/13/2026). Features a highlighted floor plan, a buildout milestone list, and showing roof insulation installation and interior overhead MEP with spray-on insulation.

    Construction schedule slide for the SoCal OASIS™ project (4/13/2026). Features an updated 3D architectural rendering of the site overview, showing building layouts, roof progress, and site logistics.

    Current Week – April 13, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Floor Sealing

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    In-wall Completion

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    K-13 Spray / MEP OH

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Air Barrier North

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment Stands

    Low-level and mid-level construction noise

    Building Site

    East Site – Storm Drain Line

    South – Sewer Service Yard

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Setting Electrical Gear

    Forklift

    Low-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Week of April 20, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Concrete Floor Sealing

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Air Barrier & Metal Panel System

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Pad Prep for Mech Equipment

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – Sewer South

    Backhoe

    Low-level construction noise

    Week of April 27, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Metal Panel System, Glazing Mullion

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roof Mechanical Equipment Setting – 4/27

    Crane

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Equipment Anchoring Equipment

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior Concrete Sealing

    Boom Lift

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    TBD – 1 Week

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (4/6/2026)

    Construction progress slide for the SoCal OASIS™ project by Hensel Phelps, dated April 5, 2026. Four images show an aerial site view, a shored utility trench, building floor framing, and an exterior with yellow weather sheathing.

    Construction schedule slide for the North Office section of the SoCal OASIS™ project (4/5/2026). Features a floor plan diagram, a list of upcoming construction milestones, and two photos showing exterior sheathing and interior metal stud framing.
    Gemini said Construction schedule slide for the South Lab section of the SoCal OASIS™ project (4/5/2026). Features a highlighted floor plan, a list of buildout milestones, and two photos showing interior metal framing and drywall progress.

    Gemini said Construction schedule slide for the SoCal OASIS™ project (4/5/2026). Features a 3D architectural rendering of the site overview, showing building layouts, perimeter fencing, and the surrounding parking areas.

    Current Week – April 6, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    In-wall Completion

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    MEP OH

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Air Barrier North

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Equipment Stands

    Low-level and mid-level construction noise

    Building Site

    East Site – Storm Drain Line

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Parking

    (ENTRANCE CLOSURE) - TBD

    Week of April 13, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Air Barrier & Metal Panel System

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Setting Electrical Equipment

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – Sewer South

    Backhoe

    Low-level construction noise

    Week of April 20, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Metal Panel System, Glazing Mullion

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – PVC

    Prep Rooftop Equipment

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Electrical / IDF Equipment

    Scissor Lifts

    Low-level construction noise

    Building Site

    Site Utilities – Sewer South

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    TBD – 1 Week

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (3/30/2026)

    Current Week – March 30, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Duct Work

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Top-Down Drywall

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Air Barrier Starting North

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    East Site – Storm Drain Line

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – East Site

    (ENTRANCE OPEN)

    Week of April 6, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Air Barrier

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Storm Drain

    Backhoe

    Low-level construction noise

    Week of April 13, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Air Barrier / Flasing

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – Sewer South

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    TBD – 1 Week

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (3/23/2026)

    Current Week – March 23, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Wood Blocking

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Duct Work

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Top-Down Drywall

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Place Sidewalk University Ave. – 3/24

    Traffic Control

    Low-level construction noise

    Building Site

    Site Utilities – East Site

    (ENTRANCE CLOSER) – Spring Break

    Backhoe

    Air Vacuum Truck

    Low-level construction noise

    Week of March 30, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane South

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Storm Drain East Site

    Backhoe

    Low-level construction noise

    Week of April 6, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – East Site Storm Drain & Sewer South

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    3.23.26 – 3.27.26

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

    Thank you,

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (3/16/2026)

    Current Week – March 16, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Wood Blocking

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Duct Work

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Top-Down Drywall

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – North Storm Drain Tie-in

    Backhoe

    Bore Machine

    Low-level construction noise

    Week of March 23, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North / South

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – East Site

    (ENTRANCE CLOSER) – Spring Break

    Backhoe

    Low-level construction noise

    Week of March 30, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roofing – North & South – Torched applied Membrane

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – East Site Storm Drain

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    3.23.26 – 3.27.26

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • 3/9/2026 - 950604 UCR SoCal OASIS™ Park – Construction Progress Update #62

    Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (3/9/2026)

    Current Week – March 9, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Added Beams

    Forklift, Scissor Lifts

    Low-level and Mid-level construction noise

    Building Site

    Mass Timber Shear Walls Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Duct Work

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout – South

    Top-Down Drywall

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Fire Water & Storm Drain East

    Backhoe

    Bore Machine

    Low-level construction noise

    Entrance Closed

    Week of March 16, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Mass Timber Shear Wall Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – East Storm Drain

    Backhoe

    Bore Machine

    Low-level construction noise

    Week of March 23, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior – North/South

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – East Site

    (ENTRANCE CLOSER) – Spring Break

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    3.23.26 – 3.27.26

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  •

    Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (3/2/2026)

    Current Week – March 2, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – South Low Bay Roof Pads – 3/6/26

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Added Beams

    Forklift, Scissor Lifts

    Low-level and Mid-level construction noise

    Building Site

    Mass Timber Shear Walls Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout – North

    Duct Work Starting

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Start

    (ENTRANCE CLOSED) 3/2-3/4

    Backhoe

    Bore Machine

    Low-level construction noise

    Entrance Closed

    Week of March 9, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Added Beams from Inside

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Wall Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – East Side of Project

    Backhoe

    Bore Machine

    Low-level construction noise

    Week of March 16, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – East Site

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    3.2.26 – 3.4.26 3.23.26 – 3.27.26

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (2/23/2026)

    Current Week – February 23, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Added Beams

    Forklift, Scissor Lifts

    Low-level and Mid-level construction noise

    Building Site

    Mass Timber Shear Walls Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – North Prep

    Backhoe

    Low-level construction noise

    Week of March 2, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Roof Pads – 3/6

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Added Beams from Inside

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Wall Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities – Lot 50 Entrance

    (ENTRANCE CLOSED) 3/2-3/4

    Backhoe

    Low-level construction noise

    Week of March 9, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – East Site

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    3.2.26 – 3.4.26 3.23.26 – 3.27.26

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (2/16/2026)

    Current Week – February 16, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – High Bay Deck Placement – 2/20/26

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift, Scissor Lifts

    Low-level and Mid-level construction noise

    Building Site

    Mass Timber Shear Walls Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detailing

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing – High Bay

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing – North – Rain Dependent

    Forklift

    Low-level and mid-level construction noise

    Week of February 23, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Added Beams from Inside

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Wall Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lift

    Low-level and Mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Site Utilities - North

    Backhoe

    Low-level construction noise

    Week of March 2, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - South

    Scissor Lifts

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Roofing - North

    Forklift

    Low-level and Mid-level construction noise

    Building Site

    Site Utilities – North Lot 50 Entrance (ENTRANCE CLOSED) 3/2-3/4

    Backhoe

    Low-level and Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    3.2.26 – 3.4.26 3.23.26 – 3.27.26

    Lot 50 & 51 Entrance will be located on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (2/9/2026)

    Current Week – February 9, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – High Bay Deck Placement – 3/10/26

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift, Scissor Lifts

    Low-level and Mid-level construction noise

    Building Site

    Mass Timber Shear Walls Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detailing

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing – High Bay

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Roofing - North

    Low-level construction noise

    Week of February 16, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Low Bay Deck Placement – 3/17/26

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Wall Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Welding Machines

    Mid-level construction noise

    Building Site

    Roof Reinforcing – Low Bay

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lift

    Low-level and mid-level construction noise

    Building Site

    Roofing - North

    Low-level construction noise

    Week of February 23, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Non-Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Beams

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Building Site

    Exterior - North

    Boom Lifts

    Low-level and Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    3.2.26 – 3.4.26 3.23.26 – 3.27.26

    Lot 50 & 51 Entrance will be on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (2/2/2026)

    oasis2-2-262.png (

    Current Week – February 2, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5 AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detailing

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of February 9, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – High Bay Deck Placement – 3/10/26

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Wall Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of February 16, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Low Bay Deck Placement – 3/17/26

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    Lot 50 & 51 – Entrance Closer

    North Entrance at University Ave.

    3.2.26 – 3.4.26 3.23.26 – 3.27.26

    Lot 50 & 51 Entrance will be on Everton Pl.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (1/26/2026)

    Current Week – January 26, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5 AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Concrete Cleaning

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detailing

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of February 2, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Wall Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of February 9, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – High Bay Deck Placement – 2/10

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (1/19/2026)

    Current Week – January 19, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5 AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Concrete Cleaning

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detailing

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of December 26, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – High Bay Deck Placement – 1/30

    Concrete trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Wall Detailing

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of February 2, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Low Bay Deck Placement – 2/6

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Below Grade Waterproofing

    Low-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Metal Decking – Detail

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (1/12/2026)

    Current Week – January 12, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5 AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detailing

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of December 19, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of January 26, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – High Bay – 1.27 / Low Bay – 1/29

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Metal Decking – Detail

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (1/5/2026)

    Current Week – January 5, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5 AM Start) – Pad Placement 1.7.26

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detailing

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of December 12, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – High Bay Roof Placement – 1.13

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Detailing

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Welding Machines

    Mid-level construction noise

    Building Site

    MEPF Deck Inserts

    Low-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of January 19, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – Low Bay Roof Placement – 1.22

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Metal Decking – Detail

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Roof Reinforcing

    Scissor Lifts

    Low-level and mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • lease be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (12/22/2025)

    Current Week – December 22, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (11AM Start) – 12/19 Placement – Dyno Slab, Steel Beam Encl.

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Delivery / Erection

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Spread & Tack

    Welding Machines

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of December 29, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Erection

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Detail

    Welding Machines

    Mid-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

    Week of January 5, 2026

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Metal Decking – Detail

    Forklift

    Low-level and mid-level construction noise

    Building Site

    MEP Deck Inserts - Lab

    Low-level construction noise

    Building Site

    Interior Rough Buildout - North

    Scissor Lifts

    Low-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (12/15/2025)

    Current Week – December 15, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Delivery / Erection

    Trucks, Forklift, 90T Crane

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Spread & Tack

    Mid-level construction noise

    Week of December 22, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Erection

    Trucks, Forklift 90T Crane

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Spread & Tack

    Mid-level construction noise

    Week of December 29, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete Trucks

    Mid-level construction noise

    Building Site

    Shear Wall Cleaning

    Boom Lift

    Low-level construction noise

    Building Site

    Structural Steel Erection

    90T Crane, Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Shear Walls

    Scissor Lifts, Forklift

    Low-level and mid-level construction noise

    Building Site

    Metal Decking – Spread & Tack

    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (12/8/2025)

    Current Week – December 8, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities – Clean Up / Strip

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Wall De-Fabricate – Break Down Panels

    90T Crane, Forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel Delivery / Erection

    Trucks, Forklift, 90T Crane

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Erection

    Trucks, Scissor Lifts

    110T Crane

    Mid-level construction noise

    Week of December 15, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Wall Clean Activities

    Boom Lift

    Low-level

    Building Site

    Wall De-Fabrication

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel Erection

    Trucks, Forklift 90T Crane

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Erection

    Scissor Lifts

    110T Crane

    Mid-level construction noise

    Week of December 22, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Wall Clean Activities

    Boom Lift

    Low-level

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel

    90T Crane, Forklift

    Mid-level construction noise

    Building Site

    Mass Timber Erection

    Scissor Lifts

    110T Crane

    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (12/1/2025)

    Current Week – December 1, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities – Clean Up / Strip

    Forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction – Break Down Panels

    90T Crane, Forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel Delivery / Erection

    Trucks, Forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Erection

    Trucks, Scissor Lifts

    110T Crane

    Mid-level construction noise

    Week of December 8, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Wall Clean Activities

    Boom Lift

    Low-level

    Building Site

    Wall De-Fabrication

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel Erection

    Trucks, Forklift 90T Crane

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Erection

    Scissor Lifts

    110T Crane

    Mid-level construction noise

    Week of December 15, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Wall Clean Activities

    Boom Lift

    Low-level

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel

    90T Crane, Forklift

    Mid-level construction noise

    Building Site

    Mass Timber Erection

    Scissor Lifts

    110T Crane

    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (11/24/2025)

    Current Week – November 24, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, Forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, Forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel Delivery

    Trucks, forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Erection

    Trucks, Scissor Lifts

    110T Crane

    Mid-level construction noise

    Week of December 1, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Wall Clean Activities

    Boom Lift

    Low-level

    Building Site

    Wall De-Fabrication

    Forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel

    Trucks, Forklift 90T Crane

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Erection

    Scissor Lifts

    110T Crane

    Mid-level construction noise

    Week of December 8, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Wall Clean Activities

    Boom Lift

    Low-level

    Building Site

    Concrete Placement (5AM Start) – None Scheduled

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel

    90T Crane, Forklift

    Mid-level construction noise

    Building Site

    Mass Timber Erection

    Scissor Lifts

    110T Crane

    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (11/17/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Misc. Steel

    Trucks, forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Delivery / Erection

    Trucks, Scissor Lifts

    110T Crane

    Mid-level construction noise

    Week of November 24, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Misc. Steel

    Trucks, forklift

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Erection

    Scissor Lifts

    110T Crane

    Mid-level construction noise

    Week of December 1, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Wall Clean Activities

    Boom lift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel

    90T Crane, forklift Trucks

    Mid-level construction noise

    Building Site

    Mass Timber Erection

    Scissor Lifts

    110T Crane

    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (11/10/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Misc. Steel

    Trucks

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Delivery / Erection

    Trucks, Boom Lift

    110T Crane

    Mid-level construction noise

    Week of November 17, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Misc. Steel

    Trucks

    Low-level and mid-level construction noise

    Building Site

    Mass Timber Delivery / Erection

    Trucks, Boom Lift

    110T Crane

    Mid-level construction noise

    Week of November 24, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Structural Steel

    90T Crane, forklift Trucks

    Mid-level construction noise

    Building Site

    Mass Timber Delivery / Erection

    Trucks, Boom Lift

    110T Crane

    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (11/3/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Misc. Steel

    Loader, Trucks

    Low-level and mid-level construction noise

    Week of November 10, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Mass Timber Delivery / Erection

    Trucks, Boom Lift

    110T Crane

    Mid-level construction noise

    Week of November 17, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Mass Timber Delivery / Erection

    Trucks, Boom Lift

    110T Crane

    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (10/27/2025)

    oasis10-27-251

    oasis10-27-252

    oasis10-27-253

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Dirt Stockpile Removal

    Loader, Trucks

    Mid-level construction noise

    Week of November 3, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Misc Steel

    Boom Lift

    Low-level and mid-level construction noise

    Week of November 10, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Mass Timber Delivery / Erection

    Trucks, Boom Lift

    110T Crane

    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (10/20/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of October 27, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Misc Steel

    Boom Lift

    Low-level and mid-level construction noise

    Week of November 3, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    Misc. Steel

    Boom Lift

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Look-Ahead (10/13/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of October 20, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of October 27, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (10/06/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of October 13, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of October 20, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (09/29/2025)

    oasis10-3-251

    oasis10-3-252

    oasis10-3-253
    oasis10-3-254

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of October 6, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of October 13, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (09/22/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of September 29, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of October 6, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG Activities

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (09/15/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG MEP

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of September 22, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG MEP

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of September 29, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG MEP

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 4 Week Visual Look-Ahead (09/8/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Footing construction

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG Utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of September 15, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG MEP UG

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG Utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Week of September 22, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    SOG MEP UG

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG Utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (09/2/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Footing construction

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of September 8, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Week of September 15, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    CIP wall construction

    90T Crane, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (5AM Start)

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (08/25/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Construction trailer - HP & UCR move-in

    Forklift

    Low-level construction noise

    Building Site

    Footing construction

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (8/28) - Start time= 5AM

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of September 2, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement (9/5) - Start time= 5AM

    Concrete trucks

    Mid-level construction noise

    Building Site

    Cast-in-Place wall construction

    80 ton crane, forklift

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Week of September 8, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe, dump truck

    Low-level and mid-level construction noise

    Building Site

    Cast-in-Place wall construction

    80 ton crane, forklift

    Mid-level construction noise

    Building Site

    Concrete Placement (9/11 & 9/12) - Start time= 5AM

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (08/18/2025)

     Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Construction trailer delivery & setup (including construction of deck/ramp/stairs)

    Forklift

    Low-level construction noise

    Building Site

    Footing construction

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of August 25, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Week of September 2, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe, dump truck

    Low-level and mid-level construction noise

    Building Site

    Cast-in-Place wall construction

    80 ton crane, forklift

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (08/11/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Construction trailer delivery & setup (including construction of deck/ramp/stairs)

    Forklift, semi-trucks

    Low-level construction noise

    Building Site

    Footing construction

    Backhoe, forklift

    Low-level and mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex, dump truck

    Low-level and mid-level construction noise

    Week of August 18, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe

    Low-level and mid-level construction noise

    Building Site

    Concrete Placement

    Concrete trucks

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Week of August 25, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe, dump truck

    Low-level and mid-level construction noise

    Building Site

    Cast-in-Place wall construction

    80 ton crane, forklift

    Mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (08/04/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Preparation for temporary power

    Backhoe, roller

    Low-level construction noise

    Building Site

    Construction trailer delivery & setup (including construction of deck/ramp/stairs)

    Forklift, semi-trucks

    Low-level construction noise

    Building Site

    Footing excavation

    Backhoe

    Low-level and mid-level construction noise

    Week of August 11, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe, dump truck

    Low-level and mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Week of August 18, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe, dump truck

    Low-level and mid-level construction noise

    Building Site

    UG utility installation

    Mini-Ex

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • SOCAL OASIS™ Park: 3 Week Look-Ahead (07/21/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Backfill of the temp & permanent power underground

    Backhoe, roller

    Low-level and mid-level construction noise

    Building Site

    Crushed base at trailer complex

    Skip loader

    Low-level construction noise

    Week of August 04, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Construction trailer delivery & setup (including construction of deck/ramp/stairs)

    Forklift, semi-trucks

    Low-level construction noise

    Week of August 11, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Foundation construction

    Backhoe, dump truck

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

     **No upcoming or anticipated closures.

     Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (07/21/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Over excavation and re-compaction

    Scrapers, bulldozer, skip loader, water truck

    Low-level and mid-level construction noise

    Building Site

    Temp & permanent power underground

    Backhoe

    Low-level construction noise

    Week of July 28, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Temp power setup

    Forklift

    Low-level construction noise

    Week of August 4, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Construction trailer delivery & setup (including construction of deck/ramp/stairs)

    Semi-truck

    Low-level and mid-level construction noise

    Building Site

    Foundation construction

    Backhoe, dump truck

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (07/07/2025)

                                                                   Current Week

                                                            Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site
    Over excavation and re-compaction
    Belly dumps, scrapers, bulldozers, water truck
    Low-level and mid-level construction noise
    Building Site
    Underground pipe removal
    Mini-excavator
    Low-level construction noise

                                                                                    Week of July 14, 2025

                                                                     Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site
    Over excavation and re-compaction
    Belly dumps, scrapers, bulldozers, water truck
    Mid-level construction noise

                                                                    Week of July 21, 2025

                                                                   Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site
    Over excavation and re-compaction
    Belly dumps, scrapers, bulldozers, water truck
    Mid-level construction noise

     Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

     **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (06/30/2025)

    Socal Oasis construction

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Over excavation and re-compaction

    Belly dumps, scrapers, bulldozers, water truck

    Mid-level construction noise

    Week of July 7, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Over excavation and re-compaction

    Belly dumps, scrapers, bulldozers, water truck

    Mid-level construction noise

    Week of July 14, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Over excavation and re-compaction

    Belly dumps, scrapers, bulldozers, water truck

    Mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **July 4, 2025, the Project Site will be closed.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Processing & haul-off of demolition debris.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    Demobilization of demolition equipment

    Generator, Excavator, Skid Steer

    Low-level construction noise

    Building Site

    Over excavation and re-compaction

    Belly dumps, scrapers, bulldozers, water truck

    Low-level and mid-level construction noise

    Week of June 30, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Over excavation and re-compaction

    Belly dumps, scrapers, bulldozers, water truck

    Mid-level construction noise

    Week of June 28, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Over excavation and re-compaction

    Belly dumps, scrapers, bulldozers, water truck

    Mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Processing & haul-off of demolition debris.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    East Building- demolition, processing & haul-off of slab-on-grade and foundations.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    Existing Site UG utility removal

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Week of June 23, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Processing & haul-off of demolition debris.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    Demobilization of demolition equipment

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    Over excavation and re-compaction

    Belly Dump, scrapers, bulldozers.

    Mid-level construction noise

    Week of June 28, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Over excavation and re-compaction

    Belly Dump, scrapers, bulldozers.

    Mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Processing & haul-off of demolition debris.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    East Building- demolition, processing & haul-off of slab-on-grade and foundations.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    Site asphalt removal

    Asphalt milling machine

    Mid-level and high-level construction noise

    Week of June 16, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Slab-on-grade and foundation demolition

    Generator, Excavator, Skid Steer

    Mid-level and high-level construction noise

    Building Site

    North Building- Processing & haul-off of demolition debris.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Week of June 23, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Slab-on-grade and foundation demolition

    Generator, Excavator, Skid Steer

    Mid-level and high-level construction noise

    Building Site

    Demobilization of demolition equipment

    Generator, Excavators, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    Mobilization of earthwork equipment

    Belly Dump, scrapers, bulldozers.

    Low-level and mid-level construction noise

    Building Site

    Over excavation and re-compaction

    Belly Dump, scrapers, bulldozers.

    Mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Processing & haul-off of demolition debris.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Week of June 9, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Slab-on-grade and foundation demolition

    Generator, Excavator, Skid Steer

    Mid-level and high-level construction noise

    Building Site

    North Building- Processing & haul-off of demolition debris.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Building Site

    Site asphalt removal

    Asphalt milling machine

    Mid-level and high-level construction noise

    Week of June 16, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Slab-on-grade and foundation demolition

    Generator, Excavator, Skid Steer

    Mid-level and high-level construction noise

    Building Site

    North Building- Processing & haul-off of demolition debris.

    Generator, Excavator, Skid Steer

    Low-level and mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Interior Soft Demolition and Abatement

    Generator, forklift, Skid Steer,

    Low-level Construction Noise

    Building Site

    East Building- Structure demolition, Processing & Haul-off

    Excavators

    Mid-level and High-Level Construction Noise

    Week of May 12, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site
    North Building- Structure Demolition
    Generator, forklift, skid steer
    Mid-level and High-Level Construction Noise

    Building Site

    East Building- Foundation Demolition, Processing & Haul-off.

    Excavators, Skid Steers

    Mid-level and High-Level Construction Noise

    Week of May 19, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site
    North Building- Structure Demolition
    Generator, forklift, skid steer
    Mid-level and High-Level Construction Noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building- Interior Soft Demolition and Abatement

    Generator, forklift, Skid Steer,

    Low-level Construction Noise

    Building Site

    South Building- Foundation demolition, Processing, Haul-off & Backfill

    Excavators

    Mid-level and High-Level Construction Noise

    Week of April 28, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    East Building- Structure Demolition

    Excavators, Skid Steers

    Mid-level and High-Level Construction Noise

    Week of May 5, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North Building- Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    East Building- Structure Demolition, Processing and Haul-off

    Excavators, Skid Steers

    Mid-level and High-Level Construction Noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building- Interior Soft Demolition and Abatement

    Generator, forklift, Skid Steer,

    Low-level Construction Noise

    Building Site

    South Building- Foundation demolition, Processing & Haul-off

    Excavators

    Mid-level and High-Level Construction Noise

    Week of April 21, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building- Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    South Building- Foundation demolition, Processing & Haul-off

    Excavators, Skid Steers

    Mid-level and High-Level Construction Noise

    Week of April 28, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building- Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    East Building- Exterior Facade Demolition and Structure Demolition

    Excavators, Skid Steers

    Mid-level and High-Level Construction Noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building- Interior Soft Demolition and Abatement

    Generator, forklift, Skid Steer,

    Low-level Construction Noise

    Building Site

    South Building- Foundation demolition, Processing & Haul-off

    Excavators

    Mid-level and High-Level Construction Noise

    Week of April 14, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building- Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    South Building- Processing & Haul-off

    Excavators, Skid Steers

    Mid-level and High-Level Construction Noise

    Week of April 21, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building- Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    East Building- Preparation for structure demolition

    Excavators, Skid Steers

    Mid-level and High-Level Construction Noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building Interior Soft Demolition and Abatement

    Generator, forklift, Skid Steer,

    Low-level Construction Noise

    Building Site

    South Building Exterior Facade & Structure Demolition

    High-reach Excavator

    Mid-level and High-Level Construction Noise

    Week of March 31, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    South Building Structure Demolition and processing of demolished debris

    High-reach Excavator, Skid Steers

    Mid-level and High-Level Construction Noise

    Week of April 7, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    North / East Building Interior Soft Demolition and Abatement

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    South Building Structure Demolition and processing of demolished debris

    High-reach Excavator, Skid Steers

    Mid-level and High-Level Construction Noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the SoCal OASIS™ Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the contractor will access the Project Site as shown in the map below:

    UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (03/17/2025)

     Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, Skid Steer,

    Low-level Construction Noise

    Building Site

    South Building Exterior Facade Demolition

    High-reach Excavator

    Mid-level Construction Noise

    Week of March 24, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    South Building Exterior Facade Demolition & Structure Demolition

    High-reach Excavator, Skid Steers

    Mid-level and High-Level Construction Noise

    Week of March 31, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, skid steer

    Low-level Construction Noise

    Building Site

    South Building Structure Demolition

    High-reach Excavator, Skid Steers

    Mid-level and High-Level Construction Noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, Skid Steer

    Low-level construction noise

    Week of March 17, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, skid steer

    Low-level construction noise

    Week of March 24, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, skid steer

    Low-level construction noise

    Building Site

    Structure Demolition

    Excavator, skid steersMedium/High-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  •

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, Skid Steer

    Low-level construction noise

    Week of March 10, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, skid steer

    Low-level construction noise

     Week of March 17, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, skid steer

    Low-level construction noise

    Building Site

    Structure Demolition

    Excavator, skid steers

    Medium/High-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, Skid Steer

    Low-level construction noise

    Building Site

    Re-mobilization of demolition equipment

    Excavators, 53' transport trucks

    Low/medium-level construction noise

    Week of March 3, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, skid steer

    Low-level construction noise

    Week of March 10, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Fireproofing & Drywall Abatement

    Soft Demolition Activities

    Generator, forklift, skid steer

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Mastic, fireproofing & PCB abatement

    Generator, forklift

    Low-level construction noise

    Week of February 24, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Mastic, fireproofing & PCB abatement

    Generator, forklift

    Low-level construction noise

    Building Site

    Re-mobilization of demolition crew

    Generator, forklift

    Low-level construction noise

    Week of March 3, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Mastic, fireproofing & PCB abatement

    Generator, forklift

    Low-level construction noise

    Building Site

    Interior demolition activities

    Generator, Skid steer, forklift

    Mid-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

     **No upcoming or anticipated closures.

     Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (north building interiors)

    Generator, forklift

    Low-level construction noise

    Building Site

    Mastic & penetration abatement

    Generator, forklift, floor buffer

    Low-level construction noise

    Week of February 17, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Interior soft demolition & remaining trash out of existing furniture

    Generator, forklift

    Low-level construction noise

    Building Site

    PCB abatement & window removal

    Generator, forklift Low-level construction noise

    Week of February 24, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    PCB abatement & window removal

    Generator, forklift

    Generator, forklift

    Building Site

    Abatement containment setup

    Generator, forkliftGenerator, forklift

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

     Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

     The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (north building interiors)

    Generator, forklift

    Low-level construction noise

    Week of February 10, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (north building interiors)

    Generator, forklift

    Low-level construction noise

    Building SiteStart Contract Scope Abatement in South & East BuildingsGenerator, forklift & skid steerLow-level construction noise

    Week of February 17, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Contract Scope Abatement in South & East Buildings

    Generator, forklift

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (01/20/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, forklift

    Low-level construction noise

    Week of January 27, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, forklift

    Low-level construction noise

     Week of February 3, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, skid steer

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • UCR – SoCal OASIS™ Park: 3 Week Look-Ahead (01/06/2025)

    Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, forklift

    Low-level construction noise

      Week of January 13, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, forklift

    Low-level construction noise

     Week of January 20, 2025

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, skid steer

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

     Please contact John Franklin with any specific questions or concerns at john.franklin@ucr.edu

    The SoCal OASIS™ Park Construction Team recognizes that construction activities will at times pose inconveniences and disruption to the surrounding neighborhood and parking at Lots 50 & 51. We thank you in advance for your patience during construction of this project.

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors) – if approved by AQMD

    Generator, skid steer

    Low-level construction noise

     Week of December 16, 2024

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)  - if approved by AQMD

    Generator, skid steer

    Low-level construction noise

     Week of December 23, 2024

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, skid steer

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact Daneca Stevens with any specific questions or concerns at daneca.stevens@ucr.edu

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Building Site

    Hauling of demolished material from parking structure

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Building Site

    P5 Pre-Abatement clean-up (building interiors) – if approved by AQMD

    Generator, skid steer

    Low-level construction noise

     Week of December 9, 2024

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, skid steer

    Low-level construction noise

     Week of December 16, 2024

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    P5 Pre-Abatement clean-up (building interiors)

    Generator, skid steer

    Low-level construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact Daneca Stevens with any specific questions or concerns at daneca.stevens@ucr.edu

  • Current Week

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Building Site

    Hauling of demolished material from parking structure

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Building Site

    11/28/24 – Thanksgiving – Jobsite Closed

    N/A

    N/A

    Building Site

    11/29/2024 – Jobsite Closed

    N/A

    N/A

     Week of December 2, 2024

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Building Site

    Hauling of demolished material from parking structure

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Week of December 9, 2024

    Construction Activities

    Location

    Activity

    Equipment Used

    Anticipated Disturbance

    Building Site

    Processing & haul off parking structure demolished materials

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction noise

    Building Site

    P5 Pre-Abatement Prep & Cleanup

    N/A

    None

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

     Please contact Daneca Stevens with any specific questions or concerns at daneca.stevens@ucr.edu

  •

    Current week

    Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Building Site

    Hauling of demolished material from parking structure

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

     Week of November 25, 2024

    Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Building Site

    Hauling of demolished material from parking structure

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

     Week of December 2, 2024

    Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    Processing & haul off parking structure demolished materials

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

     Please contact Daneca Stevens with any specific questions or concerns at daneca.stevens@ucr.edu

  • Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    Project Sign Installation

    N/A

    N/A

    Building Site

    Demolition of existing landscaping & trees (clear & grub)

    High-level excavator, bobcat, hand tools

    Medium-level Construction

    noise

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Week of November 18, 2024

    Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    Processing & haul off of parking structure demolished materials

    High-level excavator, bobcat, hand tools

    Medium-level Construction noise

    Week of November 25, 2024

    Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    Processing & haul off of parking structure demolished materials

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact Daneca Stevens with any specific questions or concerns at daneca.stevens@ucr.edu

  • Please be advised that the following activities will be occurring during the weeks/dates noted below at the OASIS Park project site and surrounding areas during regular construction work hours (7am to 5pm) unless otherwise indicated below. The activities will occur within the areas identified and the Project Site as shown in the map below:

    UCR – OASIS: 3 Week Look-ahead (11/04/2024)

    Current week

    Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    AQMD P-5 assessment

    N/A

    N/A

    Building Site

    Mobilization activities

    Forklift

    Low-level construction noise

    Building Site

    Demolition of existing landscaping & trees (clear & grub)

    High-level excavator, bobcat, hand tools

    Medium-level Construction

    noise

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction

    noise

    Week of November 11, 2024

    Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    Demolition of existing landscaping & trees (clear & grub)

    High-level excavator, bobcat, hand tools

    Medium-level Construction noise

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction noise

    Week of November 18, 2024

    Construction Activities

    Location

    Activity

    Equipment

    Used

    Anticipated

    Disturbance

    Building Site

    Demolition of parking structure on south side of site (adjacent to Everton Place)

    High-level excavator, bobcats, dust boss

    Medium/high-level Construction noise

    Current and Upcoming Anticipated Closures

    The following shutdown(s)/ closures are anticipated as indicated below. Updates to this schedule will be released weekly in the Project Construction Advisories until the work is complete.

    Description

    Location

    Duration & Date

    Impacted Buildings/ Facilities

    N/A

    N/A

    N/A

    N/A

    **No upcoming or anticipated closures.

    Please contact Daneca Stevens, Project Manager, with any specific questions or concerns at  daneca.stevens@ucr.edu

Project Timeline:

Anticipated Start:
Notice to Proceed, Phase 1: Feb 2024

Construction Start:
October 2024

Anticipated Completion:
Spring 2027

PD&C Contact:

Project Manager: Jonathan Chung, PE
tel: (562) 298-6254

Project Planner: Stephanie Tang
tel: (951) 827-1484

Project Working Group:

Rosibel Ochoa, VCRED, Chair
David Dayton, UNEX
Don Collins, BCOE
Linda Walling, AS PRC
Matt Barth, BCOE
Nathaniel Gabor, CNAS
Nicole Cleary, VCRED

Project Basis of Design:

Miller Hull

Architect:

ZGF Architects

GC:

Hensel Phelps Construction, Co.

Cameras:

Live Camera 1

Signup for construction updates on this project

CLICK HERE
